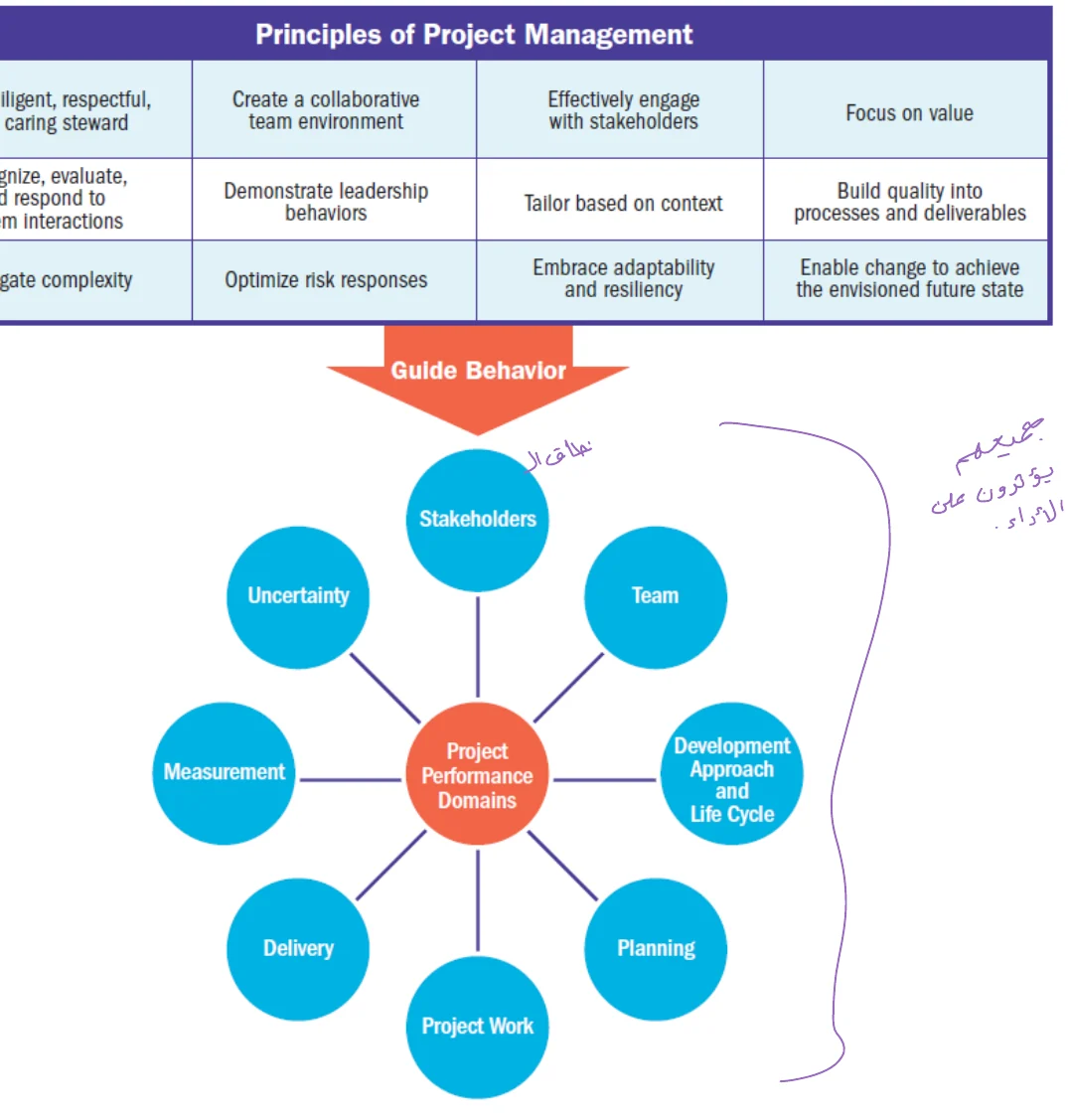

- Chapter 1 gave the 8 domain names. This deck opens each one.
- Domain number badges (1–8) in the top corner of each title slide help you keep the order.
Top right: “All the principles we covered are the guided behaviors which are the project performance domain.” Arrows from the domains with an Arabic note: “all of them run together”.
- Definition to memorize: a group of related activities that are critical for effective delivery of project outcomes.
- Concurrent = all 8 at the same time, not one after another. This is the exact trap in the real MCQ.
Asked in a real exam
Seen again
🎯 How this can come up · 2 questions
Which statement best describes project performance domains?
Correct: Interactive, interdependent areas of focus that run concurrently.
Performance domains apply only when value is delivered at the end of the project.
False. They run concurrently regardless of how value is delivered: frequently, periodically or at the end.

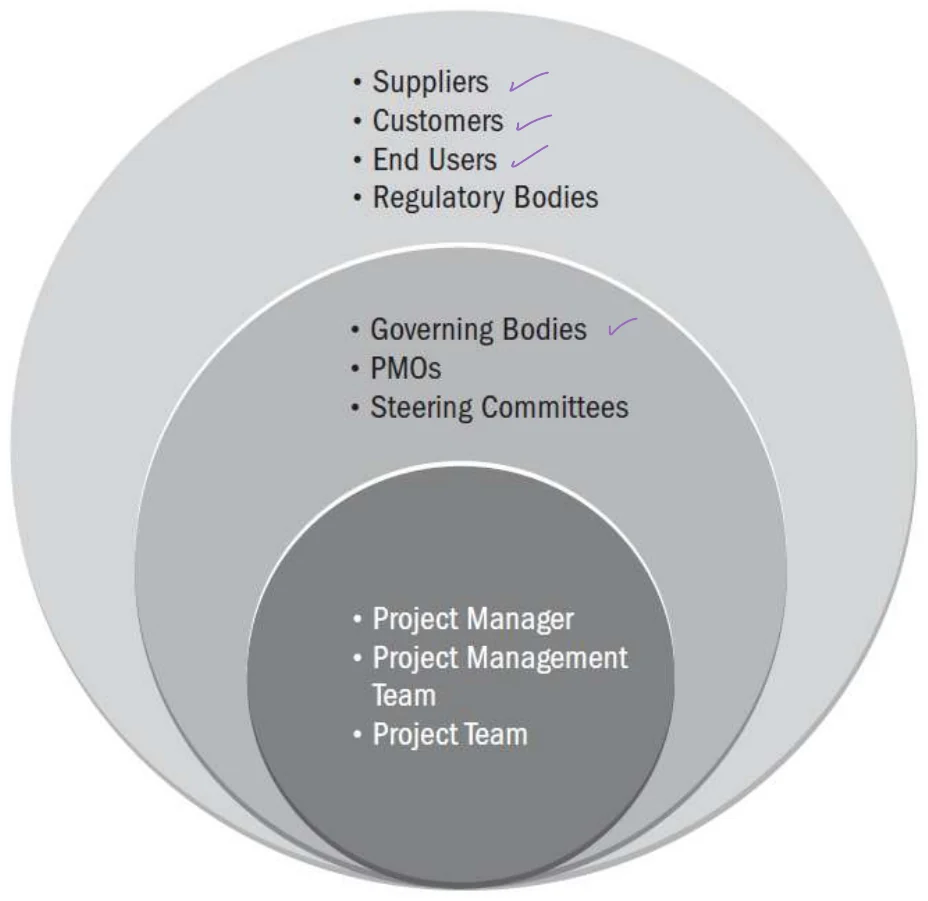

Ticks next to suppliers, customers, end users and governing bodies. “Stakeholder analysis” is glossed in Arabic (تحليل المستفيدين).
- Three ways to be a stakeholder: you affect it, you are affected by it, or you only THINK you are affected. All three count.
- Stakeholder analysis covers supporters, opponents and neutral people, both internal and external.
Related real-exam questions
Seen again
🎯 How this can come up · 2 questions
A person who only believes they will be affected by a project is still a stakeholder.
True. The definition includes those who “perceive itself to be affected”.
For the Edugate scheduling app (a real midterm case), name three stakeholder groups and place each in the circles diagram.
Inner: the project team and project manager. Middle: PSU governing bodies or the IT steering committee. Outer: students and advisors (end users and customers). Each group shapes requirements: students on usability, advisors on rules, IT on integration with Edugate.
- Soft skills beat technical skills when dealing with stakeholders.
🎯 How this can come up · 1 question

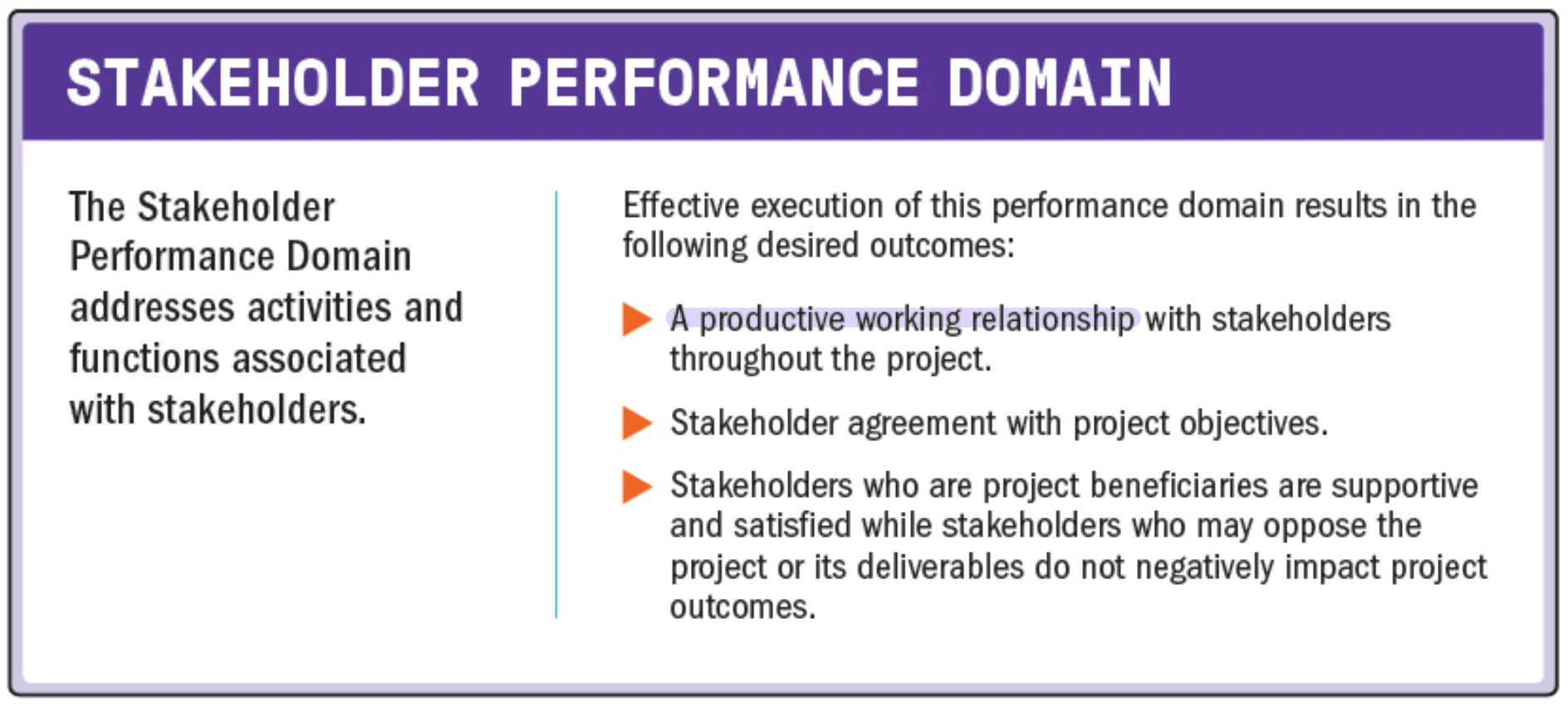

Which is a desired outcome of the stakeholder performance domain?

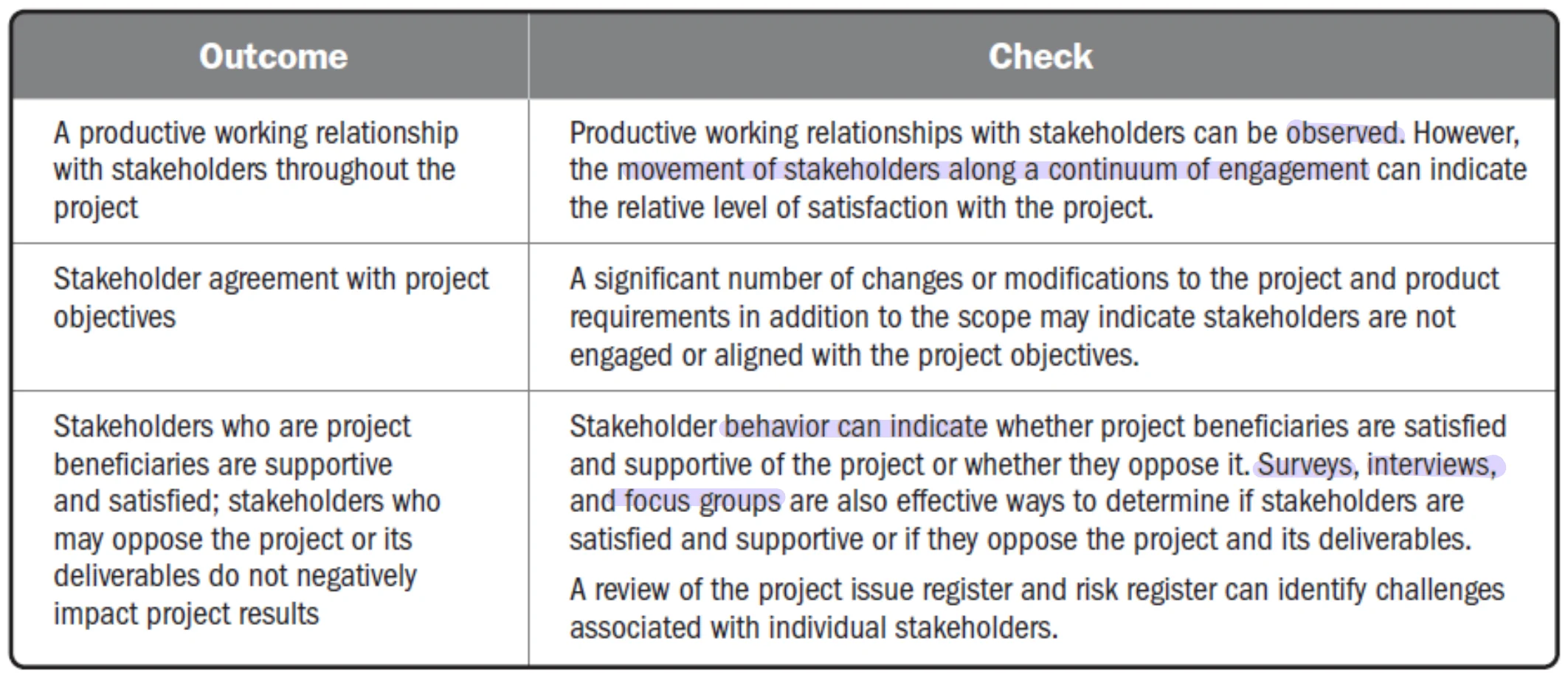

Correct: A productive working relationship with stakeholders throughout the project.
- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.
Under the card: “Stakeholders → Team”, linking domain 1 to domain 2.

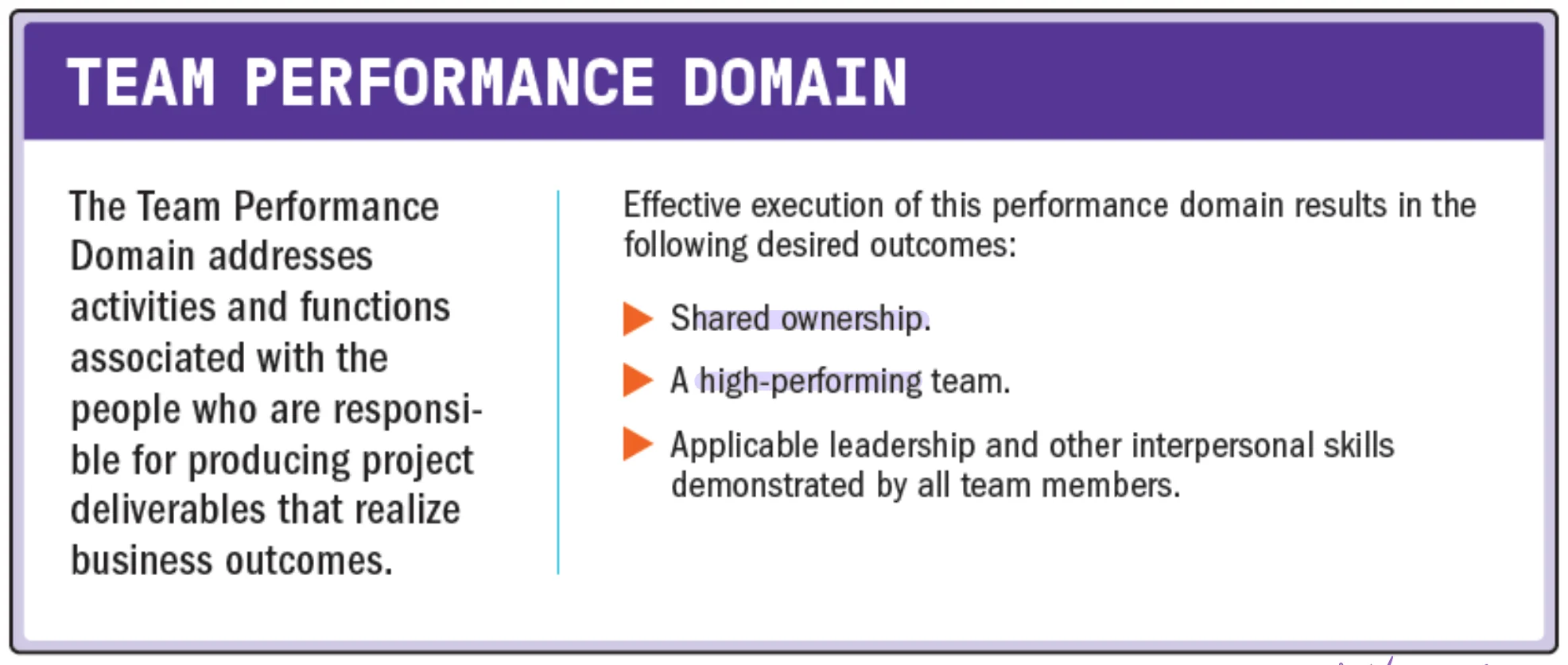

- Three outcomes: shared ownership · high performance · everyone shows leadership.
- Management = processes (plan, coordinate, measure). Leadership = people (influence, motivate, listen). You need both.
🎯 How this can come up · 1 question
Influencing, motivating and listening are examples of which activities?
Correct: Leadership activities.
- Centralized: accountability (being answerable for an outcome) sits with ONE person, usually the PM.
- The project charter is the document that authorizes the PM to form the team.
Asked in a real exam
🎯 How this can come up · 1 question
In a centralized environment, accountability is usually:
Correct: Assigned to one individual such as the project manager.
- Distributed: no designated PM, and someone acts as a facilitator (think Scrum master).
- The facilitator role can rotate.
Asked in a real exam
🎯 How this can come up · 1 question
In distributed management, the facilitator role can shift among project team members.
True.

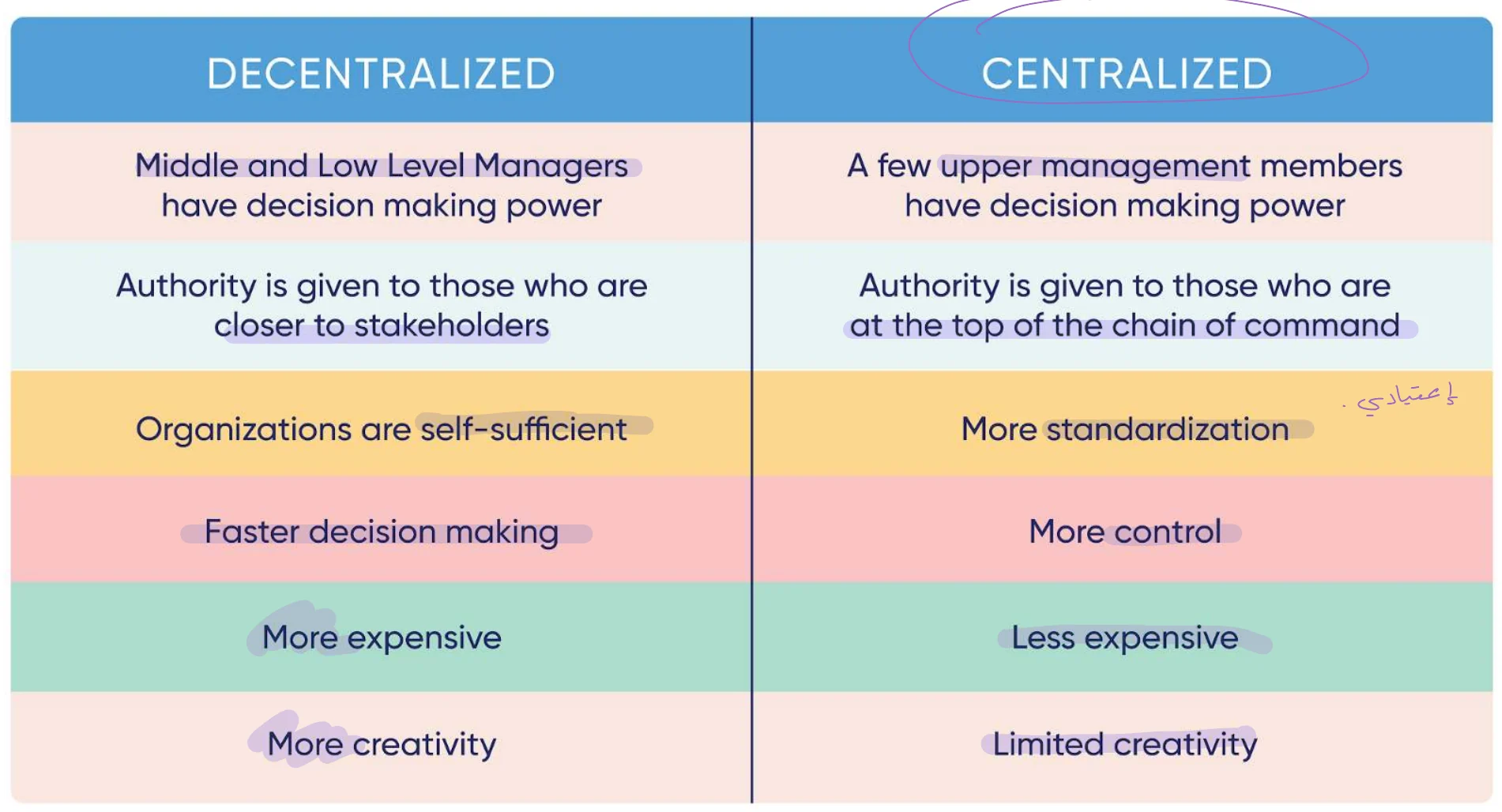

“Centralized” circled; nearly every cell highlighted; Arabic gloss “اعتيادي” (routine) next to “more standardization”.
- Learn it as three opposite pairs: speed vs. control · cost (decentralized costs MORE) · creativity vs. standardization.
Asked in a real exam
🎯 How this can come up · 2 questions
Which is a characteristic of DECENTRALIZED management according to the table?
Correct: Faster decision making but more expensive.
In decentralized project management, decision-making authority is primarily:
The real midterm wording.
- Five aspects: Vision, Roles, Operations, Guidance, Growth.
- Team culture can be designed (team norms) or can just emerge from behavior. Either way it sits inside the organization’s culture.
- The PM builds culture by modeling: Transparency, Integrity, Respect, Positive discourse, Support, Courage, Celebrating success.
Related real-exam questions
🎯 How this can come up · 1 question
Which is NOT listed as a behavior the PM should model to build team culture?
Correct: Micromanagement.
- Nine factors: Open communication, Shared understanding, Shared ownership, Trust, Collaboration, Adaptability, Resilience, Empowerment, Recognition.
Related real-exam questions
🎯 How this can come up · 1 question
What are the key characteristics of a good (high-performing) team?
Open communication and shared understanding of goals; shared ownership of the work; trust between members; real collaboration; adaptability and resilience when things change; empowerment to make decisions; and recognition of contributions. Together these let the team self-correct and deliver.
- Four leadership skills: Vision, Critical thinking, Motivation, Interpersonal skills.
🎯 How this can come up · 1 question
Which of these is NOT one of the four leadership skills on the slide?
Correct: Budget forecasting.

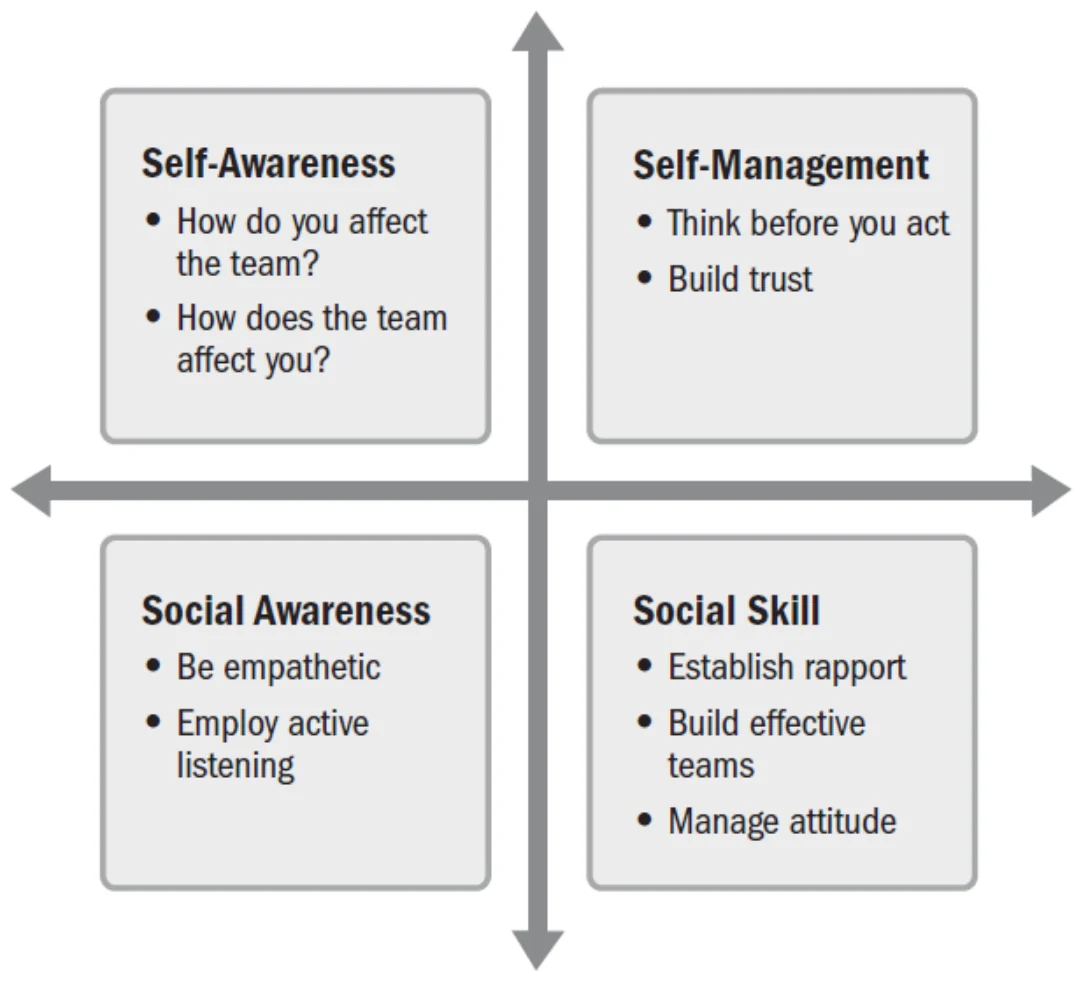

- Two about you (self-awareness, self-management) and two about others (social awareness, social skill).
🎯 How this can come up · 1 question
“Be empathetic” and “employ active listening” belong to which EI component?
Correct: Social awareness.
- Leadership style depends on: experience with this type of project, team maturity, governance structure, and whether the team is distributed.
Related real-exam questions
🎯 How this can come up · 1 question
Your team is very senior and spread across three countries. How should that affect your leadership style?
Tailor it: a mature, experienced team suits a less directive, more delegating or servant style, and a distributed team needs more deliberate communication and clear governance. The slide lists team maturity and distributed teams as variables that influence the choice.
- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.

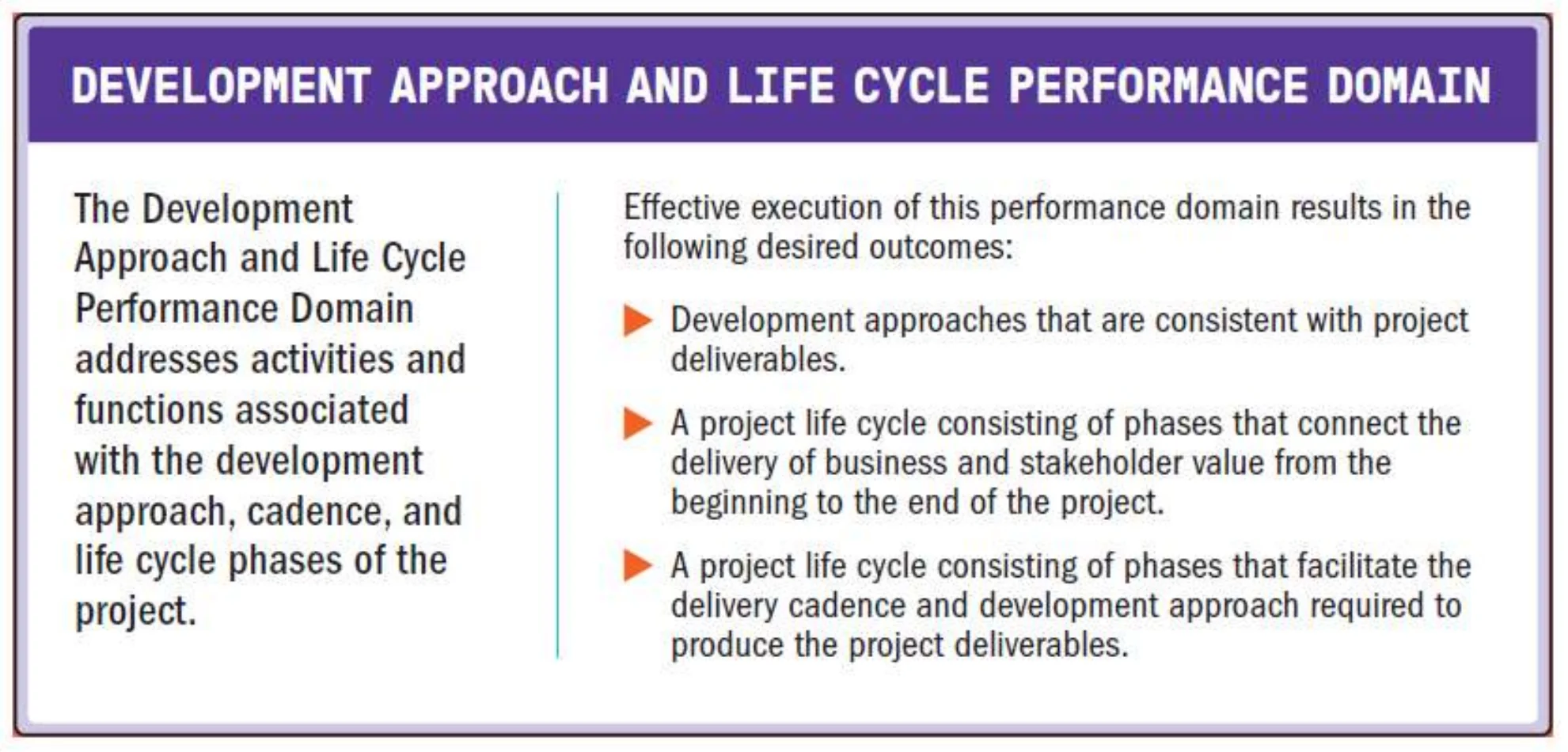

- Outcomes: approaches consistent with deliverables, a life cycle that delivers value from start to end, and phases that support the cadence.
- Cadence = rhythm of activities. This word was its own midterm MCQ.
- Phase = related activities ending in deliverables. Life cycle = all the phases from start to finish.
Asked in a real exam
🎯 How this can come up · 1 question
“A rhythm of activities conducted throughout the project” defines:
Correct: Cadence.
- The chain: deliverable type → development approach → cadence → life cycle and phases.
- Delivery cadence = WHEN and HOW OFTEN you deliver: single, multiple or periodic.
Asked in a real exam
🎯 How this can come up · 1 question
In project management, what is the primary purpose of establishing a project cadence?
The real midterm question.
- Continuous delivery = ship small increments immediately, using automation. It belongs to DevOps (Chapter 4).
Seen again
🎯 How this can come up · 1 question
Continuous delivery means delivering the whole product once at the end of the project.
False. It delivers feature increments immediately, in small batches.

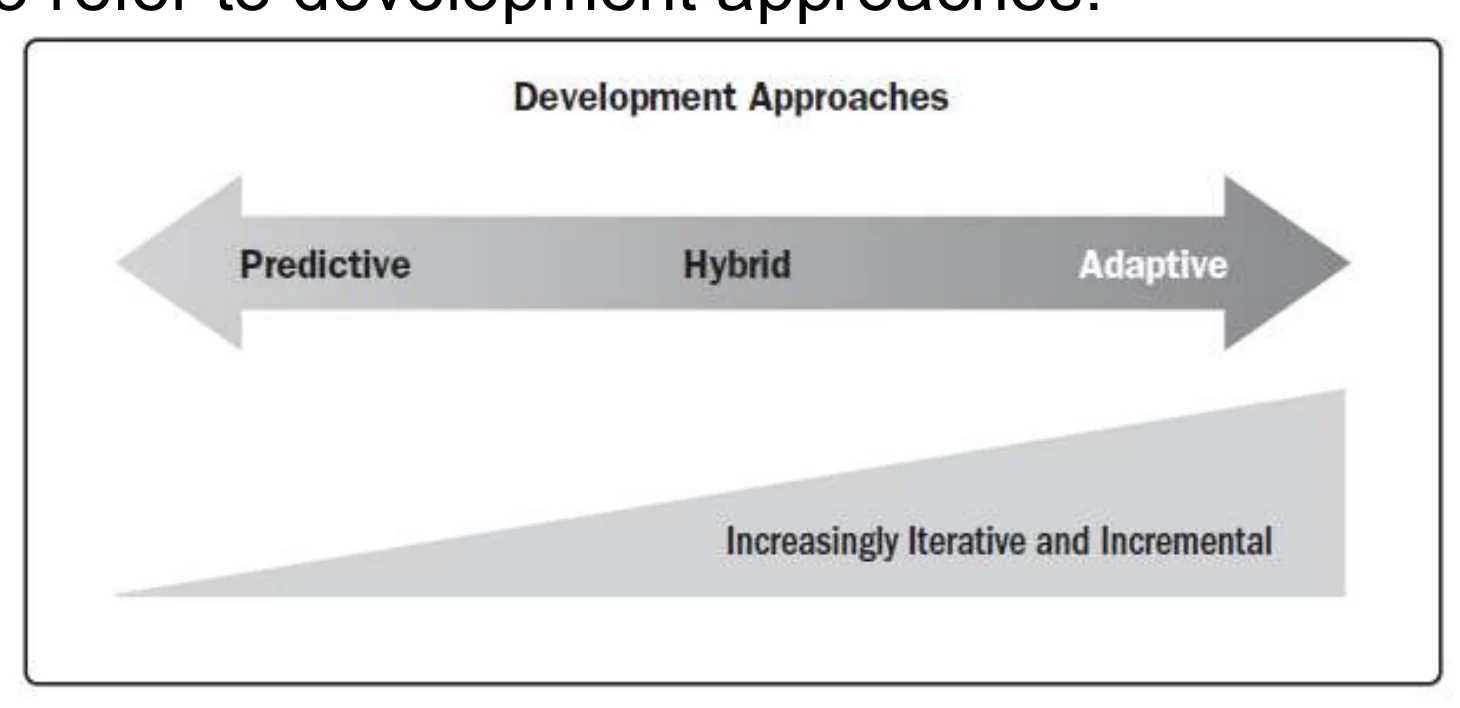

- It is a spectrum, not three boxes. The further right you go, the more iterative and incremental.
- Predictive = waterfall. Use it when requirements are known up front and stable.
- Also used for big investment and high risk, with reviews and change control between phases.
🎯 How this can come up · 1 question
A government payroll system has fixed legal requirements that will not change. Which approach fits and why?
Predictive (waterfall): the requirements can be defined at the start and are stable, so most of the planning can be done up front.
- Hybrid when some parts are certain and some are not, or when modules can go to different teams.
Related real-exam questions
🎯 How this can come up · 1 question
The Edugate app (real midterm case) must integrate with fixed IT rules but student usability needs keep evolving. Which approach would you recommend?
Hybrid. Use predictive planning for the fixed integration and IT-rule parts and adaptive iterations for the student-facing features that evolve with feedback.

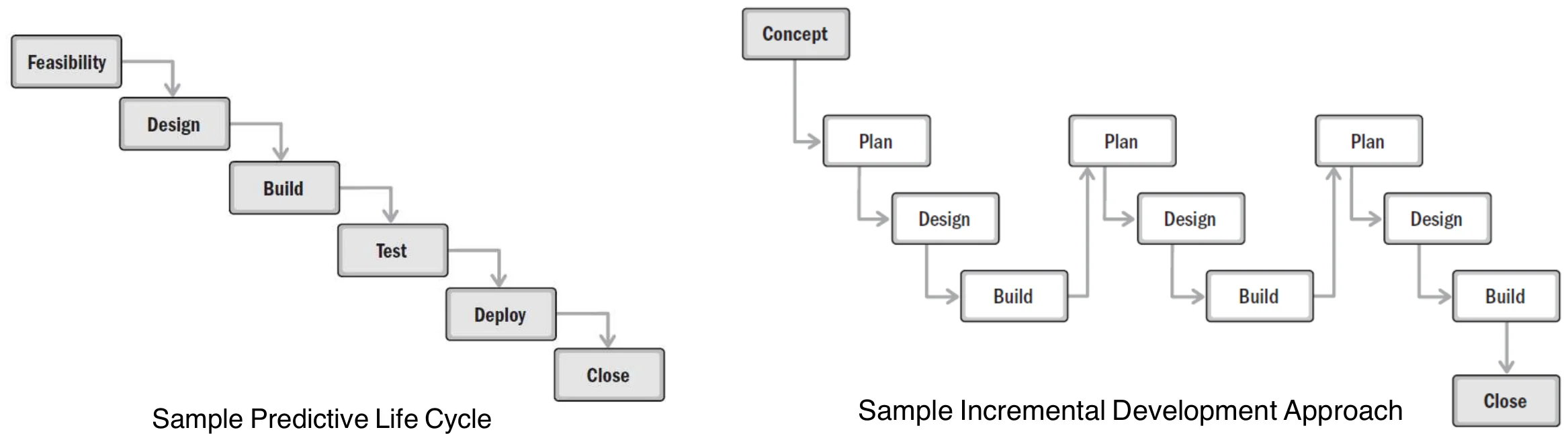

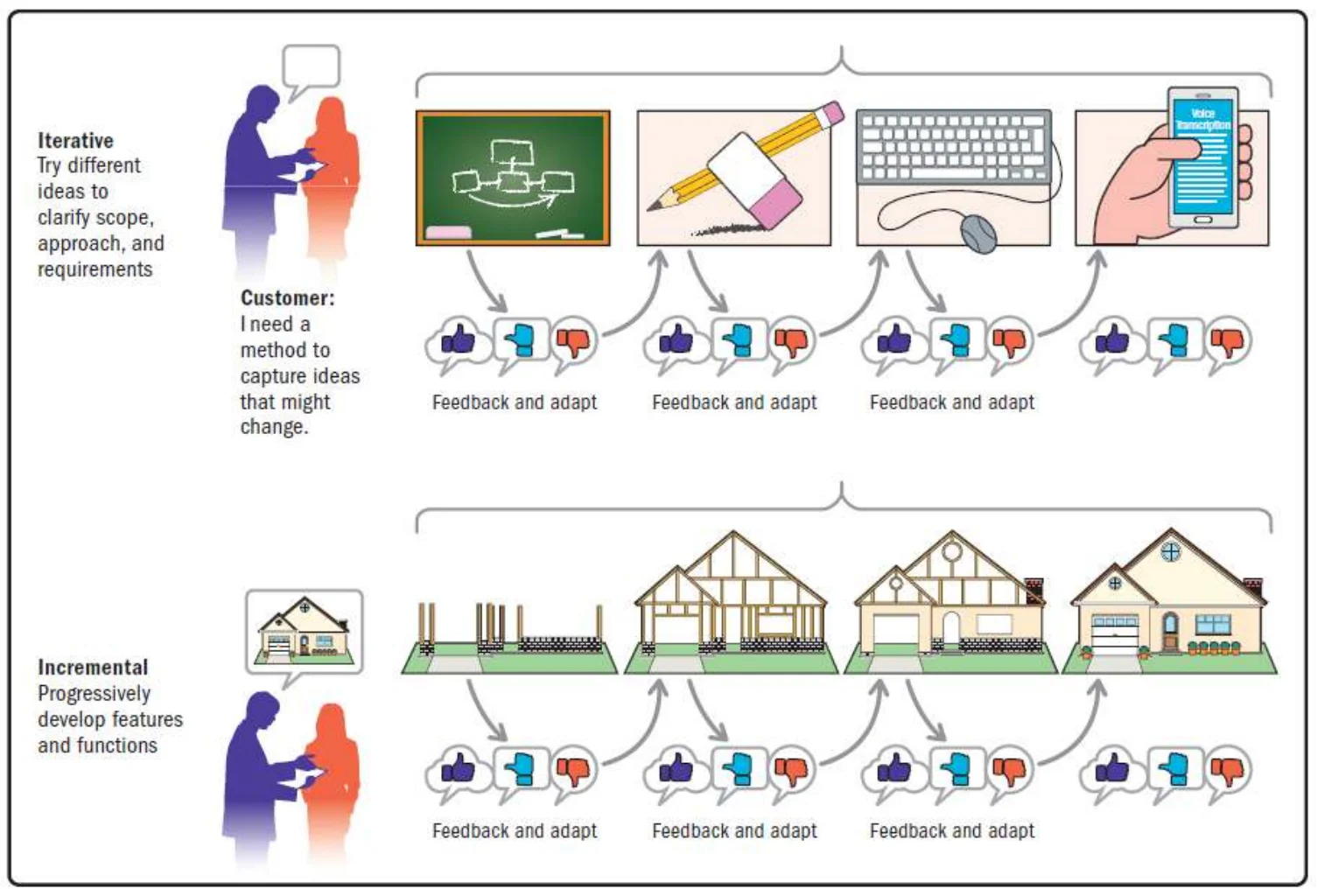

- Iterative = improve the SAME thing repeatedly. Incremental = add NEW pieces each time. Adaptive approaches use both.
🎯 How this can come up · 1 question
Adding one new feature to the product in each cycle is best described as:
Correct: Incremental development.
- Adaptive when requirements are uncertain and volatile. Start with a clear vision, refine the rest with feedback.
- Further toward adaptive: shorter iterations, more evolution driven by feedback.
Asked in a real exam
🎯 How this can come up · 1 question
In which project would an iterative development approach be most beneficial?
The real midterm question.
- Agile iterations: 1–2 weeks, ending with a demo.
- The team picks scope from a prioritized backlog and estimates it itself.
🎯 How this can come up · 1 question
In agile iterations, the project team itself determines the scope it can achieve from a prioritized backlog.
True.
- Product variables: Innovation, Requirements certainty, Scope stability, Ease of change, Delivery options, Risk, Safety, Regulations.
🎯 How this can come up · 1 question
A medical device with strict safety regulations and stable requirements: which way do these variables push the approach?
Toward predictive. Strict safety requirements and regulations plus stable, certain requirements favor up-front planning and phase reviews.
- Project variables: Stakeholders, Schedule constraints, Funding availability. All three of them push toward adaptive when present.
- MVP = release with minimum investment to test the market.
🎯 How this can come up · 1 question
A start-up with uncertain funding wants to test the market quickly. Which approach and artifact does the slide suggest?
Correct: Adaptive/iterative with a minimum viable product.
- Organizational variables: structure, culture, capability, team size and location.
Above “acceptance criteria”: “by stakeholder”.
- Phase gate = a checkpoint: are the exit criteria met? Then go to the next phase.
- Acceptance criteria are set by the stakeholders.
Seen again
🎯 How this can come up · 1 question
A phase gate review checks that exit criteria are met before moving to the next phase.
True.

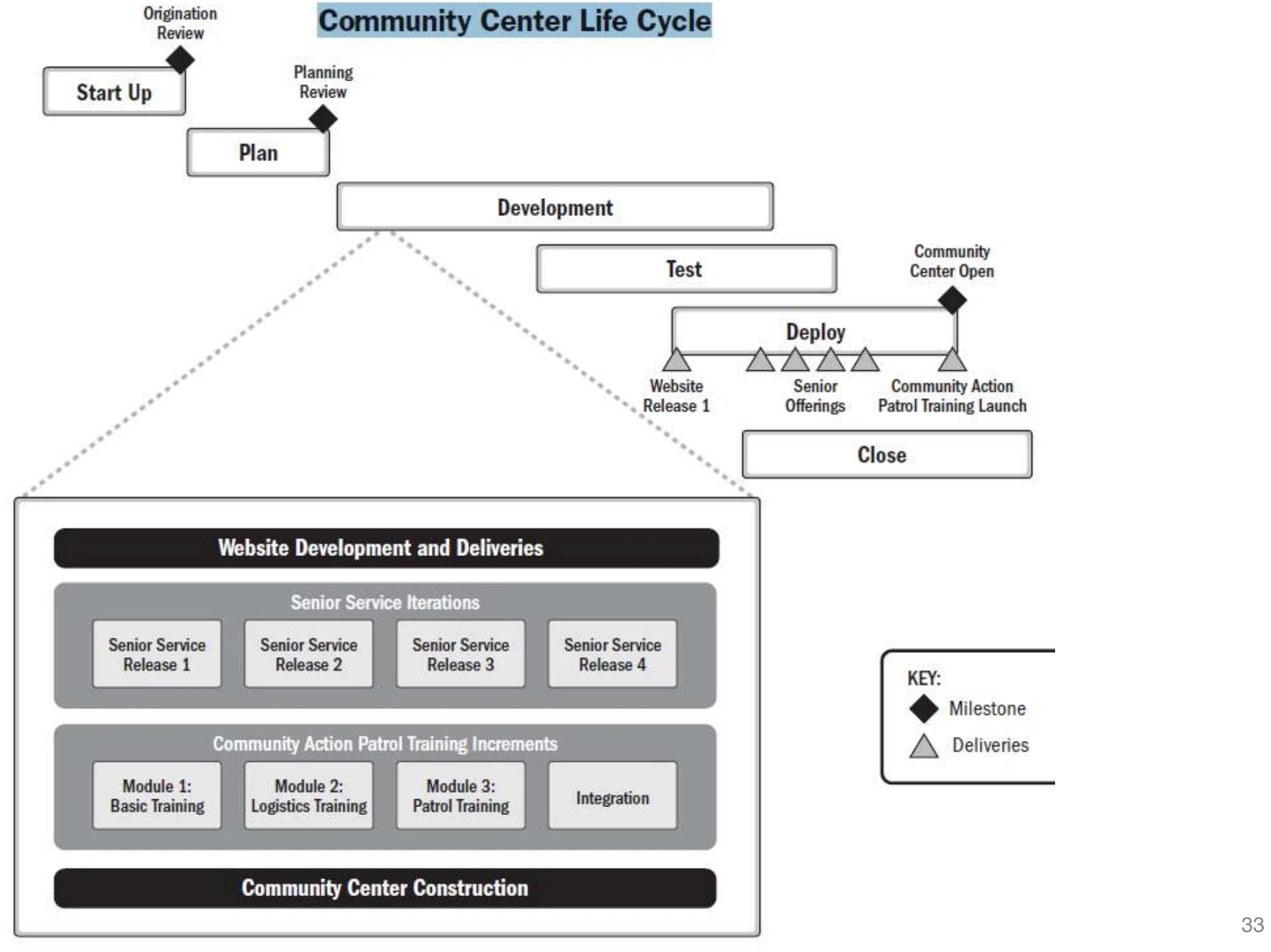

- A real hybrid: the building follows phases, while the website and training are released in increments.
- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.

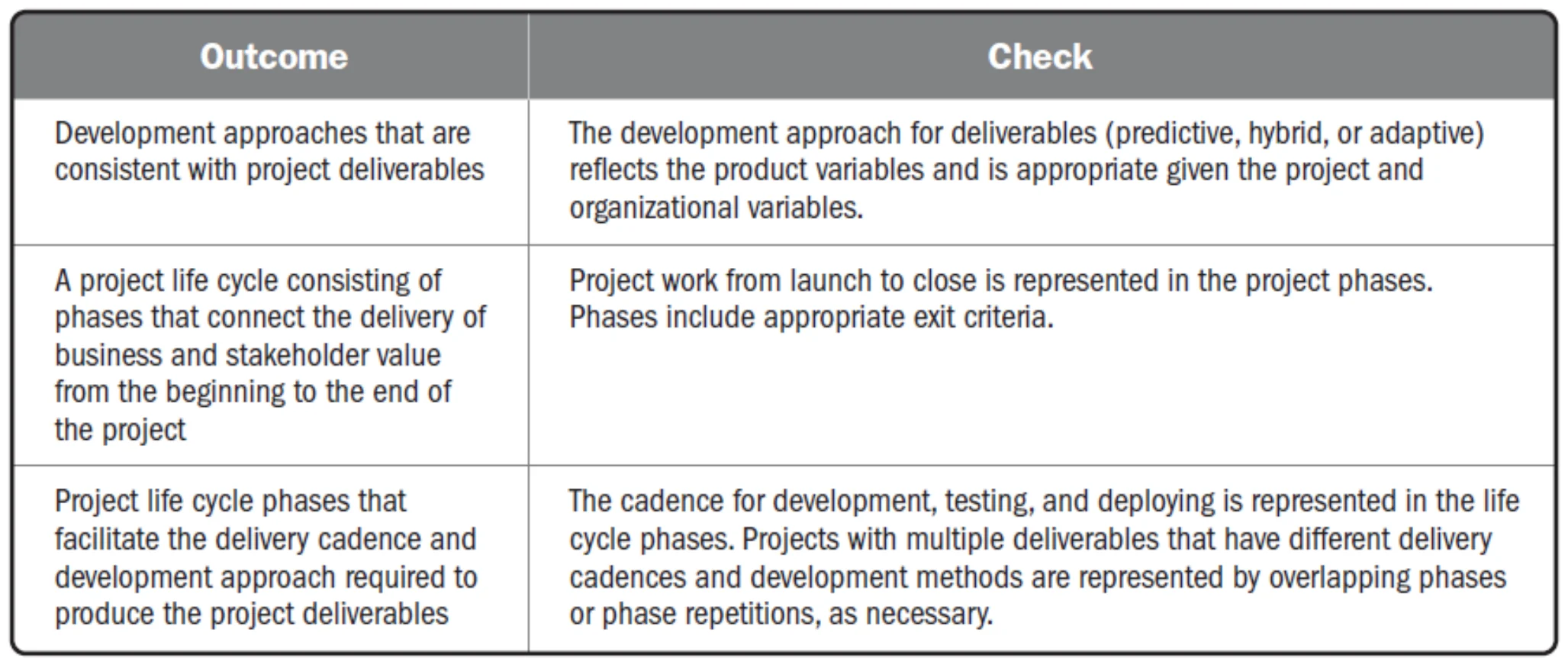

- Outcomes: organized progress, a holistic approach, plans elaborated over time, planning time appropriate for the situation, enough information for stakeholder expectations, and plans that adapt.
Seen again
Next to Accuracy: “correctness”. Next to Precision: “exact”.
- Accuracy = correctness: did the estimate match reality? ($100K estimate, $102K actual = accurate.)
- Precision = exactness: how detailed the estimate is. You can be precise but still inaccurate.
Seen again
🎯 How this can come up · 2 questions
An estimate built from a detailed cost breakdown ends up 40% over budget. The estimate was:
Correct: Precise but not accurate.
Accuracy is an assessment of exactness.
False. Accuracy = correctness. Precision = exactness.
Arabic gloss “مسبقًا” (in advance) for “proactively”.
- Planning = deciding in advance how you will create the deliverables.
- Progressive elaboration: start high level and add detail as you learn. Initial documents: vision statement, project charter, business case.
- Planning now also weighs social and environmental impact, for example a product life cycle assessment.
Related real-exam questions
🎯 How this can come up · 1 question
High-level planning may begin before the project is formally authorized.
True.
- Product scope = WHAT the product has (features and functions).
- Project scope = the WORK needed to deliver it.
Related real-exam questions
🎯 How this can come up · 1 question
“The work performed to deliver a product with the specified features” is:
Correct: Project scope.
- Predictive: decompose scope with a scope statement and a WBS.
- Adaptive: themes/epics → features → user stories → backlog items.
- Last responsible moment: delay a decision until waiting would cost more than it saves.
🎯 How this can come up · 1 question
Deferring a decision until the cost of further delay would exceed the benefit is called:
Correct: The last responsible moment.
- Estimates change as you learn more. That is the cone of uncertainty in Chapter 6.
Related real-exam questions
- Five steps of predictive scheduling: Decompose → Sequence → Estimate → Allocate → Adjust.
Related real-exam questions
🎯 How this can come up · 1 question
What is step 2 of the predictive scheduling process?
Correct: Sequence related activities.
- Mandatory = required by contract or by nature (you cannot test before building). Cannot be changed.
- Discretionary = best practice or preference, so it can be changed. This is what you relax when fast-tracking.
Related real-exam questions
🎯 How this can come up · 2 questions
Waiting for a government permit before construction can start is which type of dependency?
It links a project activity to a non-project activity.
A discretionary dependency usually cannot be modified.
False. It is based on best practice or preference, so it may be modifiable.

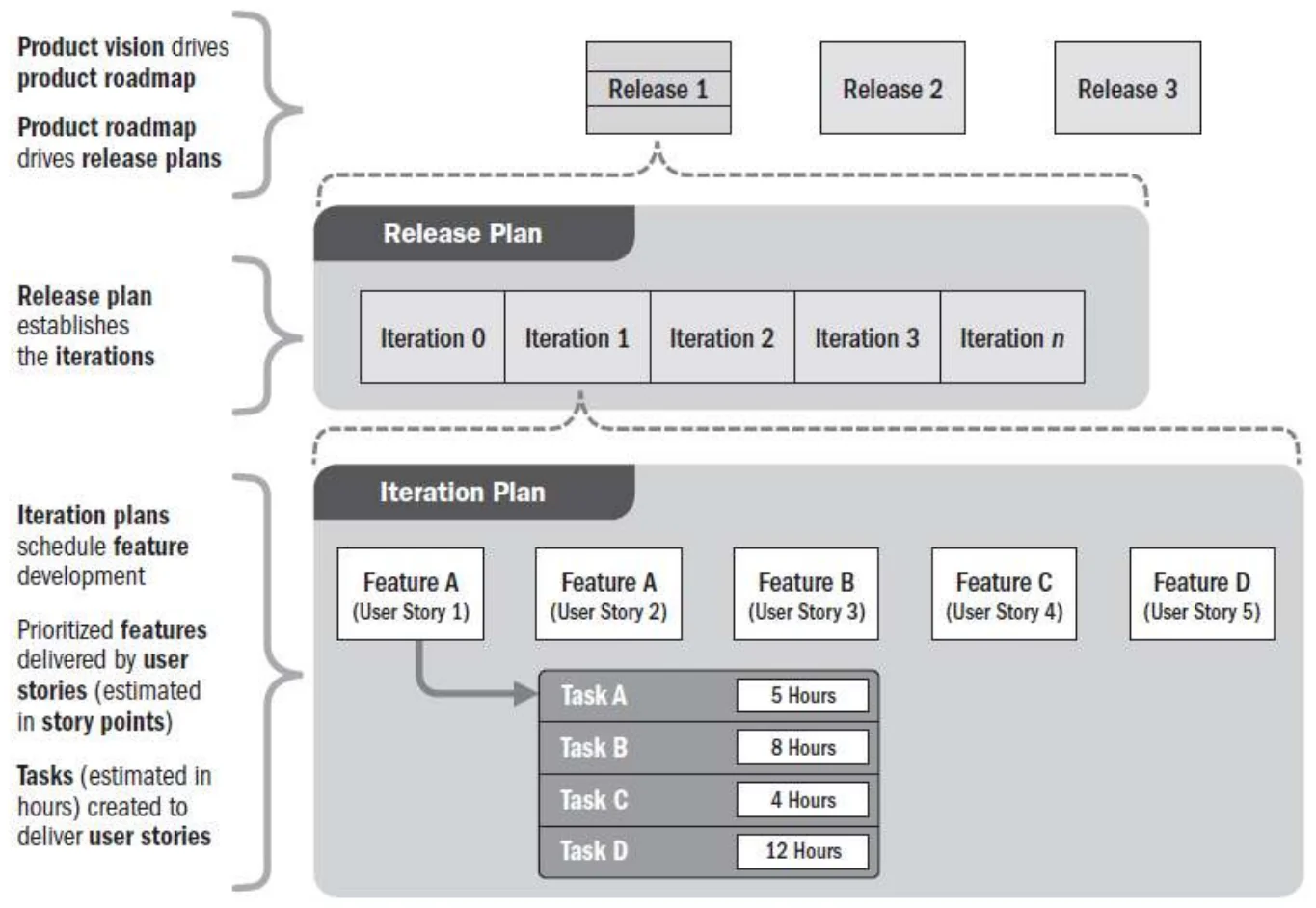

- Adaptive scheduling: release plan → each release has 2+ iterations → each iteration adds value.
- Future releases stay high level on purpose, because feedback will change them.
- Zoom levels: vision → roadmap → releases → iterations → features (user stories) → tasks (hours).
- Timebox = fixed time, flexible scope (a sprint is a timebox).
- After each timebox: demo, then reprioritize the backlog.
Seen again
🎯 How this can come up · 1 question
In a timebox, the scope is fixed and the time is flexible.
False. The reverse: the time is fixed and the scope adjusts.

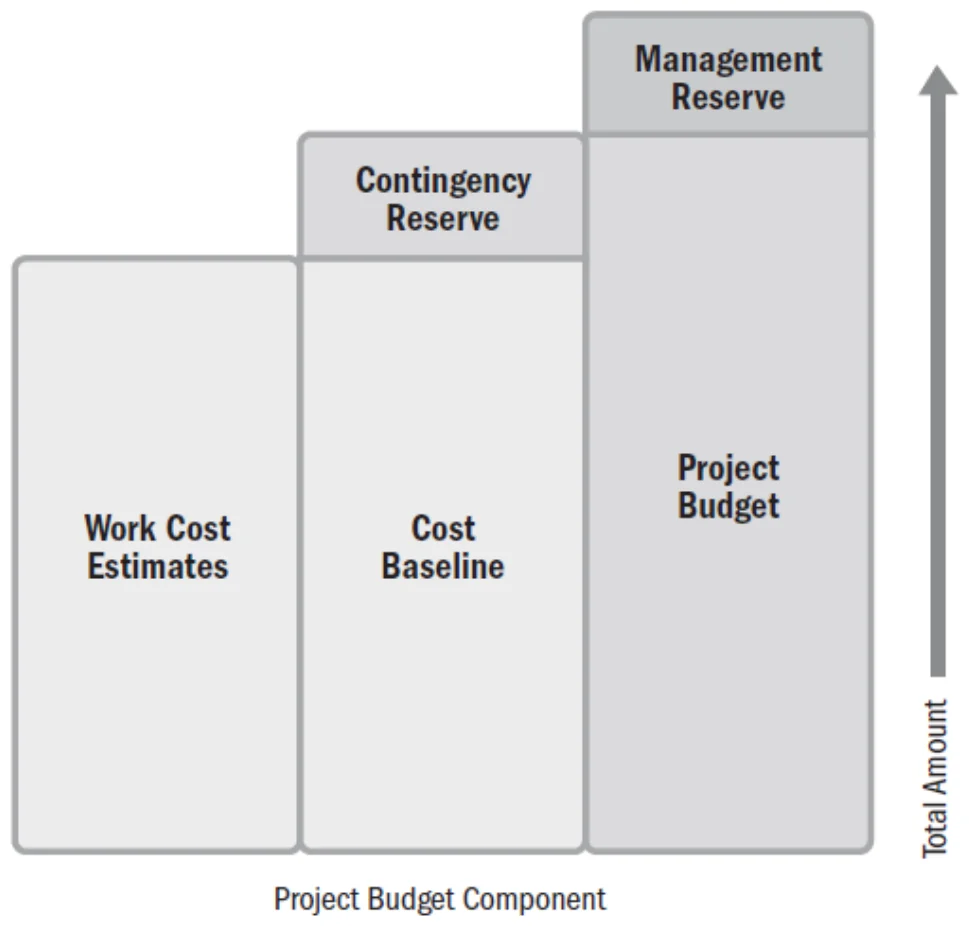

- Cost baseline = the time-phased budget: estimates summed and spread over the schedule.
- Contingency reserve = for KNOWN (identified) risks. The PM controls it.
- Management reserve = for UNKNOWN events. Upper management controls it.
🎯 How this can come up · 1 question
A reserve for unknown, unplanned in-scope work, usually controlled by upper management, is the:
Correct: Management reserve.
- Build it bottom-up: estimates + contingency = cost baseline; cost baseline + management reserve = total project budget.
🎯 How this can come up · 1 question
Which is included in the cost baseline but NOT the management reserve?
Cost baseline = work estimates + contingency reserve. Management reserve is added on top to give the project budget.
- Physical resources = everything that is not a person: materials, equipment, software, licenses, test environments. Plan the logistics too: lead time, storage, tracking.
- Make-or-buy: decide what to build in-house and what to purchase.
🎯 How this can come up · 1 question
Deciding which deliverables to develop in-house and which to purchase is called:
Correct: Make-or-buy analysis.

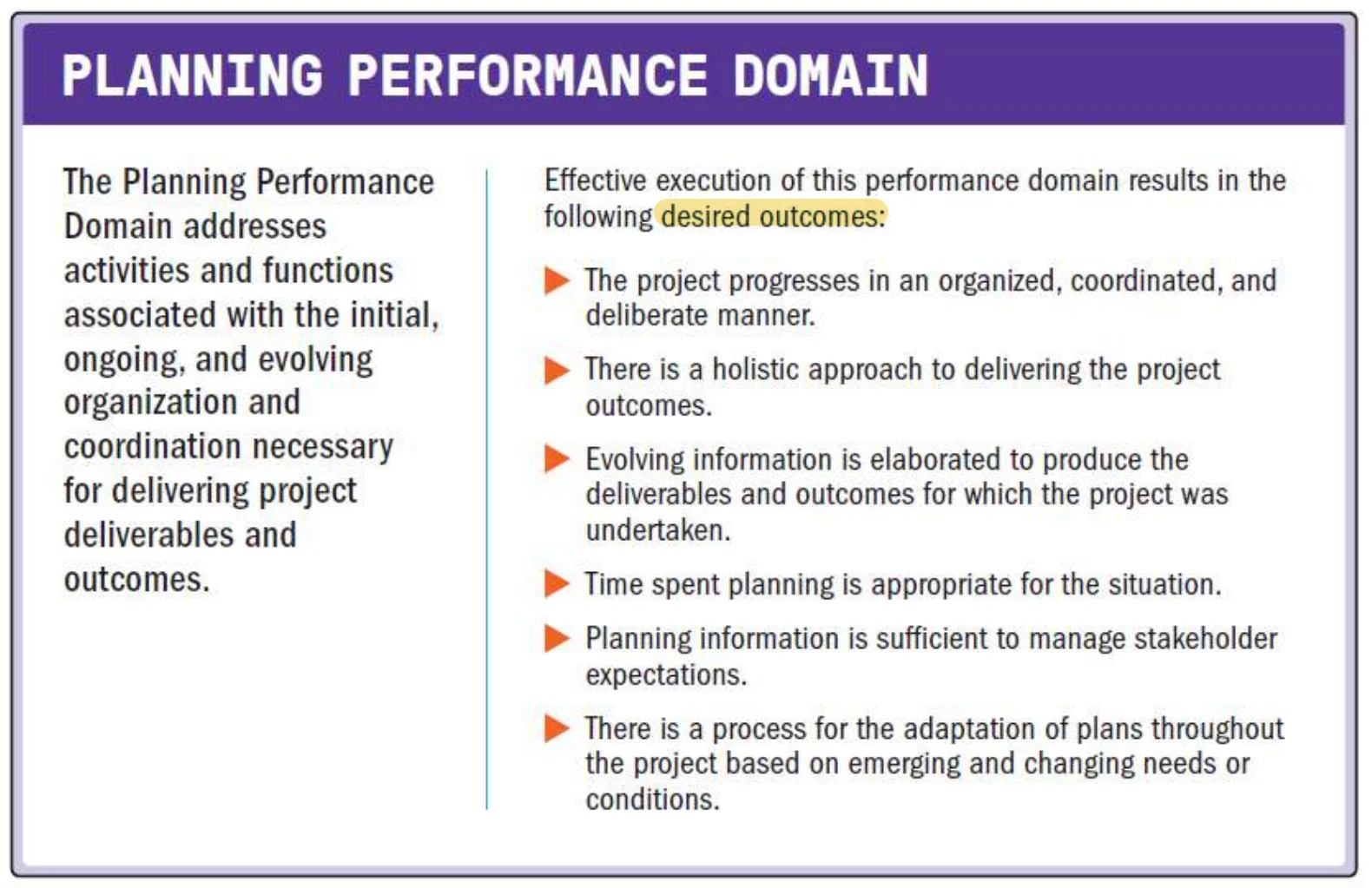

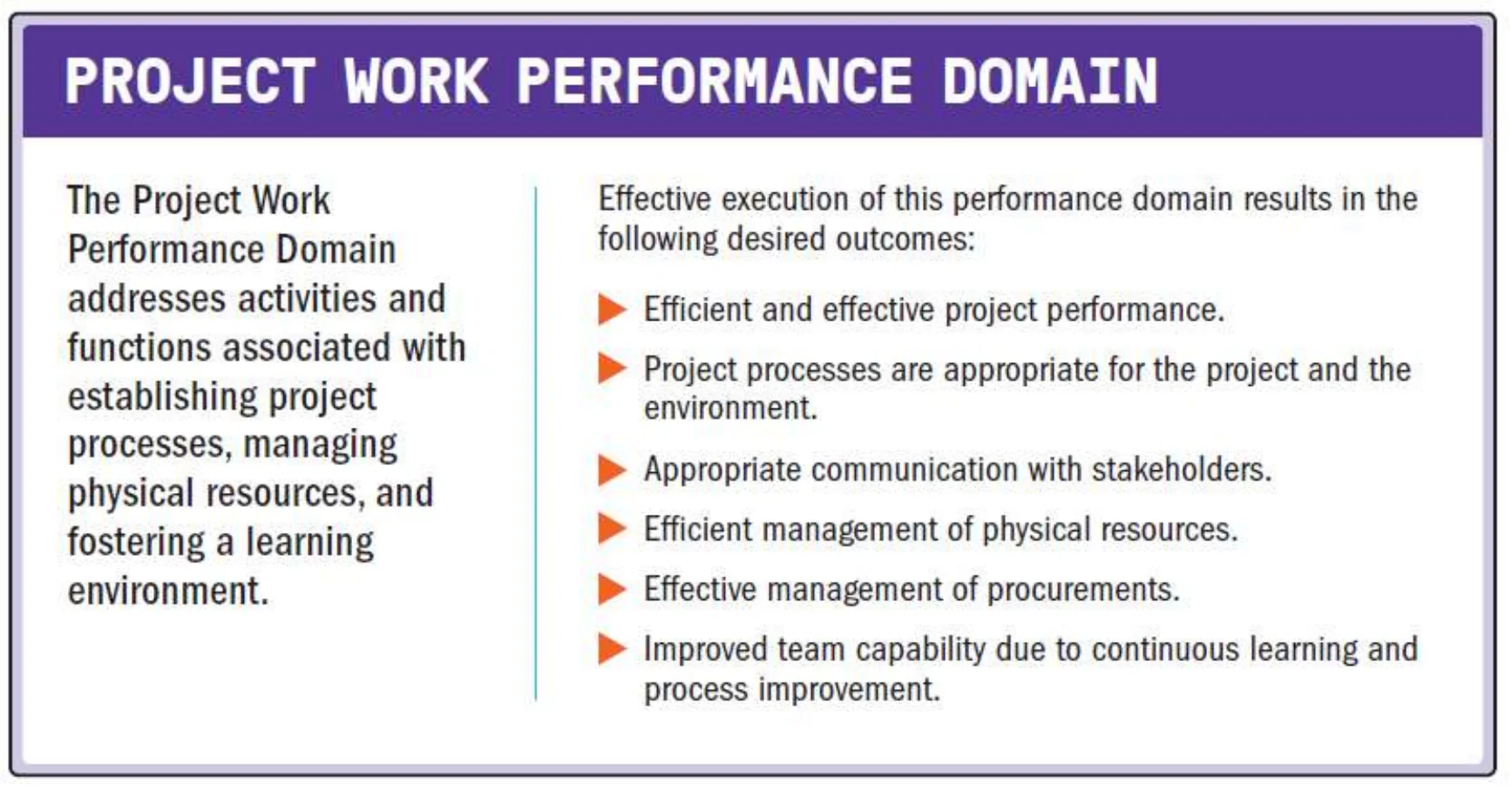

- Metrics link planning, delivering and measuring. Set thresholds: expected, trending, or unacceptable.

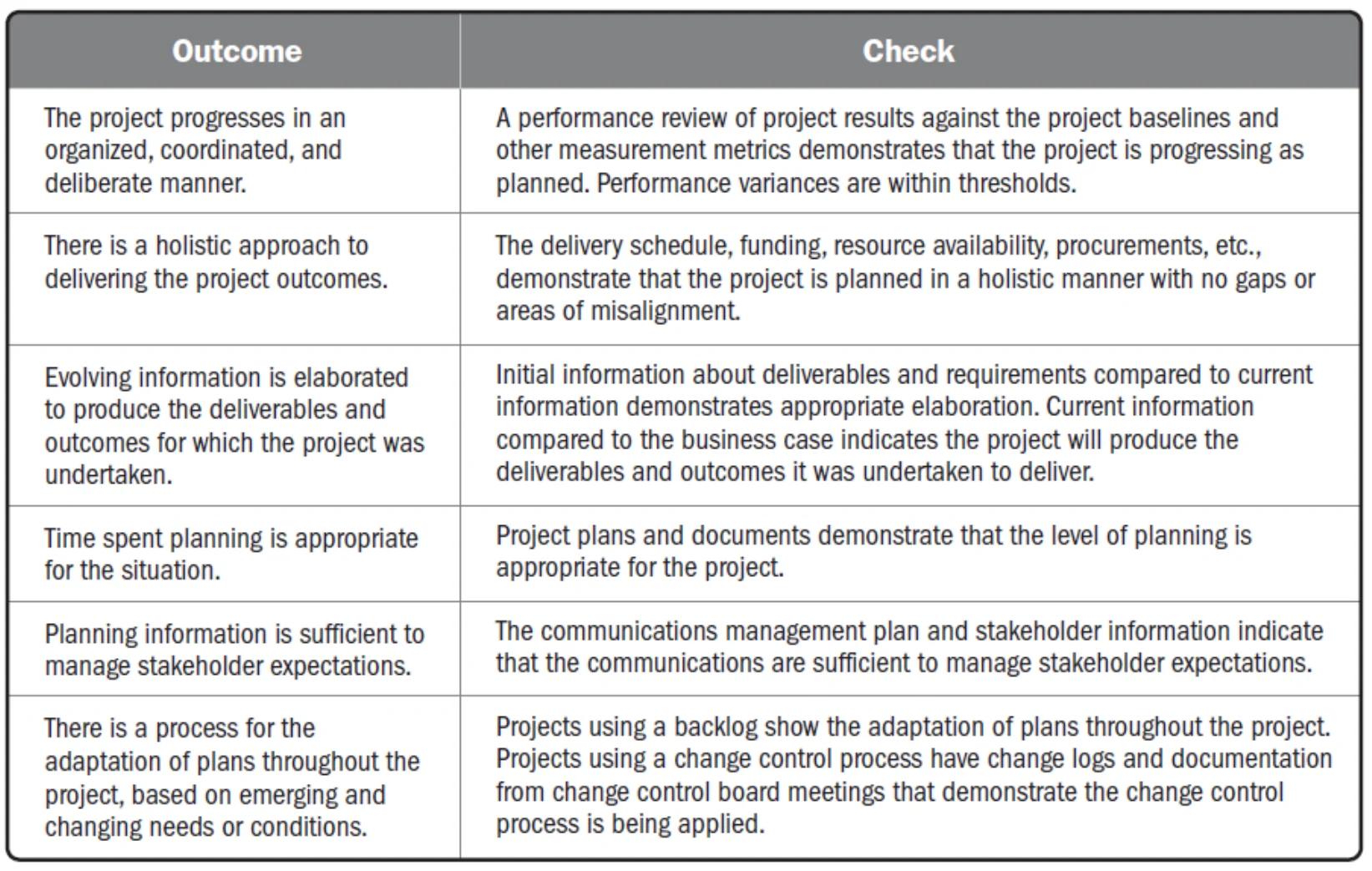

- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.
- Outcomes: efficient performance, appropriate processes, good communication, efficient physical resources and procurement, and continuous learning.
- Explicit = can be written down (words, numbers, pictures).
- Tacit = in people’s heads (beliefs, experience, insights) and hard to share.
🎯 How this can come up · 2 questions
An experienced developer’s instinct for which modules usually break is:
Correct: Tacit knowledge.
A meeting with prospective sellers so all vendors share a common understanding before bidding is a:
Correct: Bidder conference.

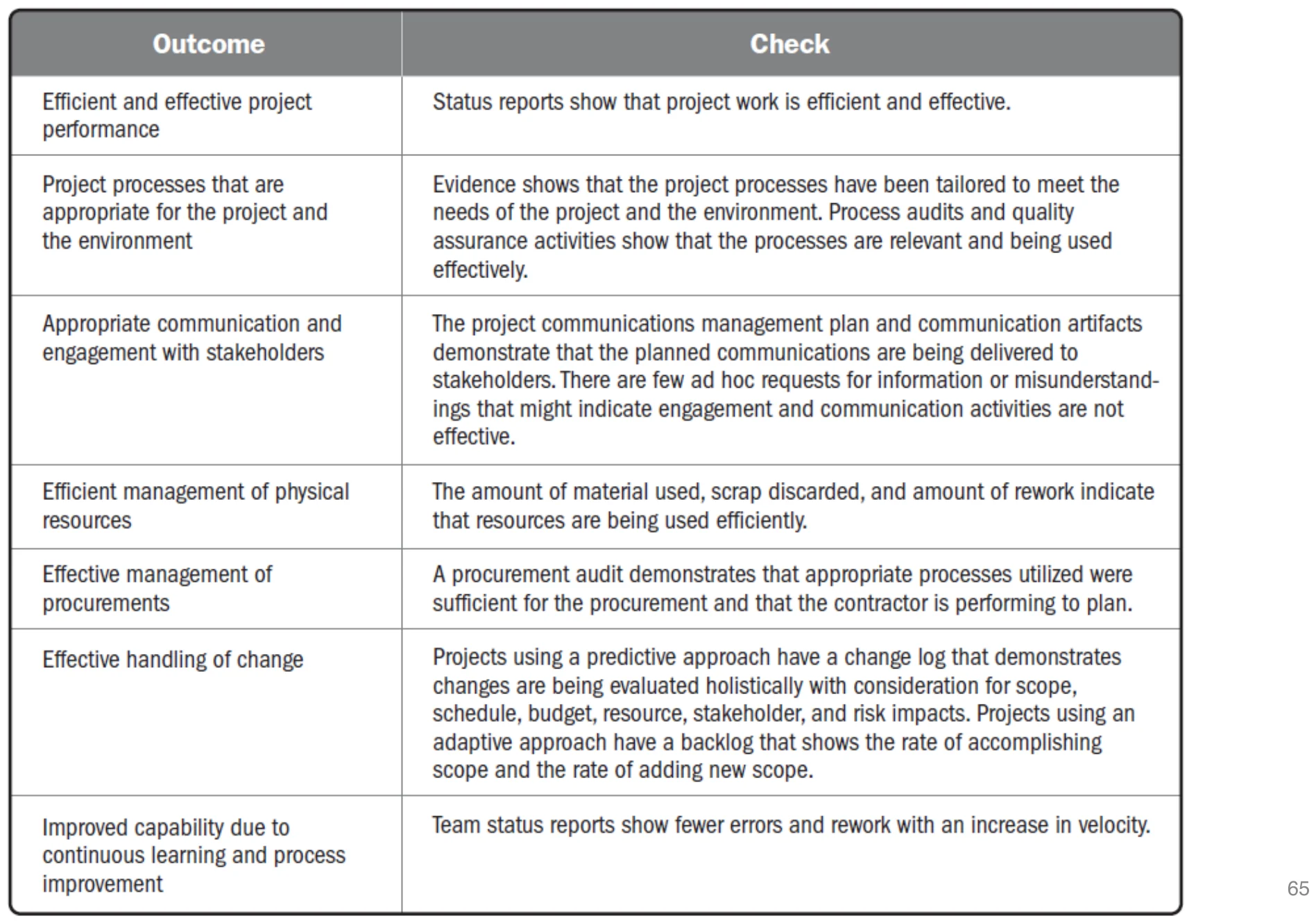

- Project work = keeping the work flowing: changes, focus, processes, communication, logistics, procurement, monitoring, learning.
- Review the process regularly: bottlenecks, flow rate and blockers (task boards help).
- More process for large or critical projects, less for small or less critical ones. Optimize with lean methods and retrospectives.
Seen again
- Time spent checking the process is time not spent delivering. Use “just enough” review.
- Constraints = the limits you work within: dates, regulations, budget, quality. They shift during the project.
- Trade-offs: a new requirement adds schedule and budget; a budget cut relaxes quality or scope.
Related real-exam questions
🎯 How this can come up · 1 question
Define project constraints, give three examples and explain how they interrelate.
Constraints are the limits a project must work within: for example a fixed delivery date (schedule), a predetermined budget (cost), quality policies, scope and regulatory compliance. They are interrelated, so changing one affects the others: a new stakeholder requirement expands the schedule and budget, and a budget cut forces relaxed quality or reduced scope. The PM balances them continuously while keeping stakeholders satisfied.
- Big trade-offs go to the customer, sponsor or product owner with alternatives.
- Smaller ones the team can decide within its own authority.
- PMs usually CANNOT sign contracts. They work with contracting officers.
🎯 How this can come up · 1 question
In most organizations, the project manager has the authority to sign procurement contracts.
False. Most PMs do not have contracting authority.
- The PM plus technical experts help draft the RFP and SOW; the contracting professionals run the process.
- RFI = “What is out there?” (learning). RFP = “How would you build it?” (solution).
- RFQ = “What is your price?” (a known item, compare prices).
🎯 How this can come up · 2 questions
A company needs 500 laptops with exact specs and asks vendors for their best price. It issues an:
Correct: RFQ.
A company unsure which technologies or vendors exist issues an:
Correct: RFI.
- Learning through the project = managing knowledge, both explicit (documents) and tacit (people). See slide 54.

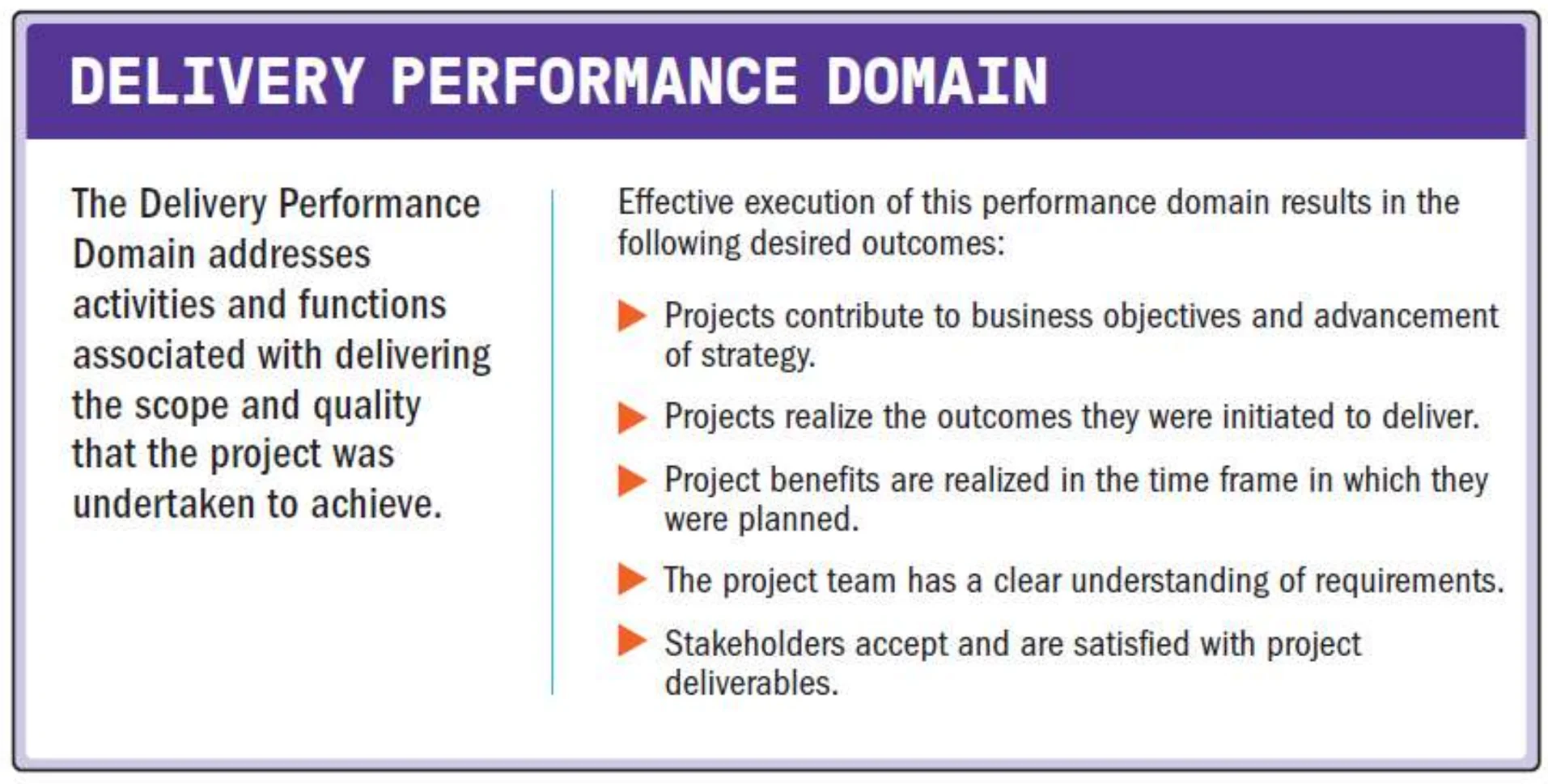

- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.

- Outcomes: contribute to strategy, realize the outcomes, realize benefits on time, a clear understanding of requirements, and satisfied stakeholders.
- DoD = the checklist that makes a deliverable “done” and ready for the customer.
- COQ = prevention + appraisal + failure costs, over the whole product life.
Seen again
🎯 How this can come up · 1 question
Which three cost types make up the Cost of Quality?
Correct: Prevention, appraisal, and failure.
- Releasing throughout the life cycle means value starts arriving DURING the project.
- The business case justifies the project and projects its value.
- Scope = WHAT. Quality = HOW WELL (the performance levels).
- Invest in prevention and appraisal now to avoid more expensive failures later.
- Failure is possible even with good PM: experiments, a missed market window, competitors arriving first.
- Good PM reduces, but never removes, the chance of bad outcomes.

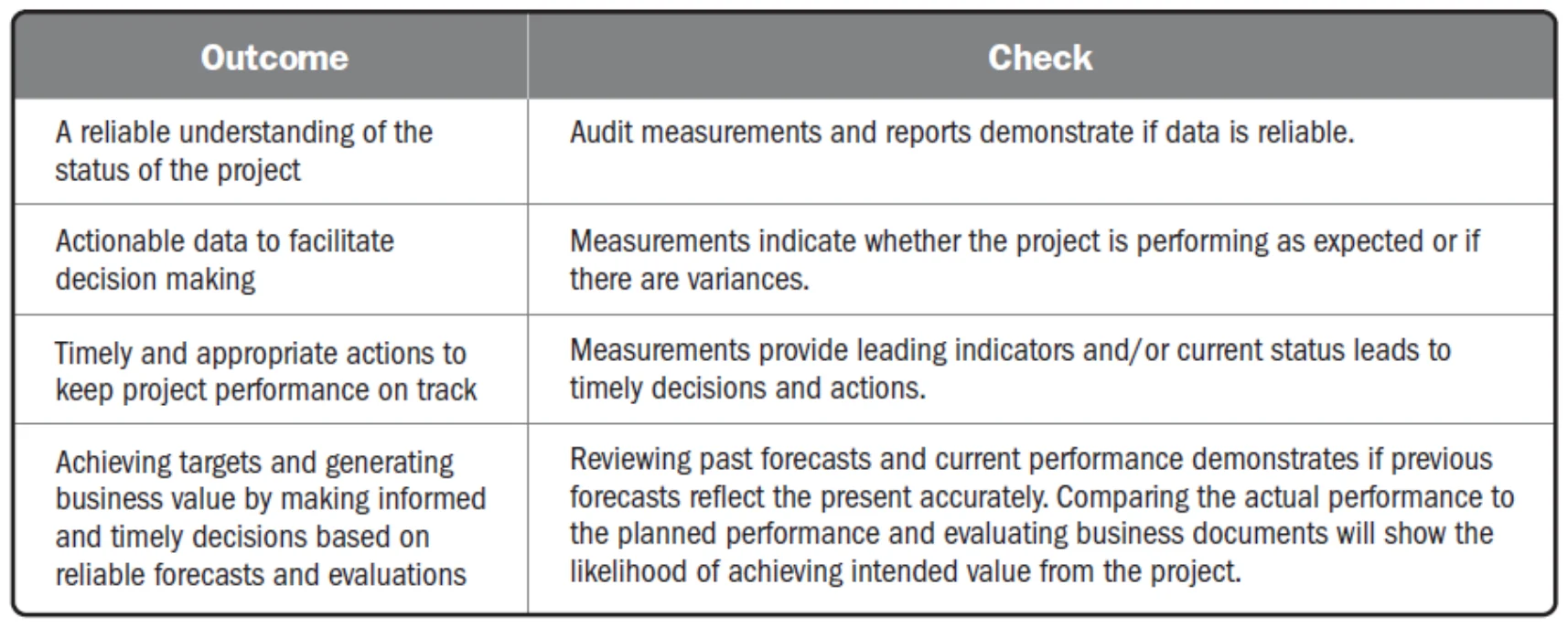

- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.

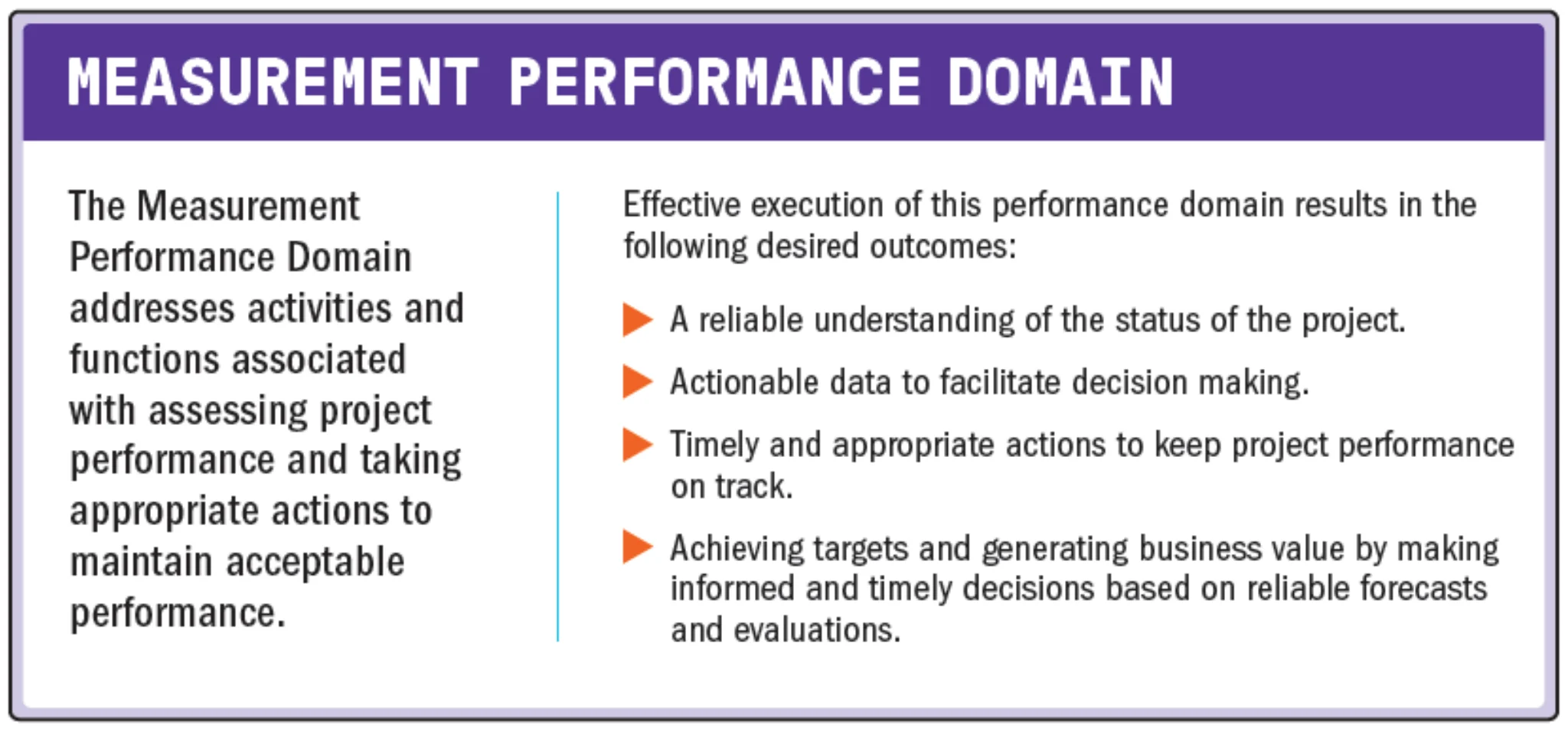

- Outcomes: reliable status, actionable data, timely action, and business value from informed decisions.
- Metric = what you measure and how.
- Baseline = the approved plan you compare actual results against.
🎯 How this can come up · 1 question
The approved version of a measure used for comparison with actual results is a:
Correct: Baseline.
- Seven reasons to measure: performance vs. plan, resource tracking, accountability, informing stakeholders, benefits, trade-off conversations, acceptance.
- Data has no value on its own. The value is in the decisions it triggers.
- Leading = predict (scope change rate, workload balance) → you can still act.
- Lagging = after the fact (cost variance, deliverables completed, satisfaction).
🎯 How this can come up · 2 questions
Which is a LEADING indicator?
Correct: Team workload balance.
Cost variance is a leading indicator.
False. It is lagging: it measures something that has already happened.
- SMART here = Specific, Meaningful, Achievable, Relevant, Timely. Note: M is Meaningful, not Measurable.
🎯 How this can come up · 1 question
According to the slide, the M in SMART metrics stands for:
Correct: Meaningful.
- Seven categories: Deliverables, Delivery, Baseline, Resources, Business value, Stakeholders, Forecasts.
- Lead time = from identifying the need to delivering the result (the customer’s whole wait). Cycle time = just the working part.
- Business value: cost-benefit ratio, ROI, NPV. Stakeholders: NPS, mood chart, morale, turnover.
- Forecasts: ETC (left to spend), EAC (total at the end), VAC (budget − EAC).
Seen again
🎯 How this can come up · 1 question
Which metric belongs to the “Stakeholders” category?
Correct: Net Promoter Score.
- An example dashboard for the people metrics from slide 81, each with a current value, trend, target and red/amber/green status.
- Three ways to present information: Dashboards (summary), Information radiators (posted where everyone sees them), Visual controls (task boards, burn charts).

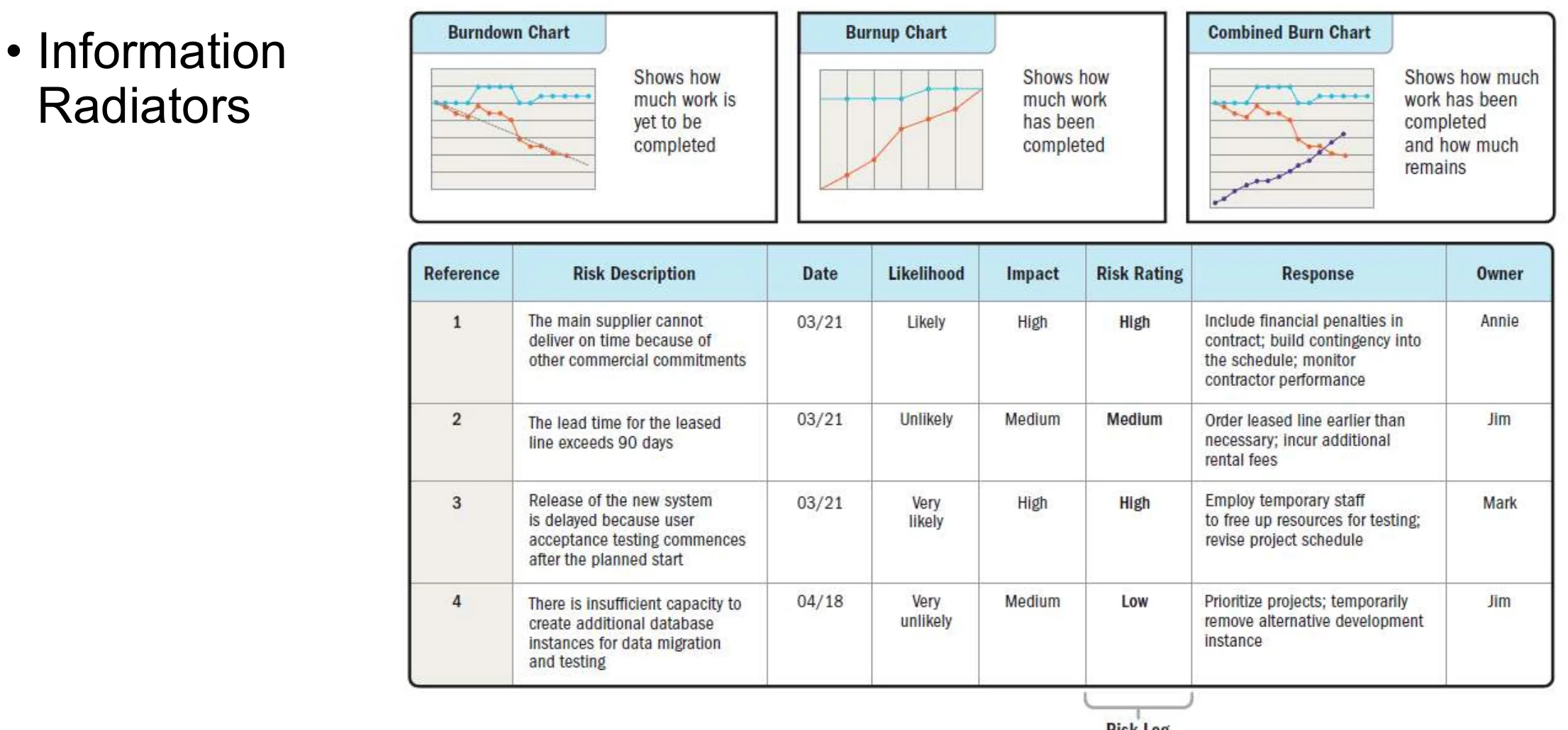

- Information radiator = a big visible display (burn charts, risk log) placed where the team works.
- A task board makes flow visible. Lead time = whole journey; cycle time = from starting work to done.
Related real-exam questions
- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.

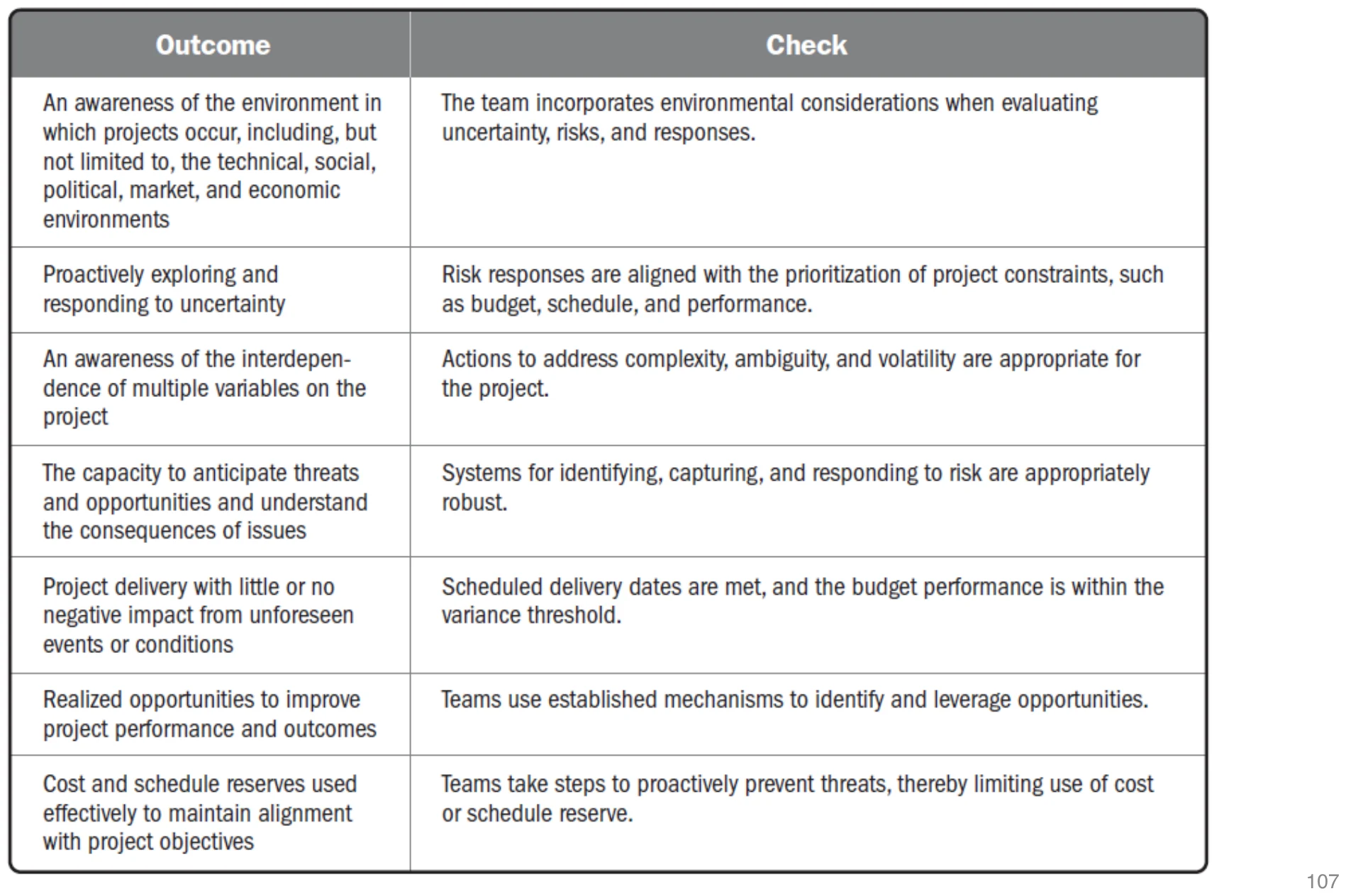

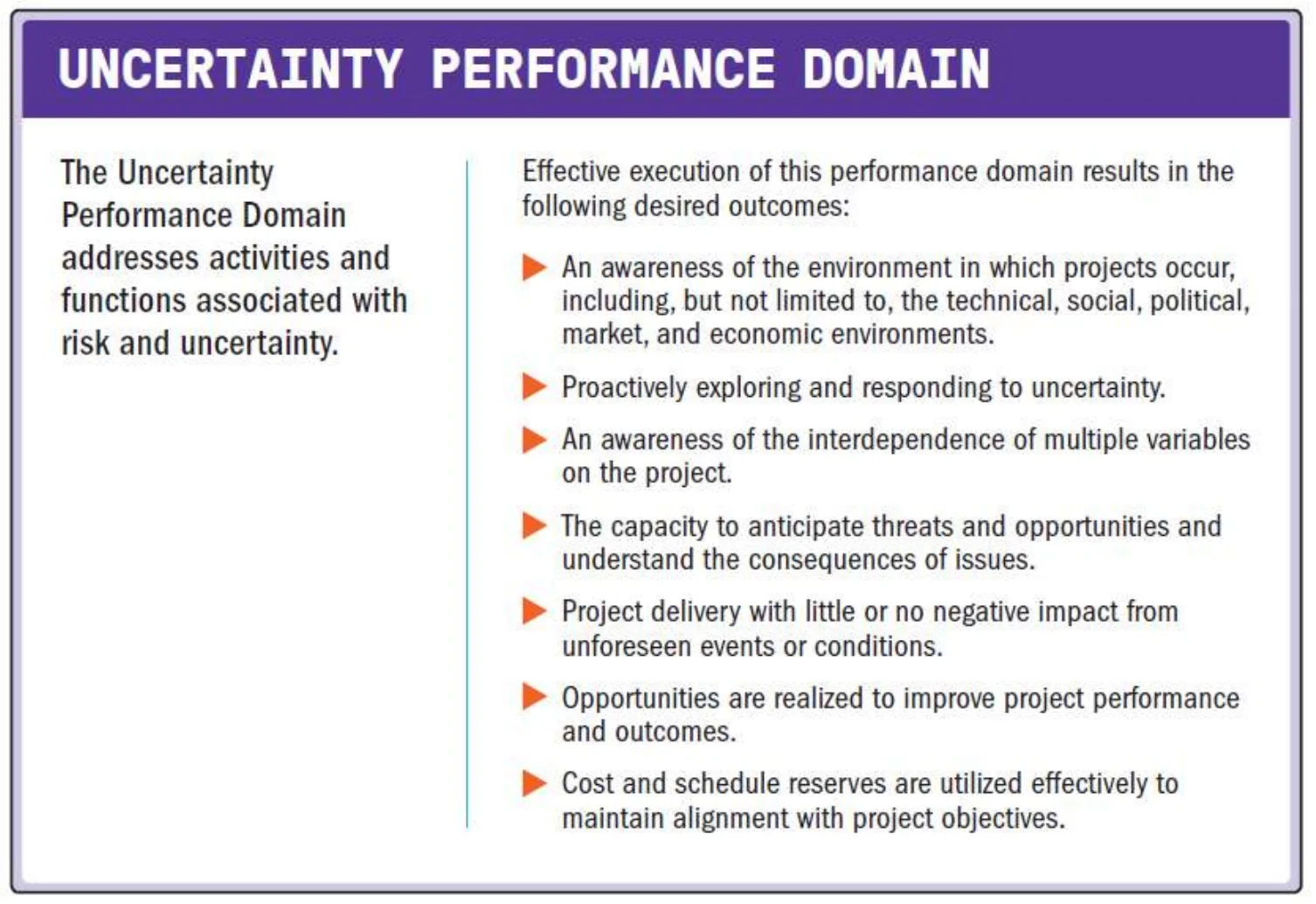

- Outcomes: awareness of the environment, proactive responses, understanding interdependencies, anticipating threats and opportunities, little impact from surprises, and effective use of reserves.
- Five terms: Uncertainty (not knowing), Ambiguity (unclear, multiple options), Complexity (hard to manage), Volatility (rapid change), Risk (an uncertain event with + or − effect).
- Risk can be positive (opportunity) or negative (threat).
🎯 How this can come up · 2 questions
“The possibility for rapid and unpredictable change” defines:
Correct: Volatility.
“Having multiple options from which to choose” is a form of:
Correct: Ambiguity.
- Uncertainty is the umbrella term. Under it: risk (future events), ambiguity (unaware of conditions), complexity (unpredictable systems).
- Sources of environmental uncertainty, PESTLE-style: Political, Economic, Social/market, Technical, Legal, Physical environment, plus Ambiguity.
- Conceptual = the same words mean different things (“reported on track last week”).
- Situational = more than one outcome or option is possible.
🎯 How this can come up · 1 question
Team members disagree on what “done” means in the status meeting. This is:
Correct: Conceptual ambiguity.
- Complexity sources: human behavior, system behavior, ambiguity (Chapter 1 adds uncertainty).
Seen again
- Three ways to work with complexity: Systems-based · Reframing · Process-based. The next three slides give two or three tools each.
- Decoupling = separate parts to make the problem smaller.
- Simulation = learn from analogous situations (malls → airport shops).
🎯 How this can come up · 1 question
Studying shopping malls to predict buying habits in a new airport is which complexity technique?
Correct: Simulation.
- Diversity = many perspectives (brainstorming, Delphi).
- Balance = mix leading and lagging data.
- Iterate = build a bit and learn.
- Fail safe = redundancy and graceful degradation for critical parts.
🎯 How this can come up · 1 question
Adding a backup server so a critical system degrades gracefully is which technique?
Correct: Fail safe.
- Volatility usually hits cost and schedule.
- Two answers to volatility: alternatives analysis (different skills mix, resequencing, outsourcing) and reserves.
- Cost reserve covers overruns caused by price volatility.
- Every project has risk because every project is unique.
- Overall risk = the combined effect of complexity, ambiguity and volatility. If it is too high, cancelling is a valid response.
- Threats: Avoid (eliminate), Escalate (outside the PM’s authority), Transfer (to a third party, e.g. insurance), Mitigate (reduce probability or impact), Accept (live with it, maybe with a reserve).
Related real-exam questions
🎯 How this can come up · 2 questions
Buying insurance against a data-centre fire is which threat strategy?
Correct: Transfer.
Which strategy appears for BOTH threats and opportunities?
Escalate and Accept appear in both lists.
- As risks are handled, the cumulative threat score should fall over time. This chart shows it.
- Example opportunity: a subcontractor finishing early.

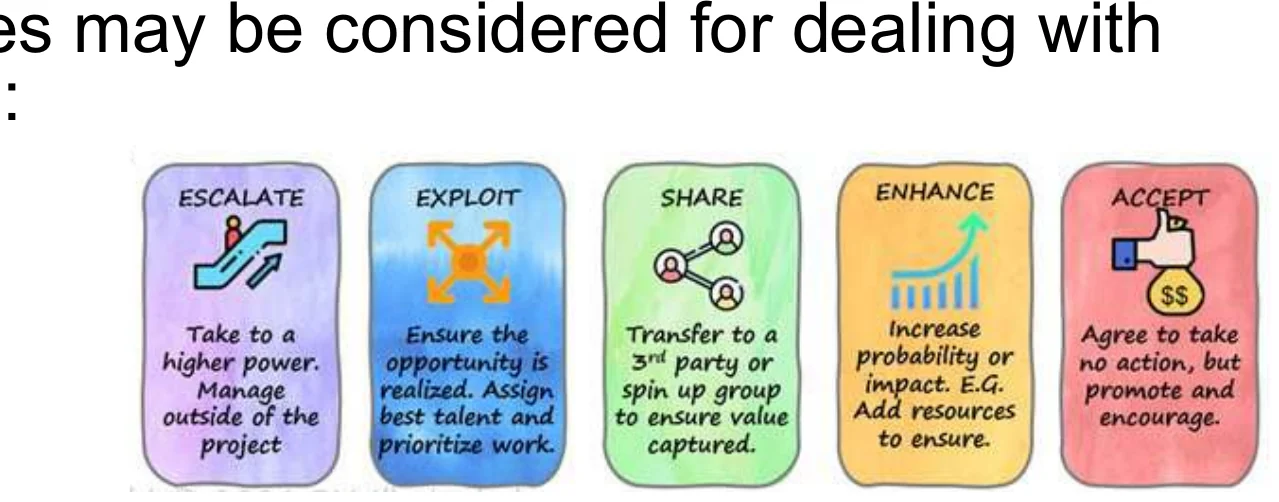

- Opportunities: Exploit (make sure it happens), Escalate, Share (with a partner who can capture it), Enhance (raise probability or impact), Accept.
🎯 How this can come up · 1 question
Partnering with another firm so a positive risk can be captured is which opportunity strategy?
Transfer is a threat strategy.
- Contingency → identified risks.
- Management → unknown events.
🎯 How this can come up · 1 question
Contingency reserve is set aside for unknown, unplanned events.
False. That is the management reserve. Contingency covers identified risks.
- Stand-ups surface blockers (potential threats) and breakthroughs (potential opportunities).
- Demos and proofs of concept also reveal risks early.
Seen again
- Read the left column as “what success looks like” and the right column as “how you would prove it”. These tables are rarely tested word for word; use them to explain a domain in a written answer.
No slides match this filter.
