Skip to content
Schedule·Field Guide
DARK
SE423 · Software Project Management · Chapter 6.2

Scheduling and Tracking:
the map, and proof you followed it.

A schedule is a promise with dates on it. This chapter is about making that promise honestly — breaking work down (WBS), figuring out what depends on what (network diagrams), finding the one sequence of tasks that controls your deadline (the critical path), and then, once the project is running, proving with numbers — not vibes — whether you're actually on track (Earned Value).

WBS → Network → CPM → PERT
Worked critical-path example
Brooks's Law
Earned Value (PV/EV/AC/CPI/SPI)
start → critical path → end A B C D E 9 9 5 7 11 critical = 0 slack
§ 01 — THE CONTINUUM

Planning → Estimating → Scheduling → Tracking

Schedule development is not a single step — it's the culmination of Project Time Management: activity definition, activity sequencing, activity resource estimating, and activity duration estimating, all feeding one iterative process.

🧭
Memory hook
"Plan it, Estimate it, Schedule it, Track it."
Each word adds one more piece of precision to the last. Plan = what (no dates yet). Estimate = how much (size/duration, still no dates). Schedule = when (adds start/end dates, dependencies, resources). Track = how honest was the plan (uses monitoring to check reality against it).
Plan

Identify activities — no dates yet

Just the checklist of what must happen. No commitments on when.

Estimate

Determine the size & duration of activities

How big is each piece of work? Still no calendar dates attached.

Schedule

Adds specific start/end dates, dependencies, and resources

This is where the network diagram, CPM, and PERT live.

Track

Uses monitoring and tools to check accuracy

Determines whether the plans, estimates, and schedule are actually holding up. This is where Earned Value lives.

How to schedule — the 4-step recipe
1. Identify "what" needs to be done → WBS
2. Identify "how much" (the size) → size estimation techniques
3. Identify dependency between tasks → dependency graph / network diagram
4. Estimate total duration → the actual schedule
Controlling factors in schedule development
Project scope statement is the source of assumptions (PMI: schedule-related factors considered true/real/certain) and constraints (factors that limit the PM team's options during network analysis, e.g. "only use internal HR"). Date constraints and milestones matter most.

Project management plan — nearly every sub-plan can influence scheduling, but the risk register and risk-associated plans are the most critical influence.

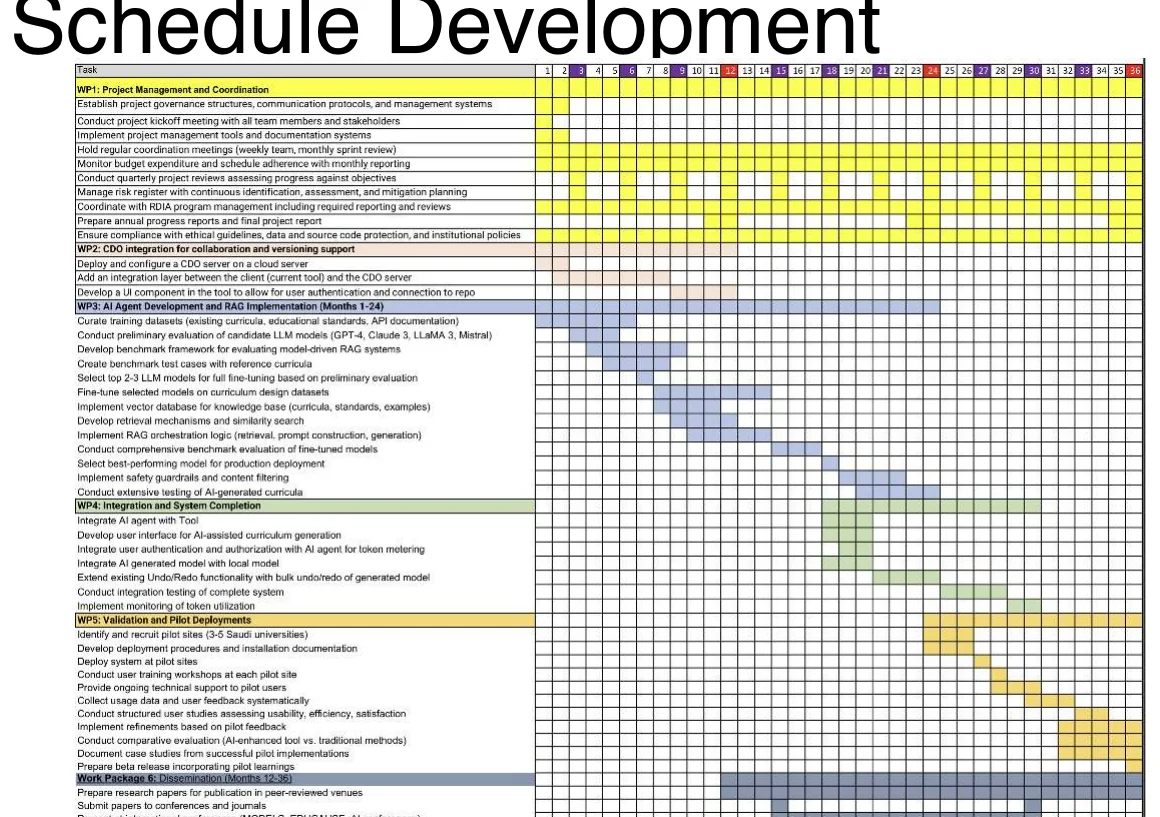

PDF page 3A schedule, as it actually looks.

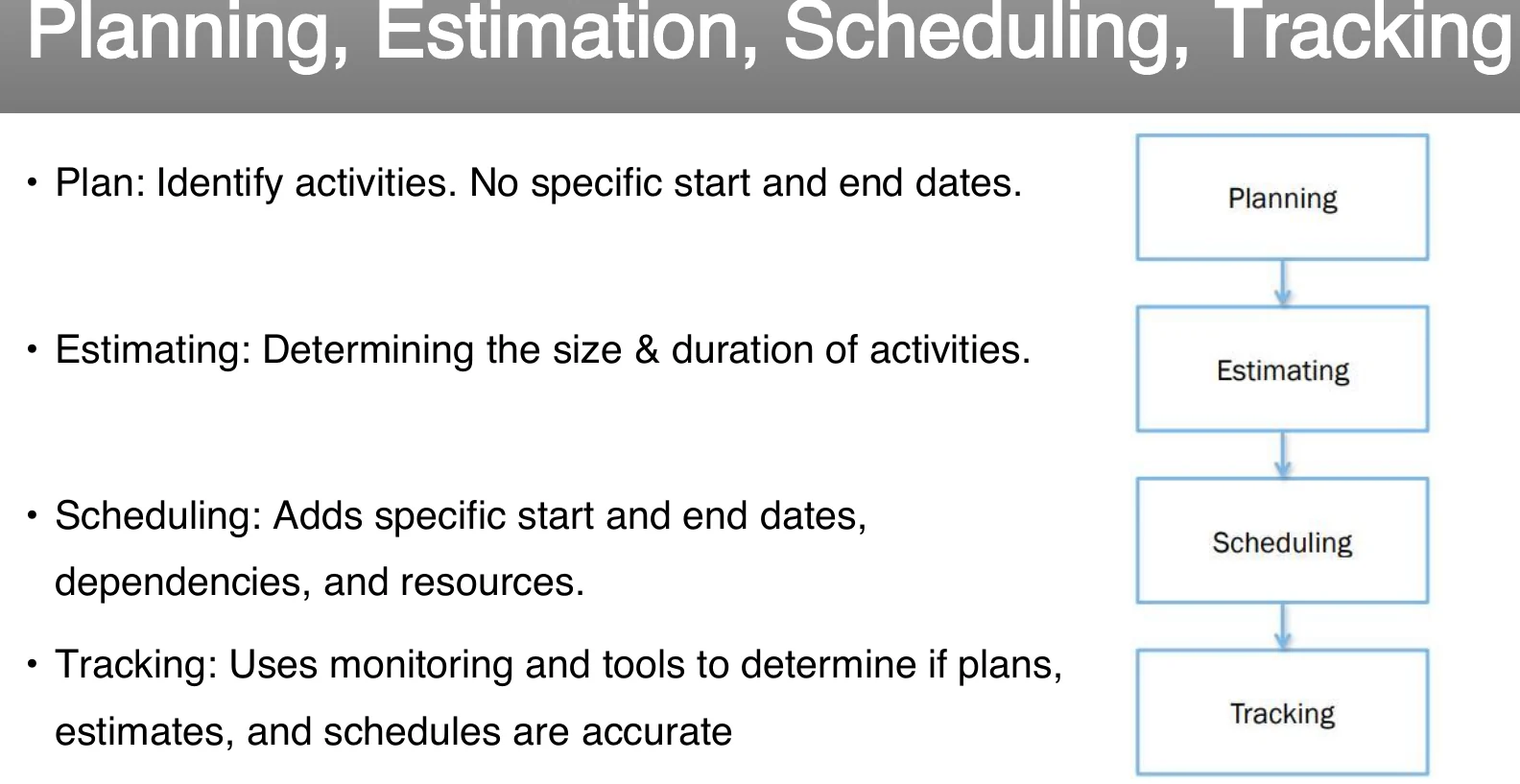

PDF page 4Planning, estimating, scheduling and tracking as one continuum.
§ 02 — WORK BREAKDOWN STRUCTURE

WBS: the checklist that everything else is built on

The WBS lists the major project outputs and the departments/individuals primarily responsible for them — a hierarchy from Level 1 (whole project) down to individual Tasks.

🌳
Memory hook — the WBS hierarchy
"Project → Function → Activity → Task"
Function: a management activity often spanning the whole project life (project management, risk management, change management). Activity: an element of work with expected duration/cost/resources — can be subdivided further. Task: the lowest level of work in the real schedule — typically too granular to show on a preliminary WBS.
WBS Types (three flavors)
Type Also called Used by / example
Process WBS Activity-oriented PM; e.g. Requirements, Analysis, Design, Testing
Product WBS Entity-oriented Engineering manager; e.g. Financial engine, Interface system
Hybrid WBS Both combined Lifecycle phases at high level, component/feature detail within — not unusual, since processes produce products
Process WBS rules of thumb
List of activities, not things. Items can come from the SOW (statement of work), proposal, brainstorming, stakeholders, team.

Describe activities using "bullet language" — meaningful but brief labels.

All WBS paths do not have to go to the same level. Do not plan more detail than you can manage.

WBS Techniques

how to actually build one
🏗️
Memory hook
"Top Bosses Ask Really Boldly"
Top-Down · Bottom-Up · Analogy · Rolling Wave · Brainstorming — and all five rely on Expert Judgment.
Technique How it works Best when
Top-Down Start at the overall goal/deliverable, break into major components then subcomponents. Start at the highest level, systematically increase detail. Problem well understood; technology/methodology not new; similar to an earlier project — but applied in the majority of situations anyway.
Bottom-Up Start by identifying detailed tasks, then group into higher-level categories/summaries. Pro: detailed. Con: time consuming, needs requirements to be more complete.
Analogy Use a WBS from a similar past project as a template, adapt to current context. Pro: based on past actual experience. Con: needs a comparable project.
Rolling Wave Plan at a high level initially, add detail as more information becomes available. 1st pass: 1–3 levels deep → gather more requirements/data → add detail later. Early phases of a project, or long projects where later detail can't be known yet.
Brainstorming Generate every activity you can think of, then group into categories. Can be combined with Top-Down on the same WBS. Get the people who'll do the work involved — buy-in matters.
Work Packages (Tasks) — sizing rules
Generic term for a discrete unit of work with definable end results — the basis for monitoring & reporting progress (can tie to budget/charge numbers, has resources assigned).

The "1-to-2" rule: often sized for 1–2 persons for 1–2 weeks.
The "4/40" or "8/80" rule: shortest/longest duration — size from 4 to 40 hours to avoid micromanagement, or up to 80 max to ensure visibility.

Ideally shorter rather than longer — longer packages need subjective in-progress estimates, which are less trustworthy than a clean "done."
WBS Guidelines
Should be easy to understand. Some companies standardize schemes (e.g. Project Mgmt. is almost always a top-level item). What often hurts most is what's missing. Break down until you can generate accurate time & cost estimates. Ensure each element corresponds to a deliverable.
WBS is the basis for: network scheduling, costing, risk analysis, organizational structure, control, and measurement.

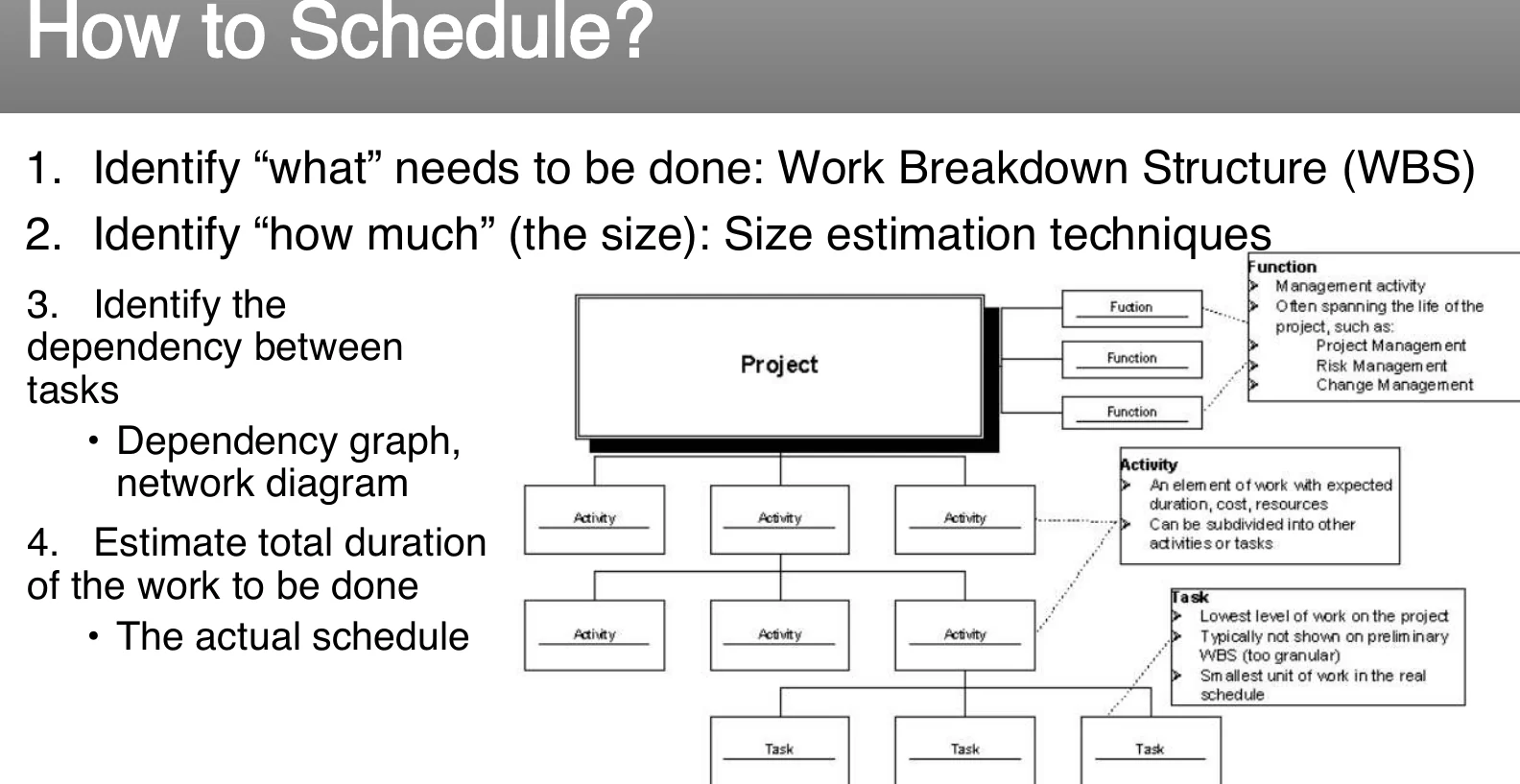

PDF page 5How to schedule: start from the work breakdown structure.

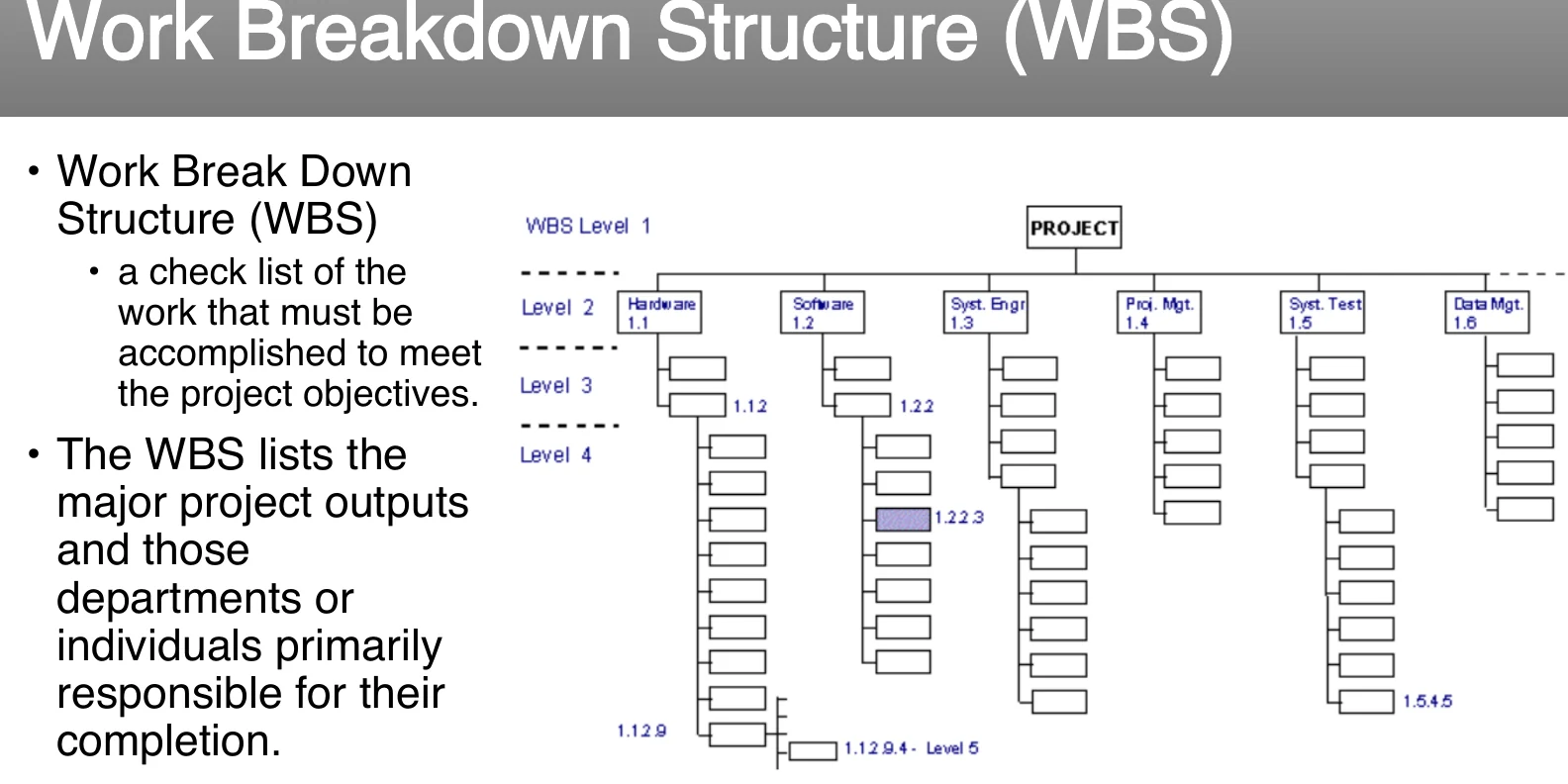

PDF page 9The work breakdown structure.
PDF page 10A WBS outline example.

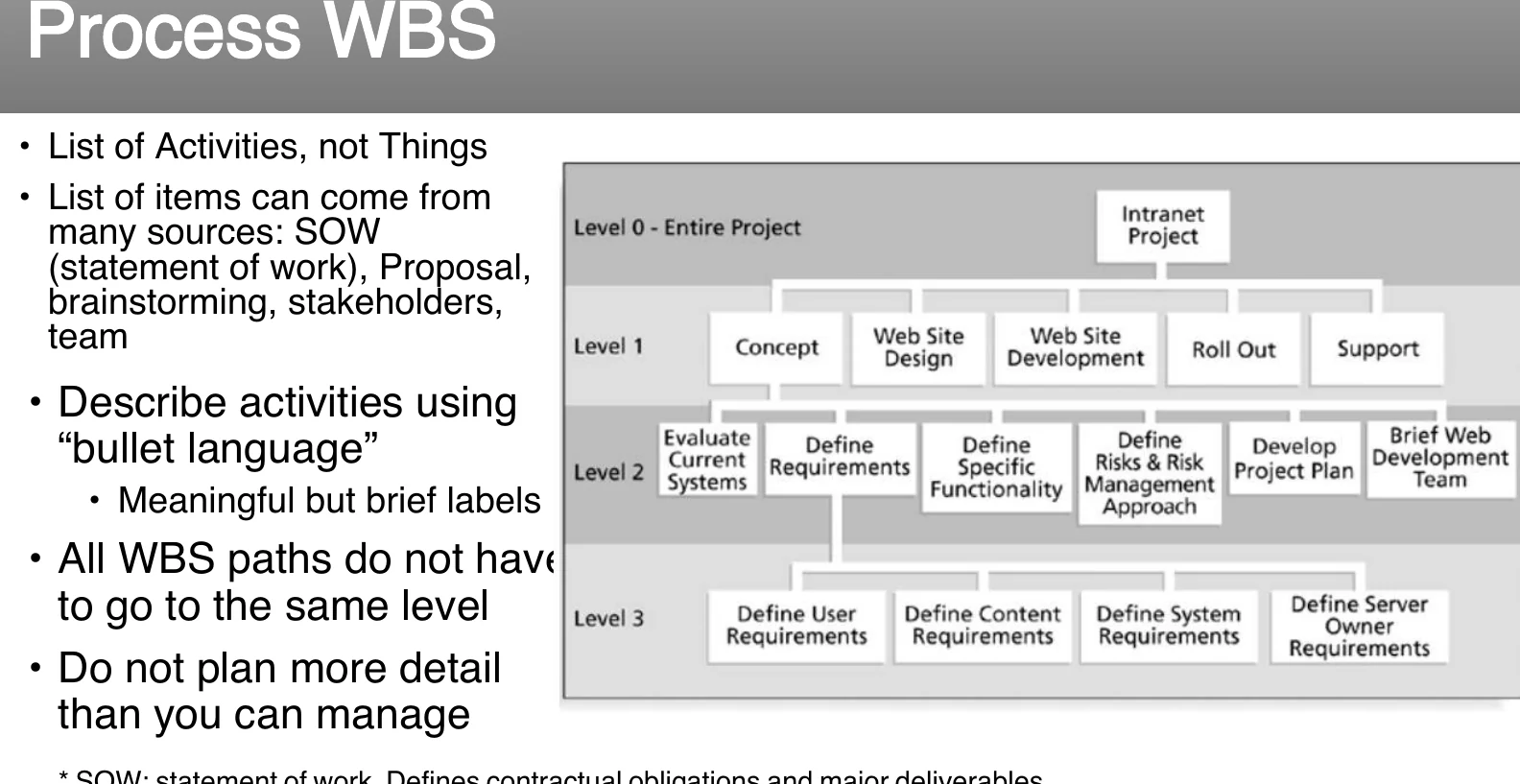

PDF page 12A process WBS.
§ 03 — NETWORK ANALYSIS

Turning dependencies into a diagram

Network analysis is the technique that generates the project schedule. It may combine several methods: Gantt Charts, the Critical Path Method (CPM), the Critical Chain Method (CCM), what-if analysis, and resource leveling. The Precedence Diagram Method (PDM) is the graphical network technique used to establish activity sequencing.

Terminology

get these exact — exam-tested
Activity. Always consumes time, may also consume resources (task and activity are used equivalently).
Critical. A critical activity/event must be achieved by a certain time — it has no latitude (slack/float).
Critical path. The longest path through a project network. Because it has no slack, all activities on it must complete as scheduled or the end date slips.
Events. The beginning and ending points of activities — a specific point in time.
Milestone. An event representing a point of special significance in a project — usually completion of a major phase. Project reviews are often conducted at milestones.
⏳
Memory hook
"Longest path wins — and it never gets a day off."
The critical path is the longest, not the most important-looking, path. It has zero slack by definition — that's the whole test for whether a task is on it.
Creating a precedence table
Documents task durations and interdependencies. Include a duration estimate per task — any risky task (technology, skills, dependencies) should carry a contingency factor. Determine predecessor/successor relations as a team effort — this also surfaces possible parallel tasks that can shorten the schedule.
Sample precedence table
Task Duration Dependencies
A — Architecture & design strategy 9 start
B — Decide on number of releases 5 A
C — Develop acceptance test plan 7 A
D — Develop customer support plan 11 B, C
E — Final sizing & costing 8 D
The precedence network diagram (redrawn)

A graphic model portraying the sequential relationship between key events — it communicates the plan of action to the team and the client clearly and precisely. This exact table/diagram is reused as the running example for PERT and CPM below.

Start A B C D E End 9 9 5 7 11 8

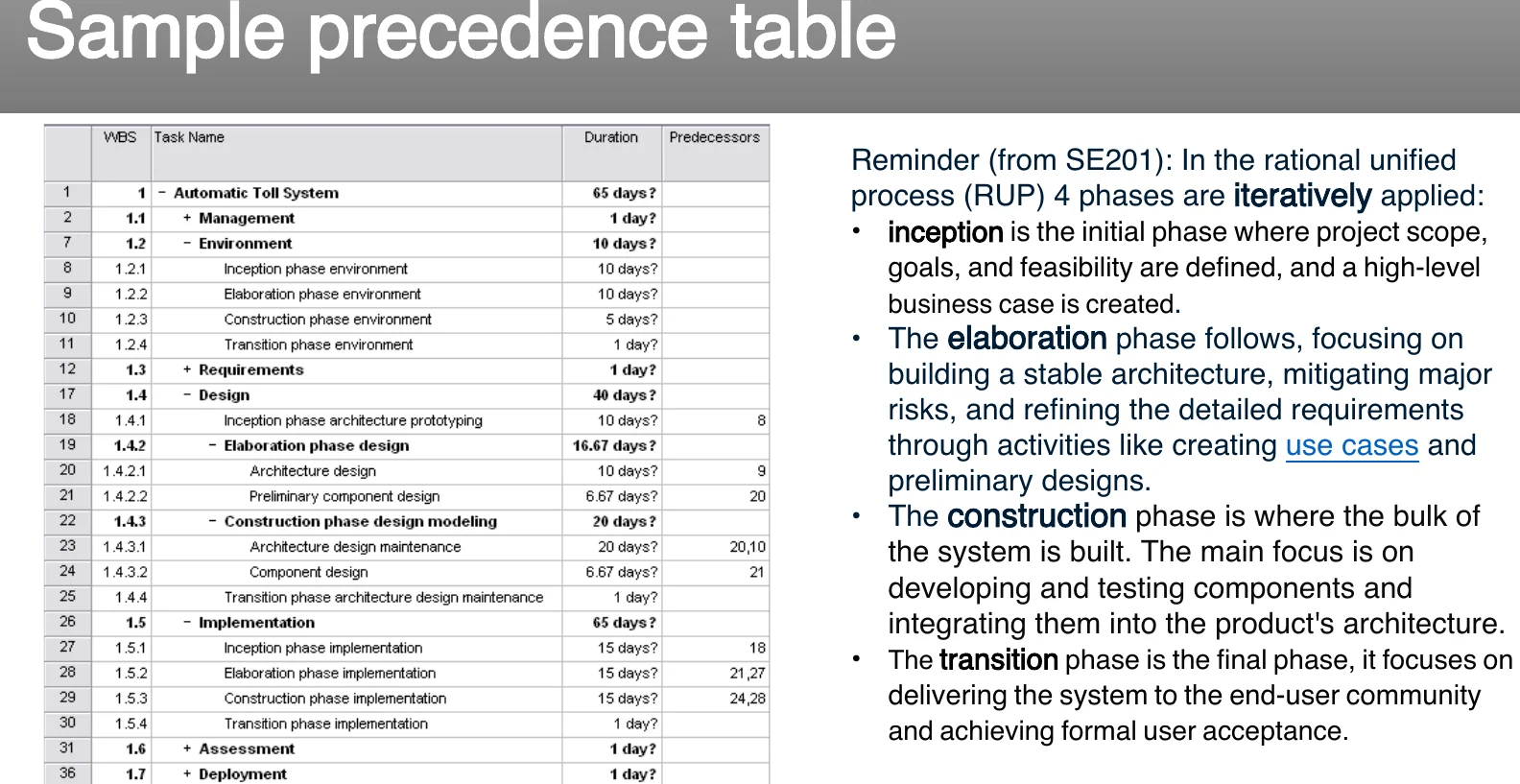

PDF page 27A sample precedence table.

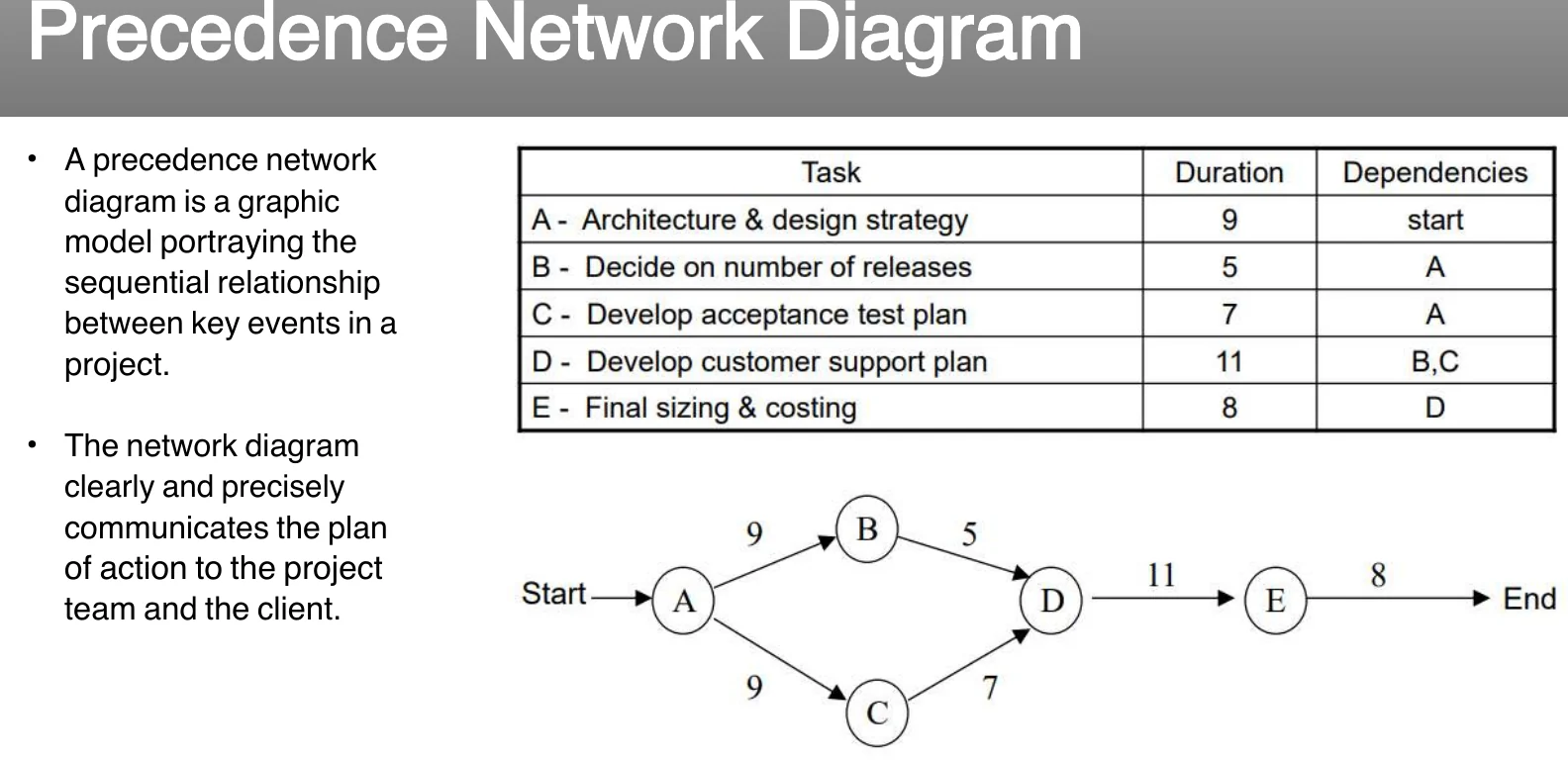

PDF page 28The precedence network diagram.
§ 04 — PERT ESTIMATION TECHNIQUE

Three numbers instead of one guess

Program Evaluation & Review Technique (PERT) was developed to handle uncertainty in activity durations, by asking for three time estimates instead of a single confident (and usually wrong) one.

📐
Memory hook
"Optimist once, Realist four times, Pessimist once — divide by six."
The most likely time gets 4x the weight of the optimistic or pessimistic ones. That's why the denominator is 6 (1 + 4 + 1).
TE = (Eoptimistic + 4·Emost likely + Epessimistic) / 6
TE = PERT activity duration estimate (expected time)
sE = (Epessimistic − Eoptimistic) / 6
standard deviation — measures the uncertainty / variability in the estimate. (Standard deviation itself is a statistical metric for how spread out data points are from the mean.)
The three estimate points
Most likely (M): the estimate that occurs with greatest frequency.
Optimistic (O): shortest duration — taken as the 10th percentile value.
Pessimistic (P): longest duration — taken as the 90th percentile value.
Worked example (from the slides)
Activity R→S has O=2, M=4, P=5.
TE = (2 + 4×4 + 5) / 6 = 23 / 6 = 3.8
PERT chart conventions
Numbered rectangles/nodes = events or milestones. Directional arrows = dependent tasks that must complete sequentially. Diverging arrows from one node (e.g. 1→2 and 1→3) = possibly concurrent tasks. Dotted lines = a "dummy activity" — a dependency that does not require resources or time, used purely to preserve correct network logic (e.g. showing that "user test" needs both "training" and "conversion" done, without drawing a real task for it).

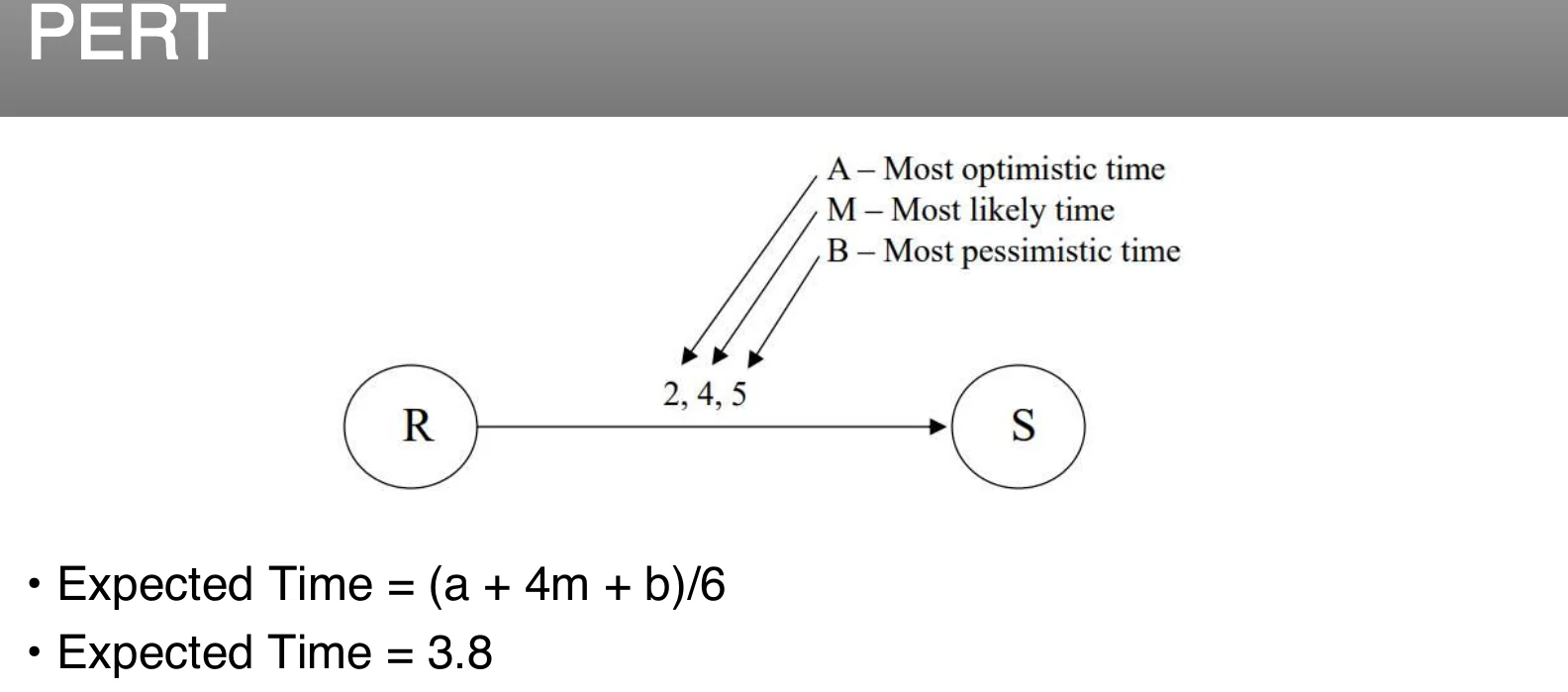

PDF page 31PERT: three estimates instead of one.

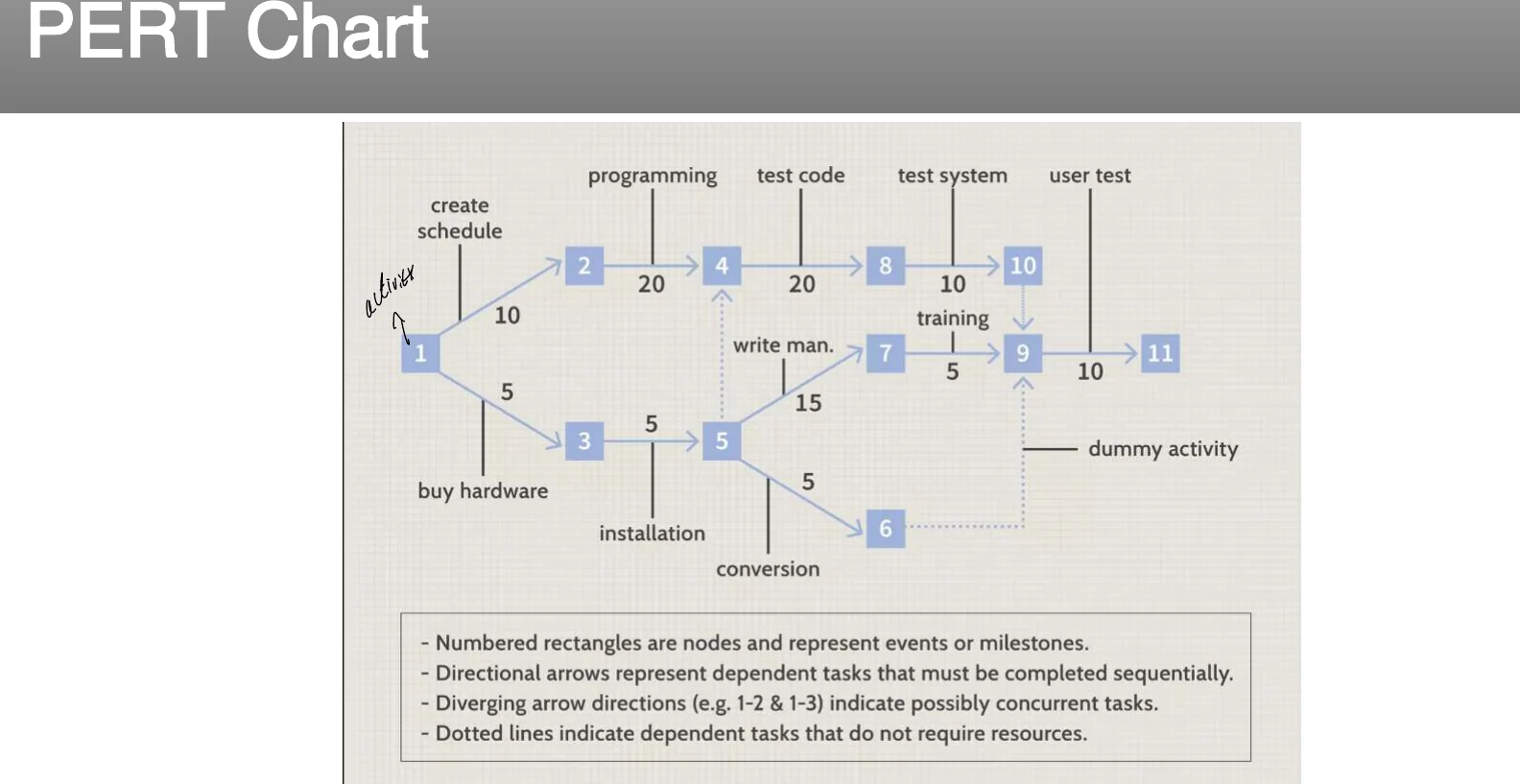

PDF page 32A PERT chart.
§ 05 — CRITICAL PATH METHOD (CPM)

Forward pass, backward pass, and the zero-slack test

CPM calculates theoretical start/finish dates for every activity without regard for resource limitations — which can cause resource over-allocation or inefficient multitasking (that gap is exactly what the Critical Chain Method fixes later).

Forward pass vs. backward pass
Forward pass: schedule calculations that identify the early start (ES) and early finish (EF) dates of activities and the project.

Backward pass: schedule calculations that identify the late start (LS) and late finish (LF) dates, plus total and free float.
Total float vs. free float
Total float (TF): how long an activity can be delayed without delaying the whole project. Global to the project.

Free float (FF): how long an activity can be delayed without delaying its successor activities. Local to the activity's neighborhood.
🎯
Memory hook
"Slack = wiggle room. Zero slack = no wiggle room = critical."
Slack time (float) = the amount of delay tolerable in an activity's start/finish without delaying project completion. Slack = LF − EF (or LS − ES). The sequence of activities with zero slack is, by definition, the critical path. If a non-critical activity (slack > 0) gets delayed past its late finish, it becomes critical and the completion date slips.
Worked example — full forward/backward pass

Same network as §03 (A=9, B=5, C=7, D=11, E=8; B and C both depend on A; D depends on both B and C; E depends on D).

Task Duration Depends on Early Start Early Finish Late Start Late Finish Slack
A 9 none 0 9 0 9 0
B 5 A 9 14 11 16 2
C 7 A 9 16 9 16 0
D 11 B, C 16 27 16 27 0
E 8 D 27 35 27 35 0
Reading the table: D can't start until both its predecessors finish, so its Early Start = max(B's EF=14, C's EF=16) = 16 — the later branch wins. Working backward from the project end (35), only B has room to slip (2 units) before it would force D to start late.

Critical Path = A – C – D – E (35 time units total) · Critical Tasks = A, C, D, E · Non-critical path = A-B-D-E · Non-critical task = B only (2 units of slack time).
What CPM answers: (1) What is the duration of the project? (2) By how much will the project be delayed if any one activity takes N days longer? (3) How long can certain activities be postponed without increasing total project duration?

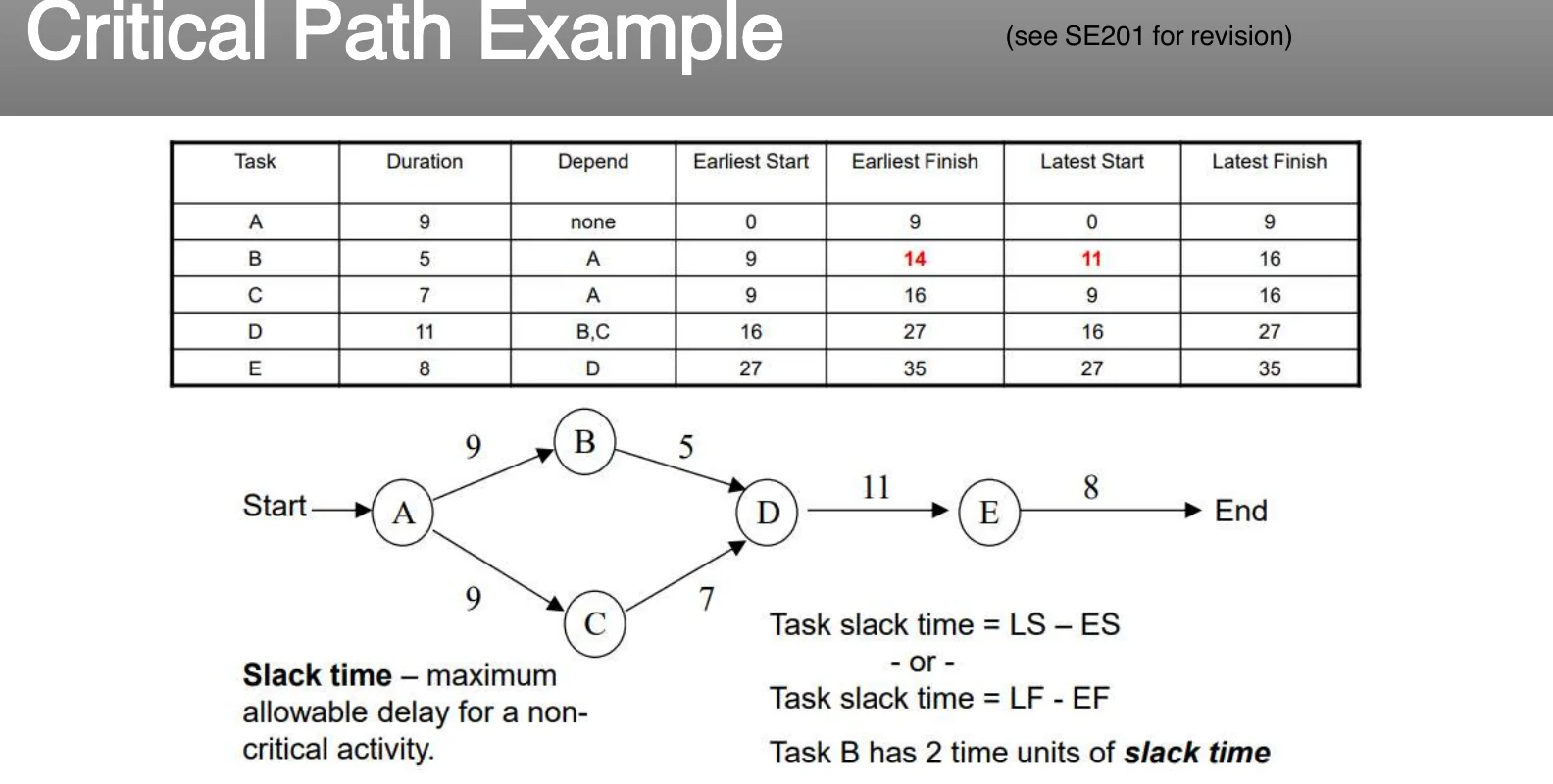

PDF page 37A critical path example with slack.
§ 06 — GANTT CHARTS

The chart everyone reads, the chart that hides dependencies

A Gantt Chart (named for Henry Laurence Gantt) is a table of task information plus a horizontal bar chart showing schedule against time — used constantly for planning and tracking, but with real limits.

Advantages
Easy to understand. Easy to change. Can show planned vs. actual progress and task dependencies.
Disadvantages
Very low information density — lots of wasted space, not very useful for large projects. Only a vague description of the project. Does not always show interdependency of activities, and may not reveal the results of an early or late start.
Worked example — the exam-style dependency puzzle
A, B, C, D, E. A and B have no preceding activities. C requires B complete first. D cannot start until both A and B are complete. E requires both A and C complete. Durations: A=9, B=3, C=9, D=5, E=4. Question: what's the shortest time to complete the project, and which activities are critical?
Without a graphical picture of the dependencies, you cannot identify the critical path from the duration list alone — this is exactly why network diagrams exist, not just Gantt bars. Working it out: A runs 0–9. B runs 0–3. C (needs B) runs 3–12. D (needs A & B, so starts at max(9,3)=9) runs 9–14. E (needs A & C, so starts at max(9,12)=12) runs 12–16. Total time = 16 days. Critical chain = B → C → E (3+9+4=16); A and D both finish early and carry slack.
Task
1-45-89-1213-16
A (9d)
B (3d)
C (9d)
D (5d)
E (4d)
Gold bars = the critical chain (B→C→E, 16 days). Blue bars = non-critical, they carry slack.

PDF page 39The Gantt chart.

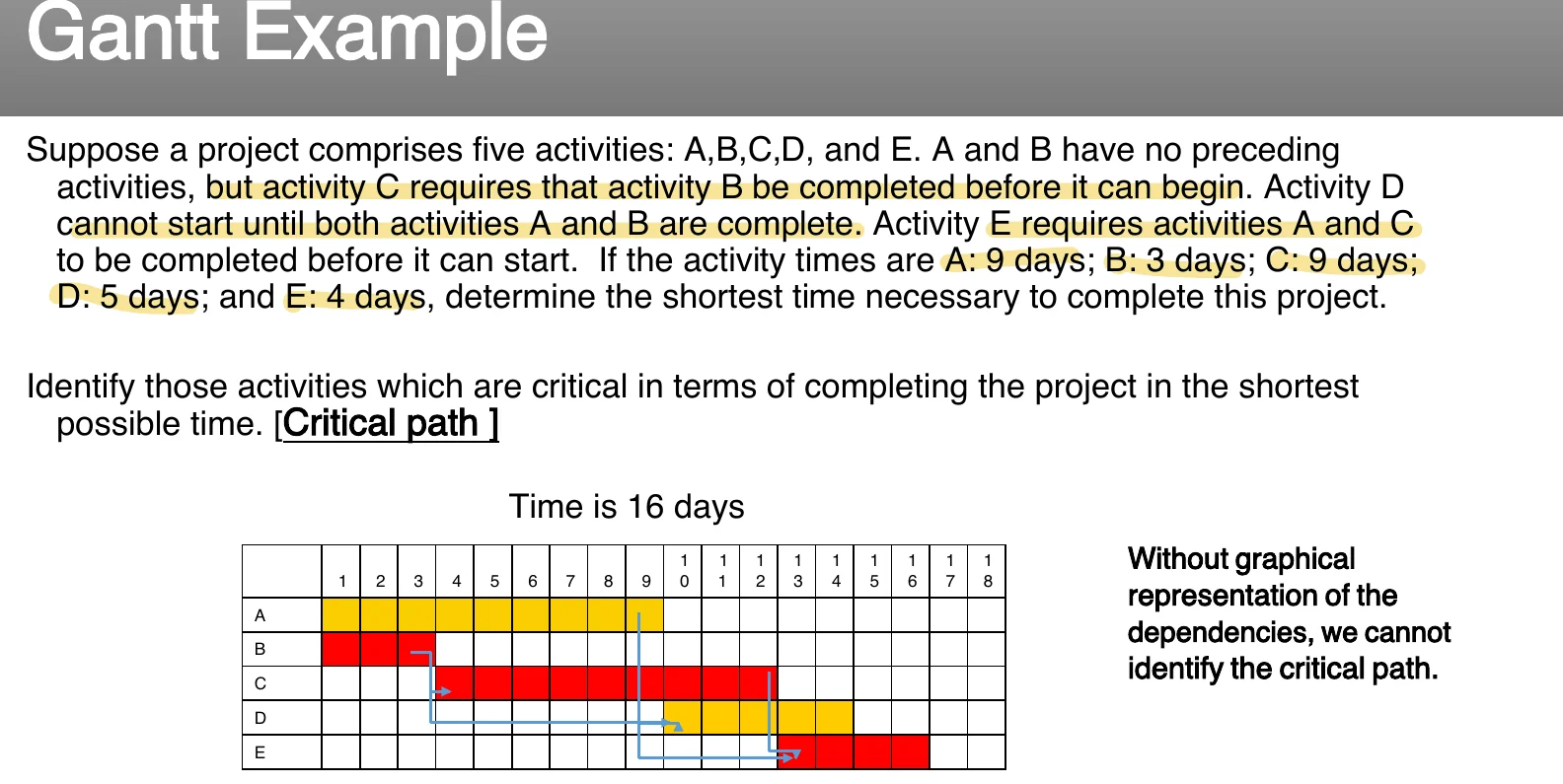

PDF page 41A worked Gantt example.
§ 07 — CRITICAL CHAIN METHOD (CCM)

CPM's sequel: now with actual resource limits

The Critical Chain Method improves on CPM by accounting for resource availability — CPM computes dates as if every resource were infinitely available, CCM does not.

Core idea
CCM focuses on the resources required for activities, trying to keep them leveled throughout the project. It assumes all activities have a statistically-probable range of durations, and uses that to build a more flexible, resilient schedule. Resources are assigned using most likely durations. The longest resource-constrained sequence of activities is called the critical chain (vs. the resource-blind critical path in CPM).
Worked scenario (mobile app, 6-month timeline)
1. Identify critical tasks — e.g. UI development, external API integration, testing. 2. Estimate task duration, accounting for potential delays. 3. Create a buffer at the end of the timeline to protect the deadline even if some tasks run long. 4. Manage the critical chain — reallocate resources, adjust priorities as needed. 5. Monitor progress continuously and adjust the plan.
🛡️
Memory hook — the three buffer types
"Please Feed Resources"
Project buffer (contingency for the whole project, inserted at the very end — a delay in the longest path eats into this) · Feeding buffer (inserted where a non-critical chain feeds into the critical chain, so upstream slippage doesn't touch the critical chain) · Resource buffer (alerts/placeholders ensuring critical resources are ready exactly when needed).
Tasks are sequenced to avoid resource conflicts (no multitasking), ensuring shared resources aren't double-booked — that resource-awareness is CCM's entire reason for existing over plain CPM.

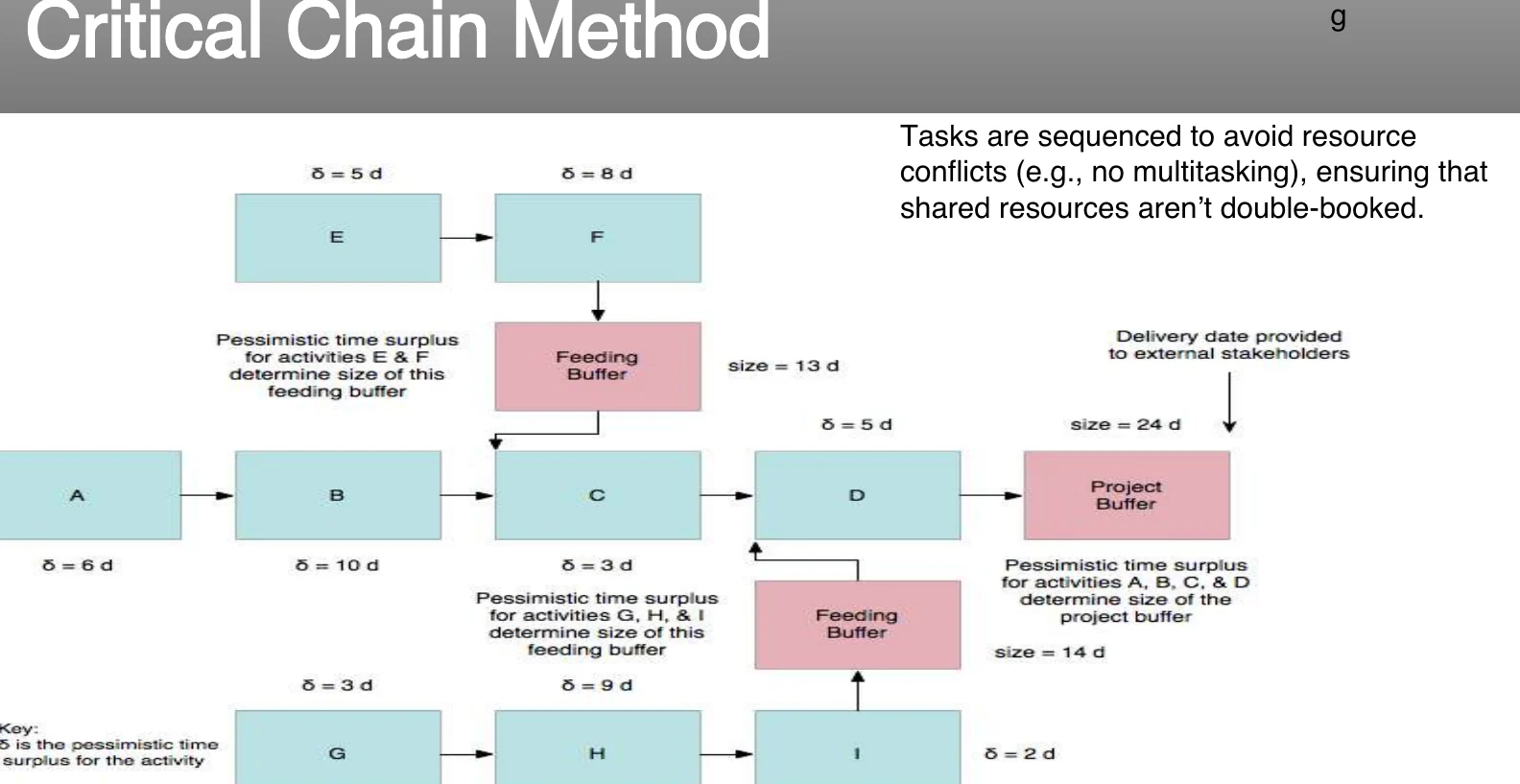

PDF page 46The critical chain method with buffers.
§ 08 — REFINING THE SCHEDULE MODEL

What-if analysis, resource leveling, leads & lags, calendars

What-if analysis
A scenario-based analysis of the schedule to determine the effect of various scenarios on the project — e.g. delaying delivery of a critical component by various amounts, or asking "what if the COTS supplier can't provide it at all?" The most common technique uses Monte Carlo simulation to generate a population of possible schedule outcomes — like running the same project 10,000 times with the same resources, different boundary conditions, and no memory between runs. Very useful for contingency and risk response planning.
Resource leveling
Applied to a schedule already analyzed by CPM, to address resource availability being constrained by time or amount, or to keep resource usage constant. Needed when resources are over-allocated or double-booked. May change the critical path in the schedule model. Approaches: assign under-allocated resources to multiple tasks; move key resources off non-critical tasks; delay a task's start until resources are free (possibly using lags); split tasks into subtasks assignable to different resources.
Leads and lags

Refines a schedule once the major network-analysis effort is done — used to meet imposed constraints, help resource leveling, or build in contingency reserves.

Lead time: Task B starts before Task A finishes — the tasks overlap.
Lag time: Task B starts some time after Task A finishes — a deliberate gap/delay is inserted.
Calendars
Identify the days/dates when work can actually be performed.

General project calendars govern overall limits on when project work may happen (e.g. client site shuts down for 3 weeks in summer).

Resource calendars govern limits on when a particular resource/resource group may work (e.g. individual vacation schedules, team training schedules).
Schedule development output
🕸️

Project schedule network diagrams

Shows both network logic (sequencing) and critical-path schedule activities — usually as an activity-on-node diagram.

📊

Gantt charts

Specialized bar-chart format for start/end dates and durations — easy to read, limited by low information density.

🚩

Milestone charts

A "stripped-down" version of a Gantt chart, showing only milestones.

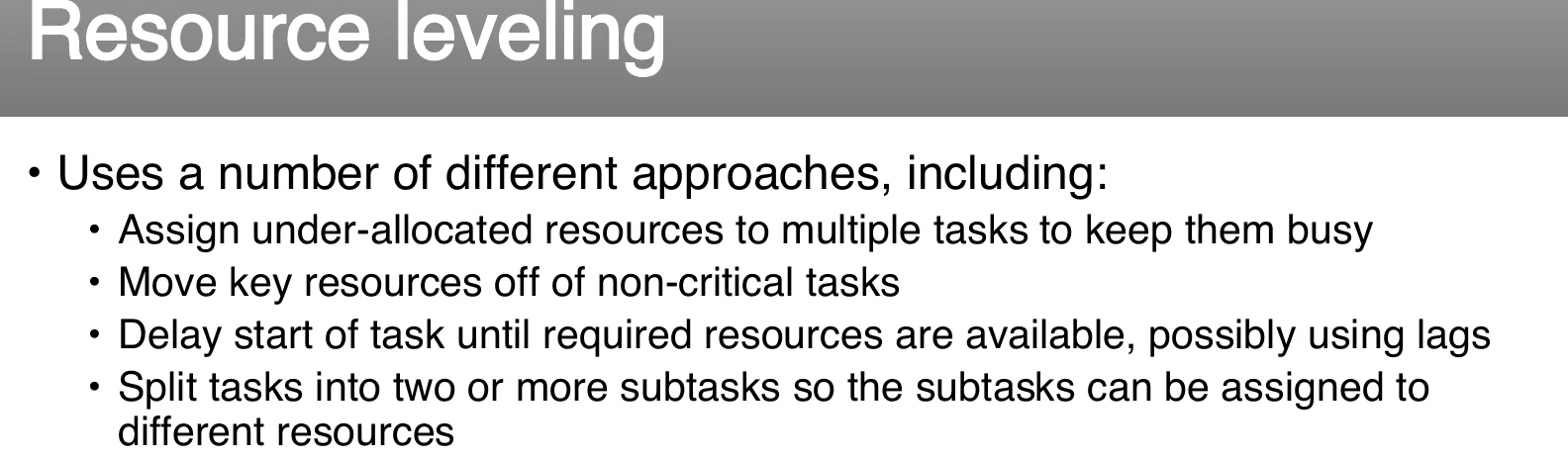

PDF page 49Resource leveling.

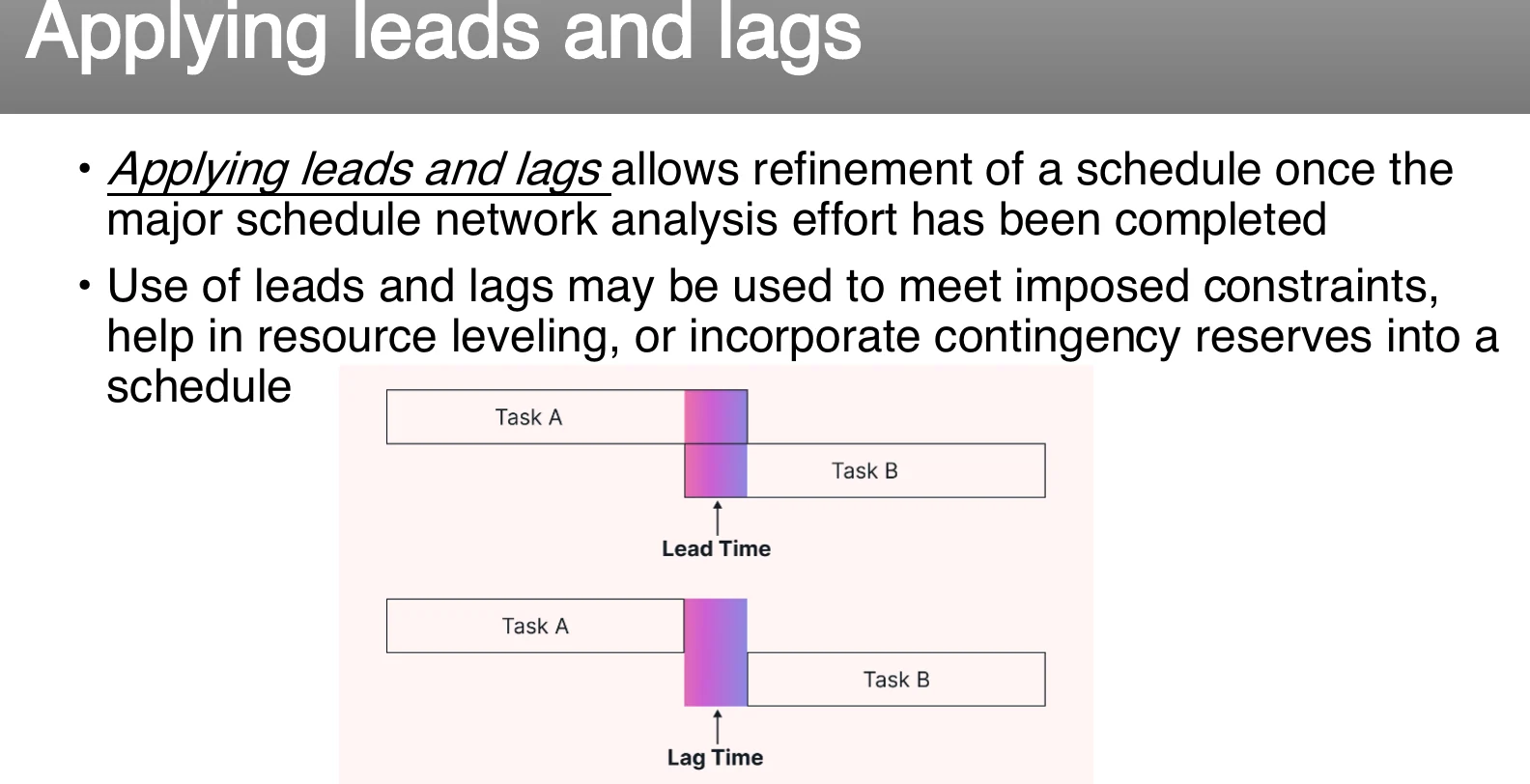

PDF page 50Applying leads and lags.

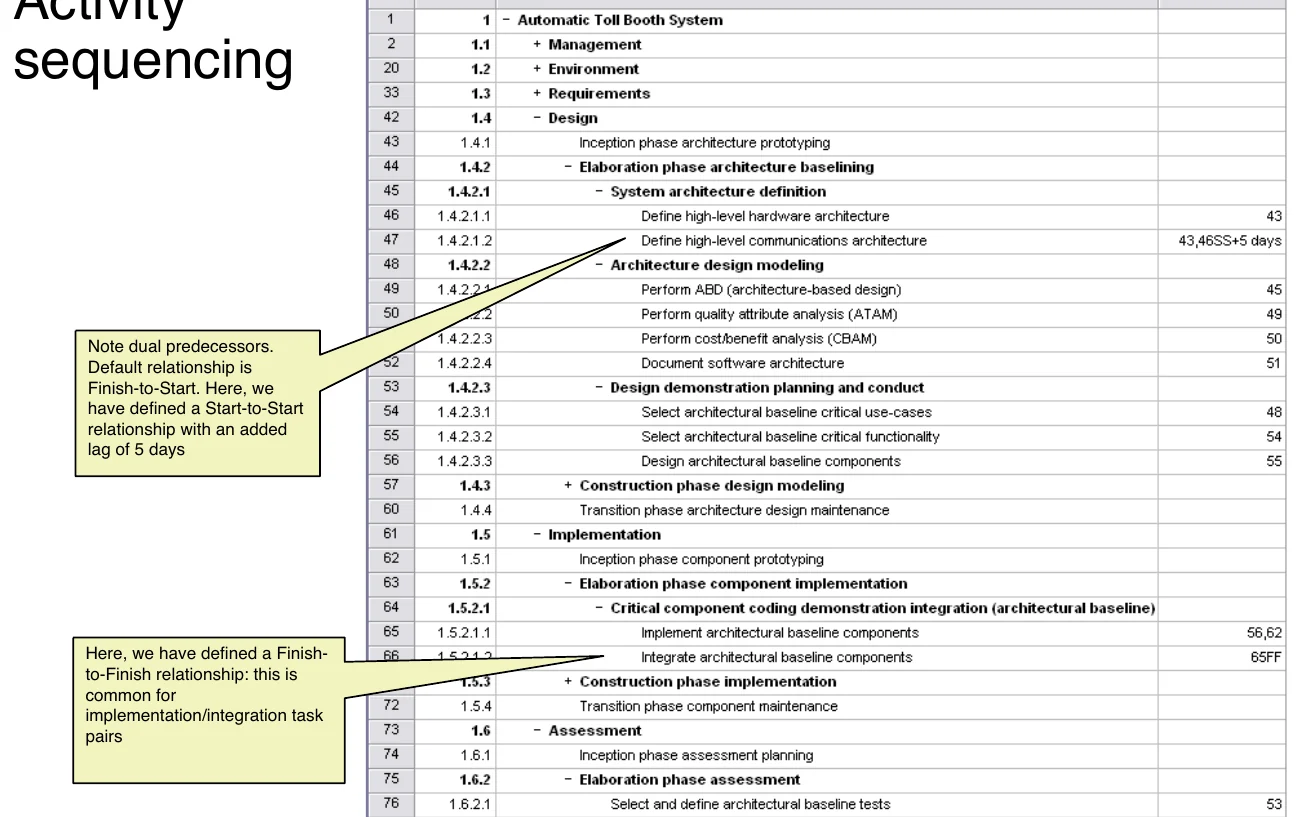

PDF page 65Activity sequencing.

PDF page 68Determining resource utilization.
§ 09 — REDUCING PROJECT DURATION

Crashing, fast-tracking, and why "just add people" backfires

Four levers to shorten a schedule: reduce scope (fewer outputs), add resources (more people), increase concurrency (parallel tasks), or substitute activities. Schedule compression specifically shortens the schedule without changing scope, to meet constraints, imposed dates, or other objectives.

Crashing
Analyzes cost/schedule trade-offs to get the greatest compression for the least cost: add resources to critical-path tasks, be more efficient, change the approach used, work overtime — or limit/reduce requirements, or resequence tasks.
Fast-tracking
Activities normally done sequentially are done in parallel instead. Only works when activities can actually overlap. Can lead to rework and increased risk from unforeseen dependencies — it trades safety for speed.
Boehm's limit: for both crashing and fast-tracking, you cannot compress a schedule by more than 25%.
🔥
Brooks's Law
"Adding manpower to a late software project makes it later."
From Fred Brooks's The Mythical Man-Month: "Cost varies as product of men and months, progress does not" — progress does not scale linearly. The man-month as a unit for measuring job size is a "dangerous and deceptive myth."
Why software project disaster is so common (Brooks)
Cause The trap The fix
Over-optimism "All programmers are over-optimists" — the false assumption that each task takes only as long as it "ought to." Consider the larger probabilities.
Confusing effort with progress Assuming you can just throw more people at a problem and get linear acceleration. Don't assume adding people will solve the problem.
No pushback on deadlines Managers accept unrealistic deadlines or vague estimates instead of defending the schedule. Good managers defend the integrity of the schedule, even when unpopular.
Poor progress monitoring Without clear metrics, slippage goes unnoticed until too late. Use objective, measurable checkpoints.
Adding manpower when slipping Like dousing a fire with gasoline — Brooks's Law. Reallocate/replan instead of just adding bodies.
The communication-overhead math
channels = n(n − 1) / 2 → O(n²)
n = number of team members. Every person you add doesn't just add their own output — it adds a new communication link to everyone already there.
A 12-month project: 1 person → 12 months. 2 people → 7 months (2 man-months of overhead "lost"). 3 people → 5 months (3 man-months lost). Adding people has diminishing — and eventually negative — returns.
The most mis-scheduled phase: testing
Testing is the most linear process, so delays in earlier phases compress the time left for it. This is particularly bad because it happens late, without warning, and is expensive: primary cost = time/effort to fix bugs; secondary cost = rework, missed deadlines, reputational damage, or production failures. Fix: allocate more test time and understand that testing depends on completed, integrated components.
"Gutless estimating": estimators who don't push back on unrealistic deadlines. A project goes a year late "one day at a time" — via missed check-ins, untracked slippage, and quiet scope creep. Studies show each task actually takes twice as long as estimated, and only ~50% of the work week was actual programming. Fixes: no "fuzzy" milestones (avoid "almost done" — use measurable deliverables), reduce the role of conflict (honest dialogue between devs and managers), identify the "true status" via metrics/demos/tracking.

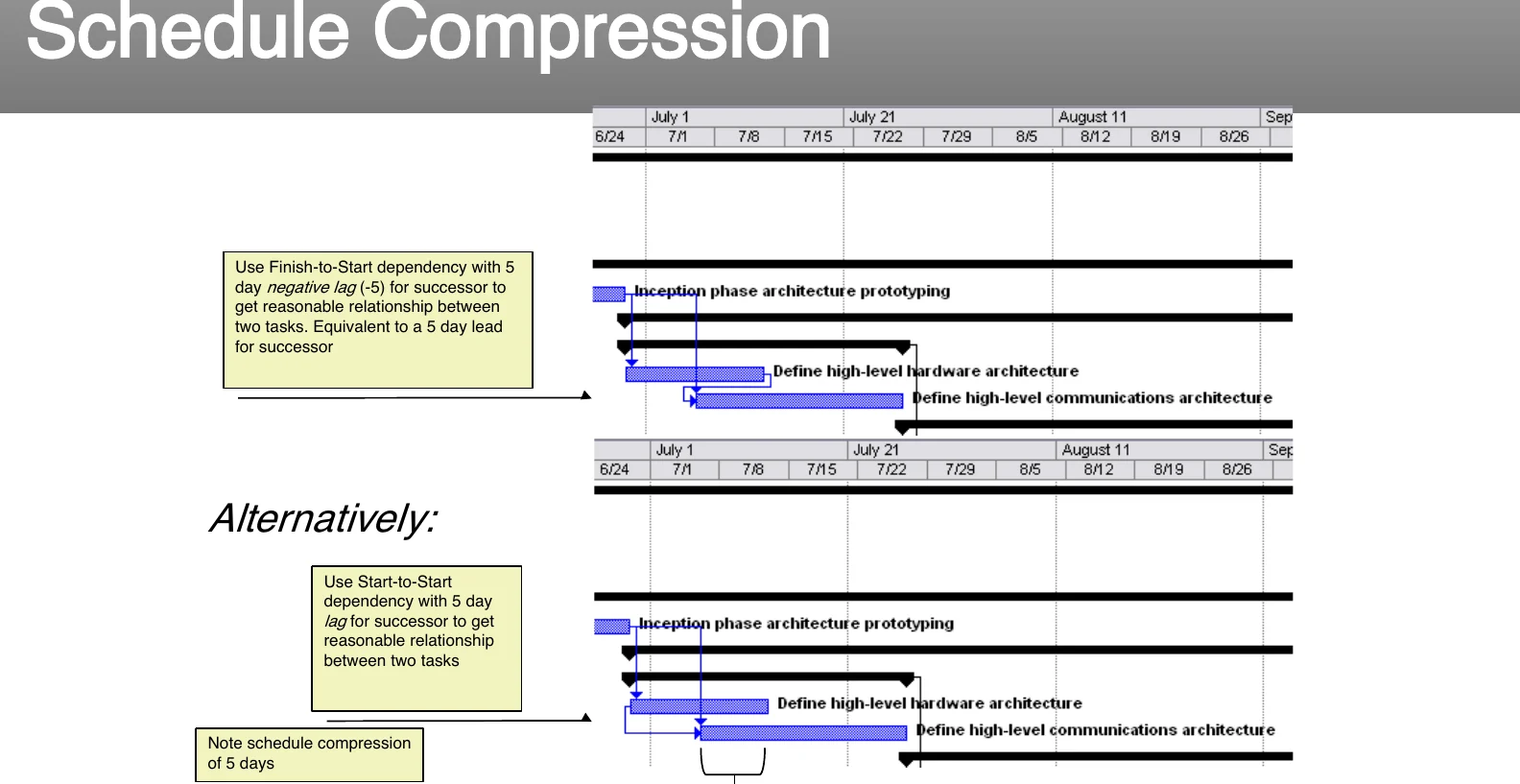

PDF page 67Schedule compression: crashing and fast-tracking.
🔁
The whole scheduling workflow, end to end
Define → Sequence → Estimate effort → Assign resources → Apply calendars → Estimate duration → Forward/backward pass → What-if → Level resources → Compress if needed
Define activities (WBS template helps) → sequence what's logically possible (resource allocation comes later) → estimate effort in labor units (e.g. staff-days) → identify resources per activity → apply calendars to the framework → estimate duration based on assigned resources → run forward/backward pass CPM to build the schedule model → run what-if scenario analysis for contingency/risk response → apply resource leveling → apply schedule compression only if still needed.
§ 10 — PROJECT TRACKING

"On schedule" is a number, not a feeling

Tracking uses monitoring and tools to determine whether plans, estimates, and schedules are actually accurate — replacing "I think we're fine" with a metric.

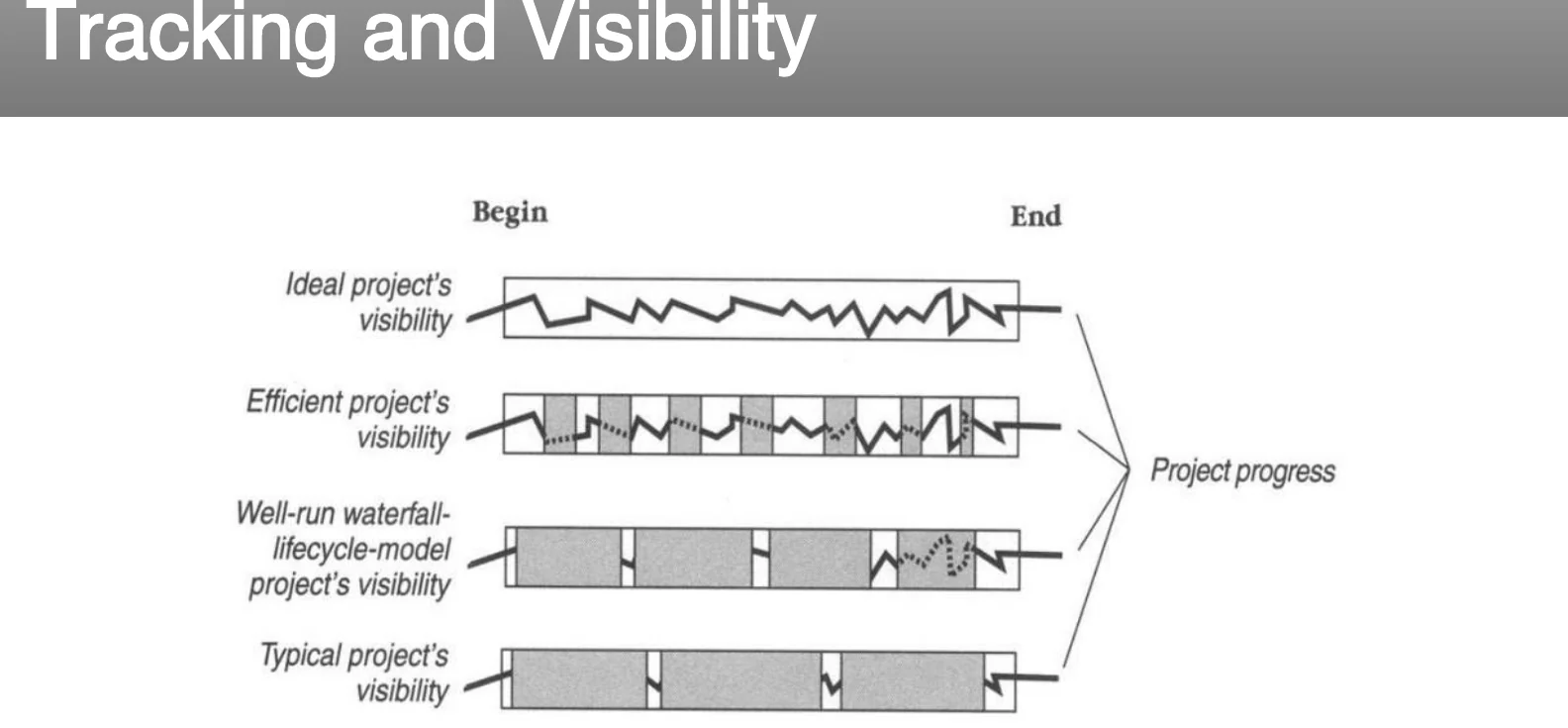

Tracking and visibility
Compare an ideal project's visibility (constant, granular signal throughout) against an efficient project (frequent but lighter check-ins), a well-run waterfall project (visibility concentrated near phase boundaries, murky in between), and a typical project (visibility only at a few widely-spaced points — the riskiest pattern, since problems can hide for a long time before anyone notices).
The "Illusion of Progress" — percent complete
Early phases (design/specification) finishing first can create a false sense of completion. A task-count view can suggest ~50% done, while the most effort-intensive, risk-prone phases (coding, testing) are still underway or not even started.

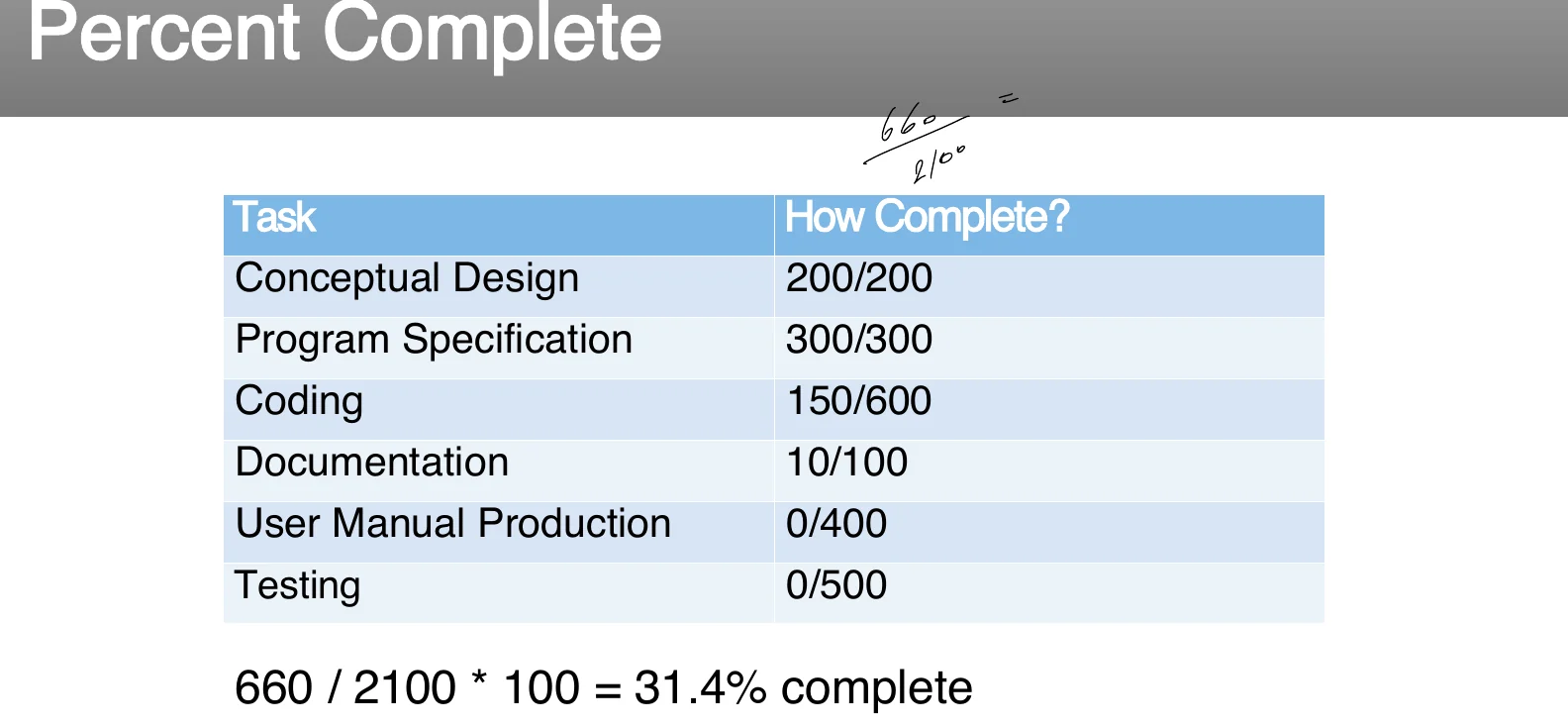

Naïve view — task status only
Task Complete?
Conceptual Design Complete
Program Specification Complete
Coding In Progress
Documentation In Progress
User Manual Production Not Started
Testing Not Started
Honest view — effort-weighted
Task Hours complete / total
Conceptual Design 200 / 200
Program Specification 300 / 300
Coding 150 / 600
Documentation 10 / 100
User Manual Production 0 / 400
Testing 0 / 500
660 / 2100 × 100 = 31.4% complete — nowhere near the "half done" impression the task list gave.
Earned Value Management (EVM)

EVM is a project control methodology that integrates scope, schedule, and cost. It provides a quantitative basis for measuring project performance, enables early detection of deviations, supports forecasting, and gives a consistent way to talk about progress.

💰
Memory hook — the five EVM metrics
"Planners Earn Actual Cost Speed"
PV (Planned Value) · EV (Earned Value) · AC (Actual Cost) · CPI (Cost Performance Index) · SPI (Schedule Performance Index).
Metric Definition Formula
PV — Planned Value Budgeted cost of work scheduled % planned × total budget
EV — Earned Value Budgeted cost of work performed % complete × total budget
AC — Actual Cost Actual cost incurred for work performed tracked from financials
CPI — Cost Performance Index Cost efficiency EV ÷ AC
SPI — Schedule Performance Index Schedule efficiency EV ÷ PV
Variance formulas: CV (Cost Variance) = EV − AC  ·  SV (Schedule Variance) = EV − PV. On an exam, you may be given some values and asked to calculate the rest.
Using Earned Value Tracking — the full workflow
Setup
1. Establish a WBS to divide the project into manageable components
2. Identify the activities required under each WBS element
3. Estimate the effort per activity (labor hours or cost)
4. Schedule tasks: start/end dates and resources
5. Assign planned value to each task
Execution
6. Update the schedule by reporting % complete per task
7. Record actual costs on activities (real expenditures)
8. Calculate EV metrics: EV, PV, AC, CPI, SPI
9. Analyze variance: CV = EV − AC; SV = EV − PV
10. Take corrective action: reallocate resources, adjust scope, revise schedule

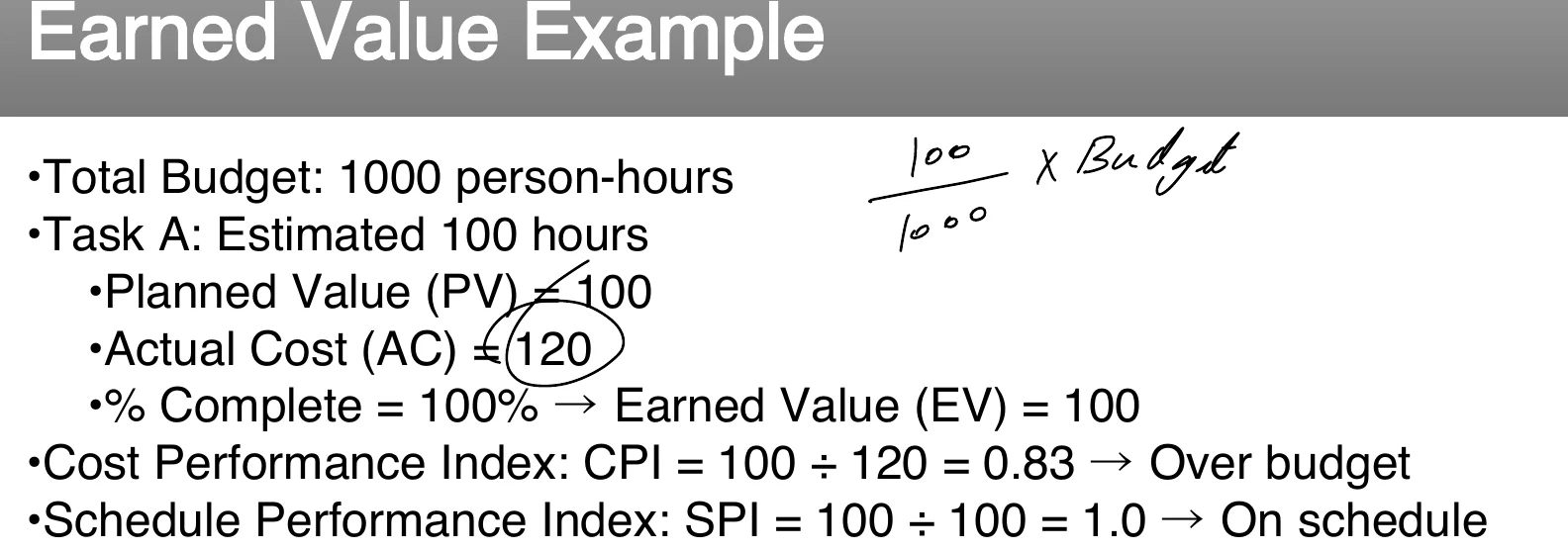

Worked example
Total Budget: 1000 person-hours. Task A estimated at 100 hours.
Planned Value (PV) = 100 · Actual Cost (AC) = 120 · % Complete = 100% → Earned Value (EV) = 100.
CPI = 100 ÷ 120 = 0.83 → over budget (you spent more than the work was worth).
SPI = 100 ÷ 100 = 1.0 → on schedule (exactly the work planned for this point got done).
Avoid "fuzzy" milestones: earned value credit is given only when a task is 100% complete — partially completed tasks are not given partial credit in most software projects. Break large tasks into subtasks (recall the 8–80 hour rule) so completions happen often enough to track. Use objective progress measures (demos, deliverables) and encourage honest reporting and team buy-in.
Agile companion metrics: velocity & burndown
Velocity = Σ (time estimated for each story completed in the iteration)
Uses story points as the effort unit in an Agile/iterative context.
If a team completes 10 stories in a two-week sprint, each worth 3 story points → velocity = 30 points/sprint. Velocity tends to stay fairly constant, so it's useful for forecasting: a 300-point backlog at 30 points/sprint needs 10 more sprints — at 2 weeks each, that's 20 more weeks. The customer picks which stories fill each iteration up to that velocity.

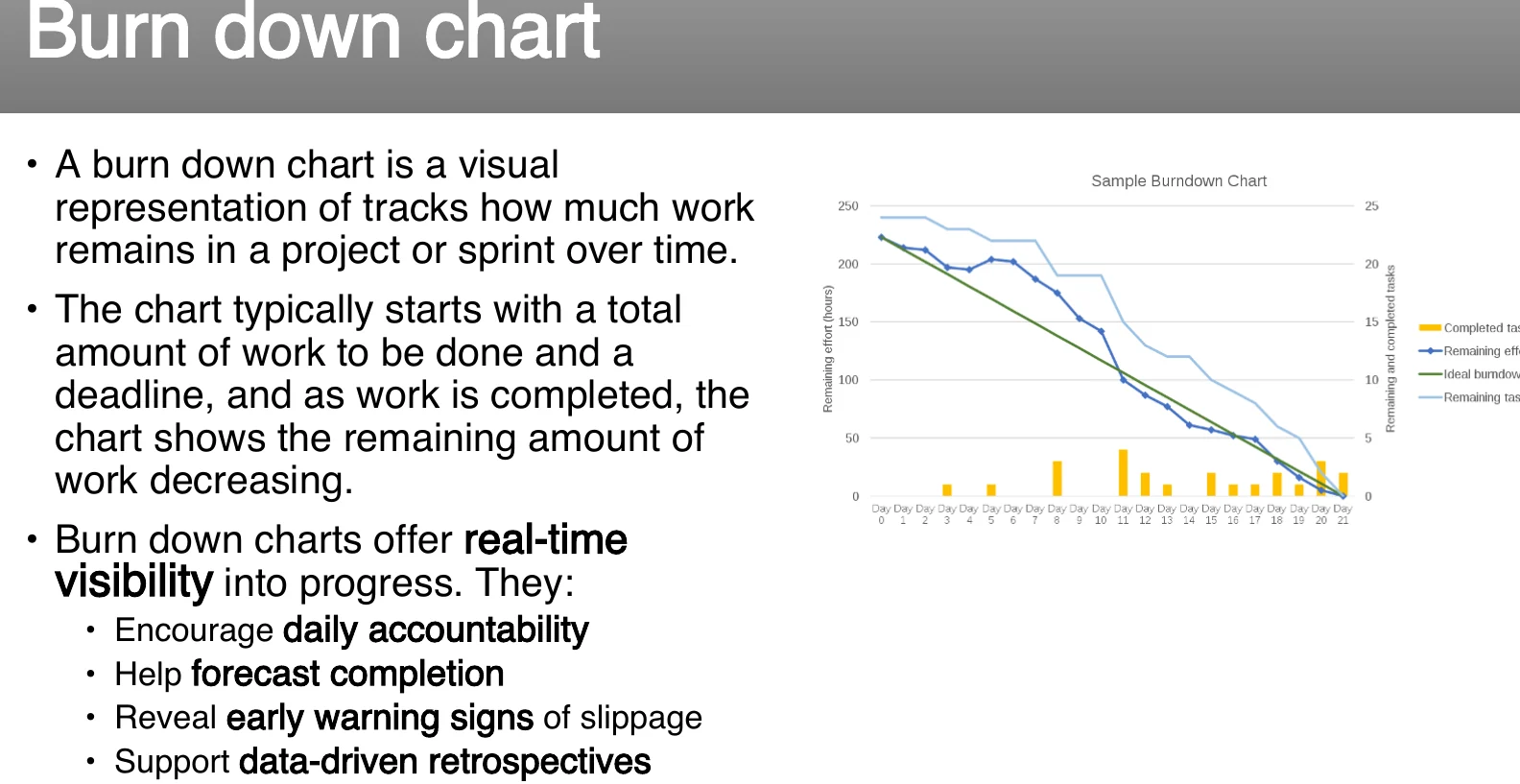

Burndown chart
A visual of how much work remains in a project/sprint over time — starts at total work, trends toward zero as work completes. Offers real-time visibility: encourages daily accountability, helps forecast completion, reveals early warning signs of slippage, and supports data-driven retrospectives.
PDF page 70Tracking and visibility over the project.
PDF page 72Percent complete, task by task.
PDF page 75A worked earned value example.
PDF page 79The burn down chart.
§ 11 — CHEAT SHEET

Every technique, one scan

Tool / Technique What it computes Key limitation
WBS Hierarchical checklist of all work (Function → Activity → Task) What's missing hurts most; don't over-plan detail you can't manage
Precedence / Network Diagram Sequential relationships between activities Doesn't itself give durations or the critical path — needs CPM/PERT on top
PERT TE = (O + 4M + P) / 6 — expected duration under uncertainty Still an estimate, not a guarantee; needs 3 honest inputs
CPM Forward/backward pass → ES, EF, LS, LF, slack → the critical path Ignores resource availability entirely
CCM Resource-constrained critical chain + buffers (project/feeding/resource) More complex to set up and maintain than plain CPM
Gantt Chart Visual bar timeline of activities vs. time Low information density; may hide dependencies
What-if / Monte Carlo Distribution of possible schedule outcomes under scenarios Only as good as the scenario assumptions fed in
Resource Leveling Smooths over-allocated resources Can change the critical path
Schedule Compression (crash/fast-track) Shortens duration without cutting scope Max ~25% (Boehm); fast-tracking adds rework risk
Earned Value (EVM) PV, EV, AC → CPI (cost efficiency), SPI (schedule efficiency) Needs 100%-complete task credit, not fuzzy estimates
Reading CPI & SPI at a glance
CPI > 1 / SPI > 1
Under budget / ahead of schedule. Good news — verify it's not from cutting corners.
CPI = 1 / SPI = 1
Exactly on plan. Rare, and worth double-checking the reporting isn't just fuzzy.
CPI < 1
Over budget — the work performed cost more than it was worth (e.g. 0.83 = paying $1.20 for $1.00 of value).
SPI < 1
Behind schedule — less work got done than was planned for this point in time.
§ 12 — COMMON MISTAKES

What actually gets missed on the exam

The specific wrong answers students give, concept by concept.

1. CPM vs. CCM — which one respects resource limits?
✗ WRONG"CPM already accounts for resource availability, so it's the same as CCM."
✓ RIGHTCPM calculates dates without regard for resource limitations. CCM is the one that focuses on resources and can lead to a different critical chain than CPM's critical path.
2. The PERT formula weighting
✗ WRONGTE = (O + M + P) / 3 — a plain average of the three estimates.
✓ RIGHTTE = (O + 4M + P) / 6 — most likely is weighted 4×, and the divisor is 6, not 3.
3. Total float vs. free float
✗ WRONGTreating "slack" as one single number that means the same thing everywhere in the network.
✓ RIGHTTotal float is global — how much an activity can slip without delaying the whole project. Free float is local — how much it can slip without delaying its immediate successor. They can differ.
4. Percent complete by task count
✗ WRONGCounting "2 of 6 phases done" as 33% complete.
✓ RIGHTWeight by effort/hours: 660 of 2100 total hours = 31.4% — early, cheap phases finishing first creates a false "illusion of progress" if you just count tasks.
5. CPI vs. SPI — which denominator is which?
✗ WRONGDividing EV by PV to get "cost performance," or EV by AC to get "schedule performance."
✓ RIGHTCPI = EV ÷ AC (cost efficiency — compares earned value to what was actually spent). SPI = EV ÷ PV (schedule efficiency — compares earned value to what was planned by now).
6. Crashing vs. fast-tracking
✗ WRONGUsing the terms interchangeably, or thinking fast-tracking means "add more people."
✓ RIGHTCrashing = add resources/cost to critical-path tasks (a cost/schedule trade-off). Fast-tracking = run normally-sequential activities in parallel — no extra cost, but real risk of rework from unforeseen dependencies.
7. "We're behind — let's add more developers"
✗ WRONGAssuming headcount scales output linearly, so 2× people finishes in half the time.
✓ RIGHTBrooks's Law: adding manpower to a late software project makes it later — new people need onboarding, and communication overhead grows as n(n−1)/2, i.e. O(n²).
8. Reading a critical path straight off a Gantt chart
✗ WRONGAssuming the longest-looking bar, or the bars in a Gantt chart alone, reveal the critical path.
✓ RIGHTWithout the dependency graph, you cannot identify the critical path from durations/bars alone — that's exactly what a precedence network diagram is for.
§ 13 — POP QUIZ

Click a question to reveal the answer

MC · Using the network A(9)→[B(5)/C(7)]→D(11)→E(8), what is the length of the critical path?
35 time units, along path A–C–D–E (9+7+11+8=35). Path A–B–D–E only totals 33, since B's early finish (14) is lower than C's (16) and D must wait for the later branch.
Short answer · An activity has O=6, M=9, P=18. What's its PERT expected time?
TE = (6 + 4×9 + 18) / 6 = (6+36+18)/6 = 60/6 = 10.
True / False · A Gantt chart, by itself, always clearly shows the interdependency of activities.
False. Gantt charts are listed with the explicit disadvantage that they "do not always show interdependency of activities" — that's what network diagrams are for.
MC · Which schedule-compression technique risks rework because it overlaps activities that would normally run sequentially?
Fast-tracking. Crashing instead adds resources/cost to critical-path tasks — it doesn't inherently overlap work.
Short answer · Given EV = 100, AC = 120, PV = 100, compute CPI and SPI, and interpret each.
CPI = 100÷120 = 0.83 → over budget. SPI = 100÷100 = 1.0 → exactly on schedule.
MC · For a 5-person team, how many communication channels exist by Brooks's formula?
n(n−1)/2 = 5×4/2 = 10 channels.
Short answer · What's the difference between total float and free float?
Total float: how long an activity can slip without delaying the whole project (global). Free float: how long it can slip without delaying its immediate successor activities (local).
MC · According to Boehm, what's the maximum you can compress a schedule via crashing or fast-tracking?
25%. Beyond that, neither technique is considered reliable.
§ 14 — PRACTICE LAB

Full worked problems, straight from the slide deck's own examples

Same shape as what shows up on the exam — worth drilling until automatic.

1. Project has activities A, B, C, D, E. A and B have no predecessors. C requires B complete. D requires both A and B complete. E requires both A and C complete. Durations: A=9, B=3, C=9, D=5, E=4. Find the shortest total project time and the critical activities.
→ 16 days; critical chain = B → C → E
Why: E can't start until max(A's finish=9, C's finish=12)=12, so E finishes at 16. That 16 is driven by the B→C→E chain (3+9+4=16), which beats the A→D chain (9+5=14) — so B, C, E are critical and A, D carry slack.
2. Given the effort-weighted table — Conceptual Design 200/200, Program Spec 300/300, Coding 150/600, Documentation 10/100, User Manual 0/400, Testing 0/500 — what is the true percent complete, and why might a naive "tasks done" count mislead you?
→ 660 / 2100 = 31.4% complete
Why: two of six tasks show "Complete," which naively suggests ~33-50% done — but those two tasks are cheap (200+300=500 of 2100 total hours). The expensive, risk-heavy phases (coding, testing) barely started, so effort-weighting gives the honest number.
3. Task A is budgeted for 100 hours out of a 1000-hour project. It is now 100% complete and actually cost 120 hours. Compute CPI and SPI and state whether the project is over/under budget and ahead/behind schedule.
→ CPI = 0.83 (over budget) · SPI = 1.0 (on schedule)
Why: PV=100 (planned), EV=100 (100% complete × 100 budgeted), AC=120 (actual spend). CPI=EV/AC=100/120=0.83 <1 → over budget. SPI=EV/PV=100/100=1.0 → exactly on schedule.
4. A team of 6 developers is being considered for a project. Using Brooks's communication-overhead formula, how many communication channels exist, and what does that imply about adding a 7th developer mid-project?
→ 6×5/2 = 15 channels at 6 people; adding a 7th raises it to 21
Why: channels = n(n−1)/2 grows quadratically (O(n²)). Adding the 7th person doesn't just add their output — it adds 6 new communication links, plus onboarding time, which is exactly why Brooks's Law says adding people to a late project makes it later.
5. A WBS lists top-level items as "Requirements," "Analysis," "Design," and "Testing." Is this a Process WBS or a Product WBS, and who typically uses this type?
→ Process WBS (activity-oriented)
Why: the top-level items are activities/phases, not deliverables/entities (a Product WBS would instead list things like "Financial engine" or "Interface system"). Process WBS is typically used by the PM.
