- Management spectrum: the 4 Ps: People, Product, Process, Project.
- Stakeholders: senior managers, project managers, practitioners, customers, end users.
- Scope: context, information objectives, function and performance. Bounded before estimation.

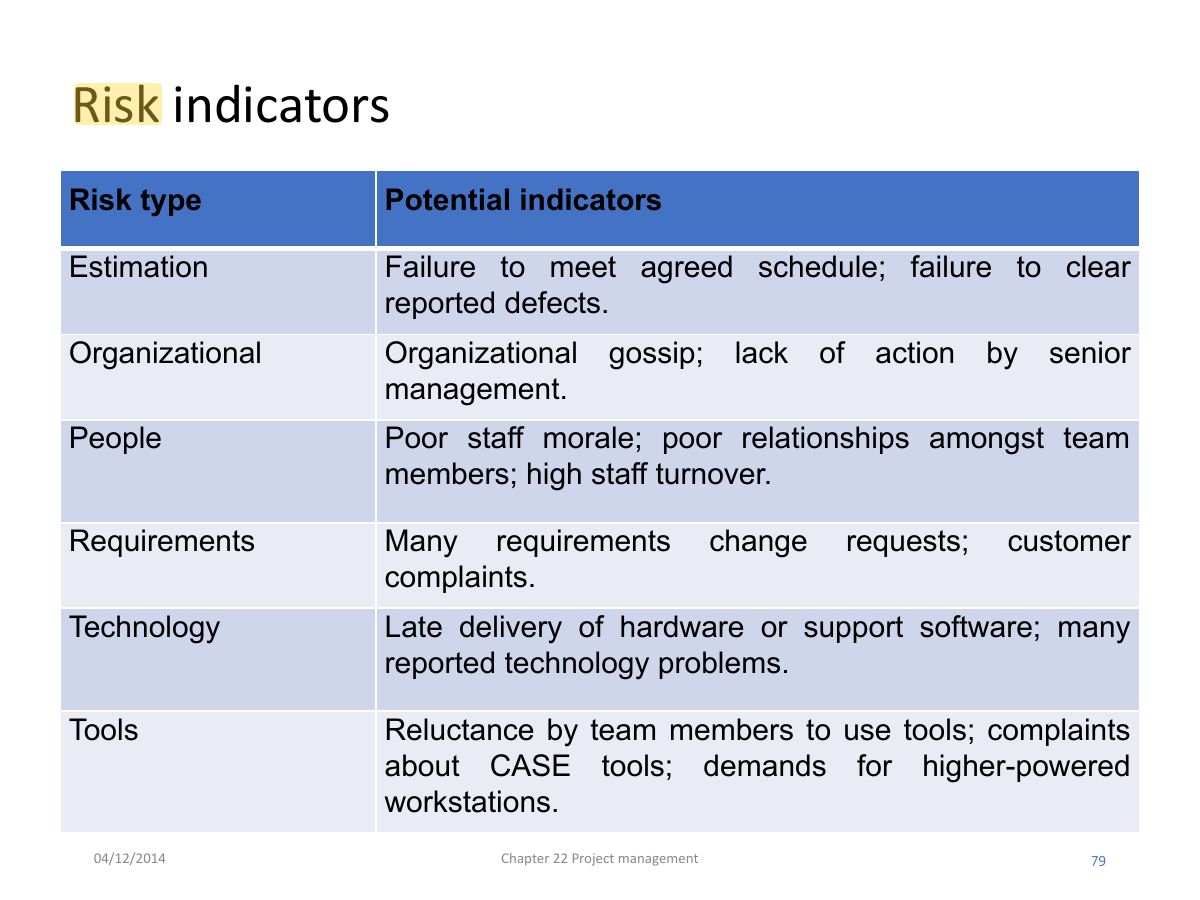

- Signs of trouble: no customer understanding, poorly defined scope, poor change management, unrealistic deadlines, lack of skills.
- Triple constraint: scope, time, cost (quality in the middle); change one and the others move.
🎯 How this can come up · 1 question
The triple constraint consists of:
Correct: Scope, time and cost.

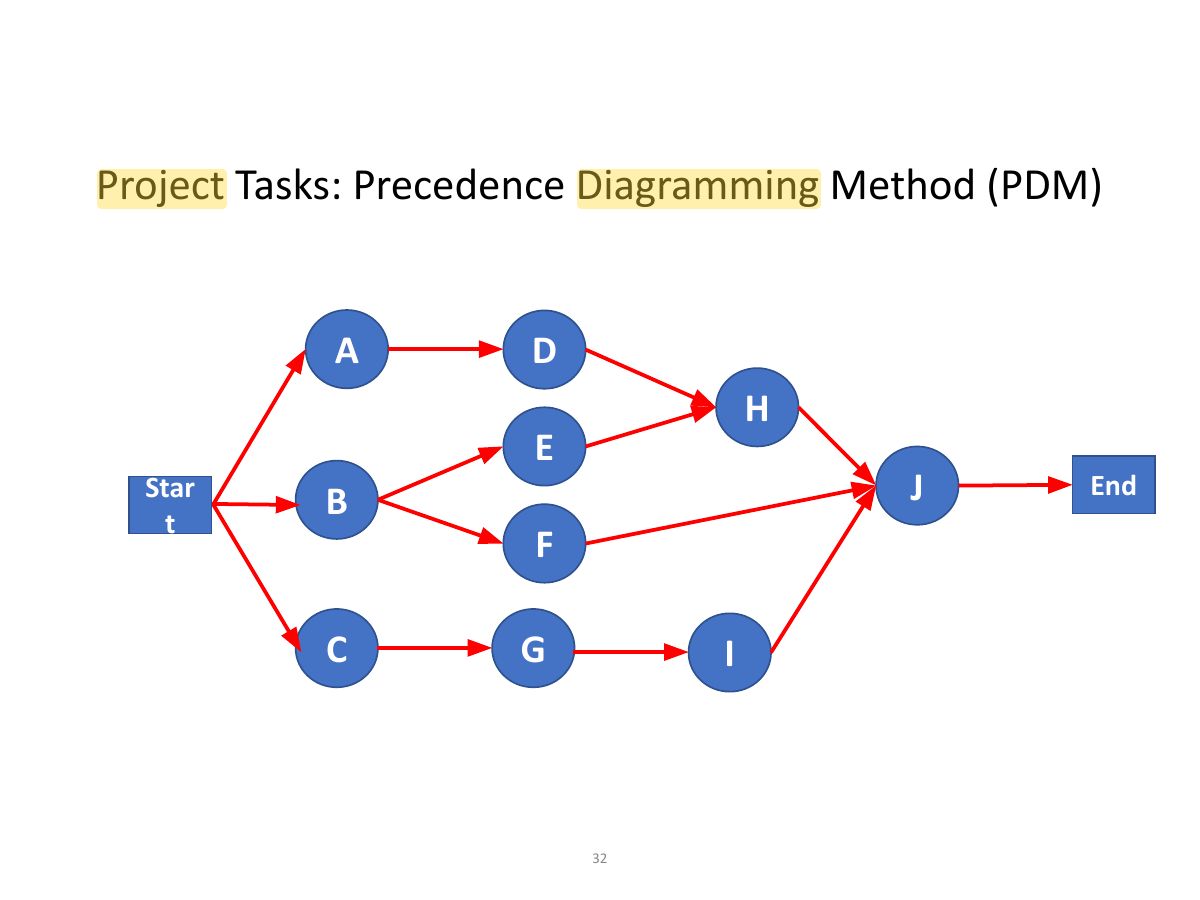

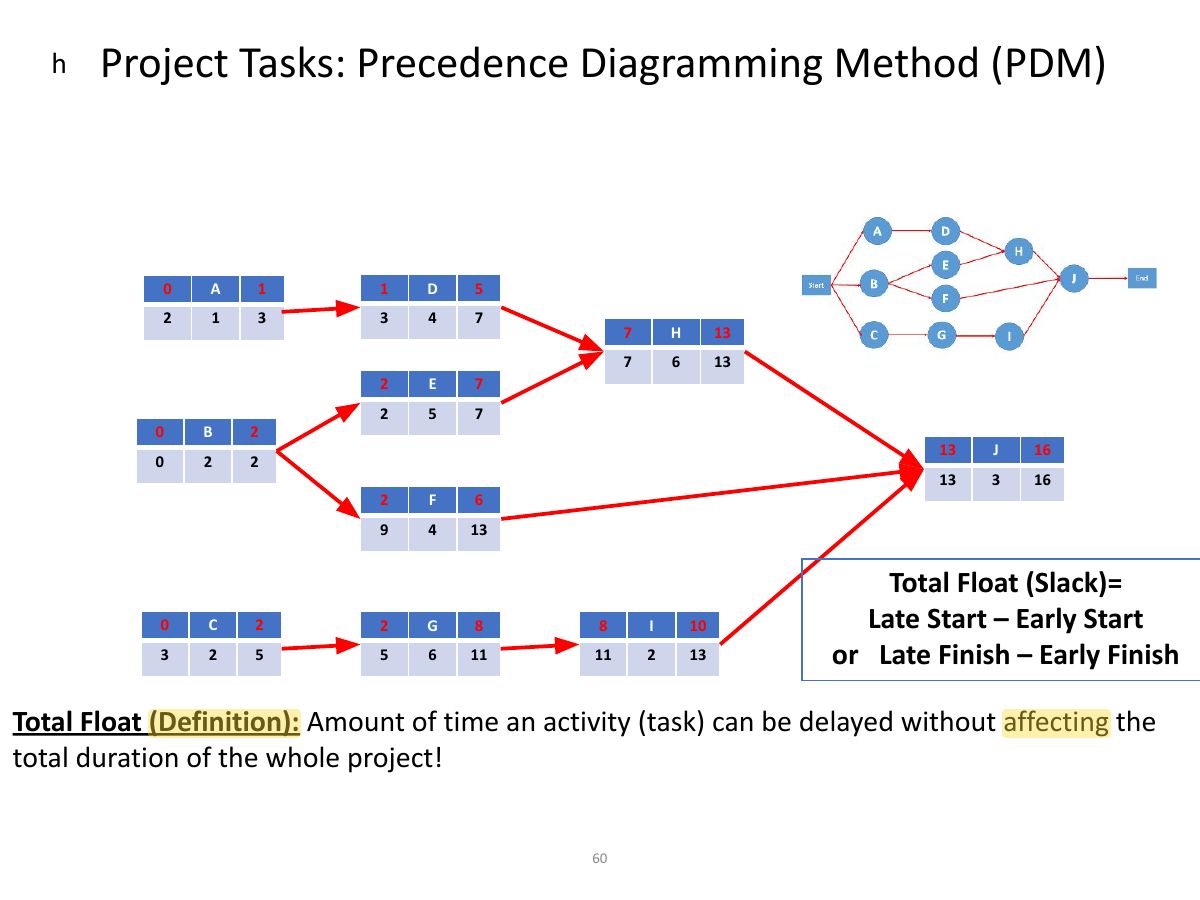

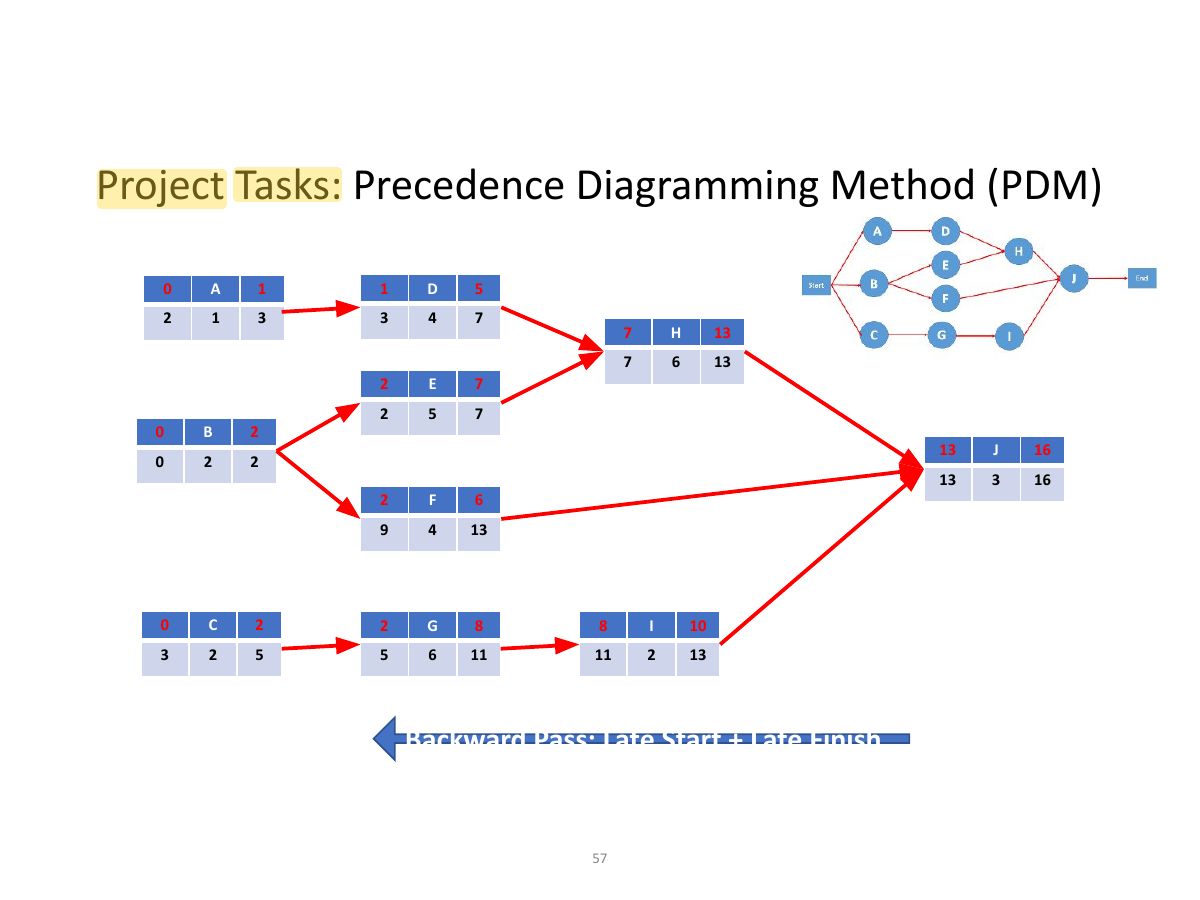

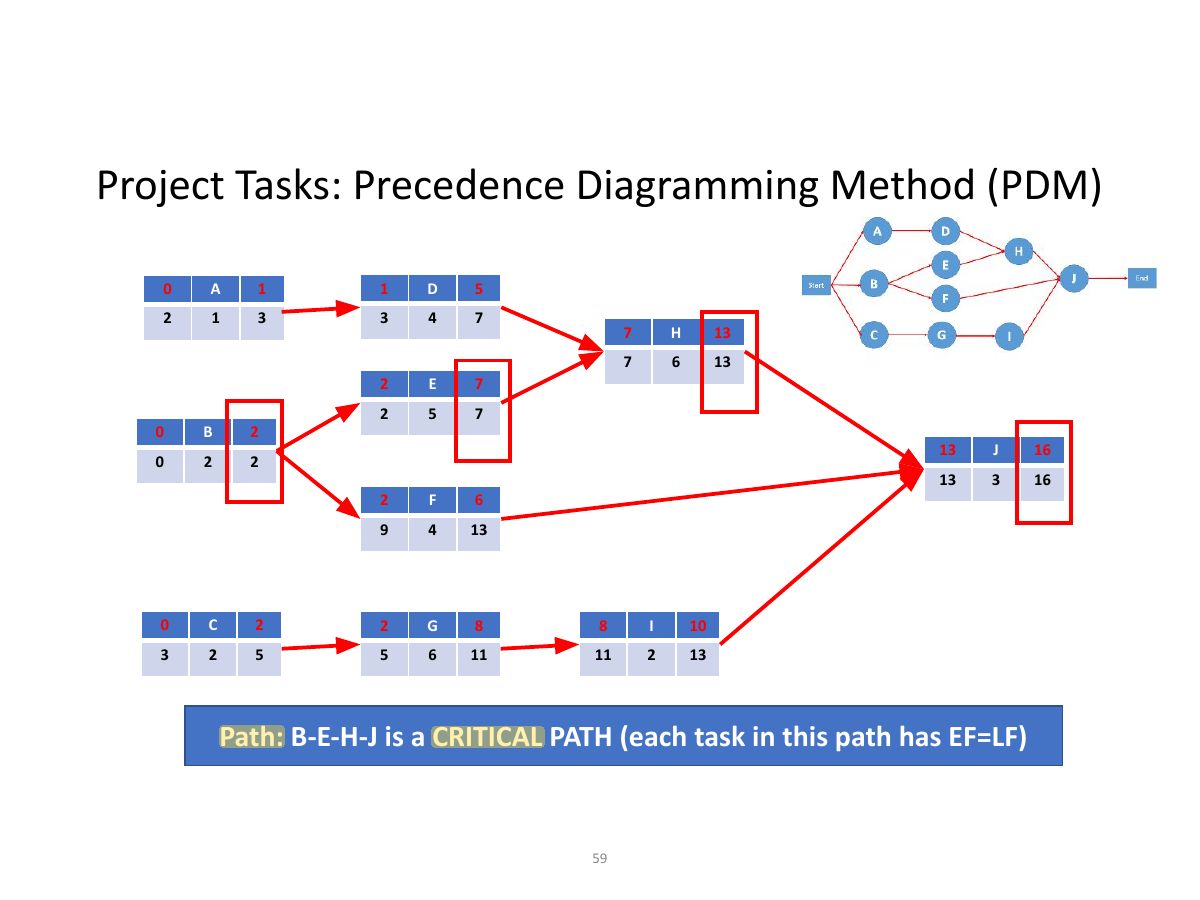

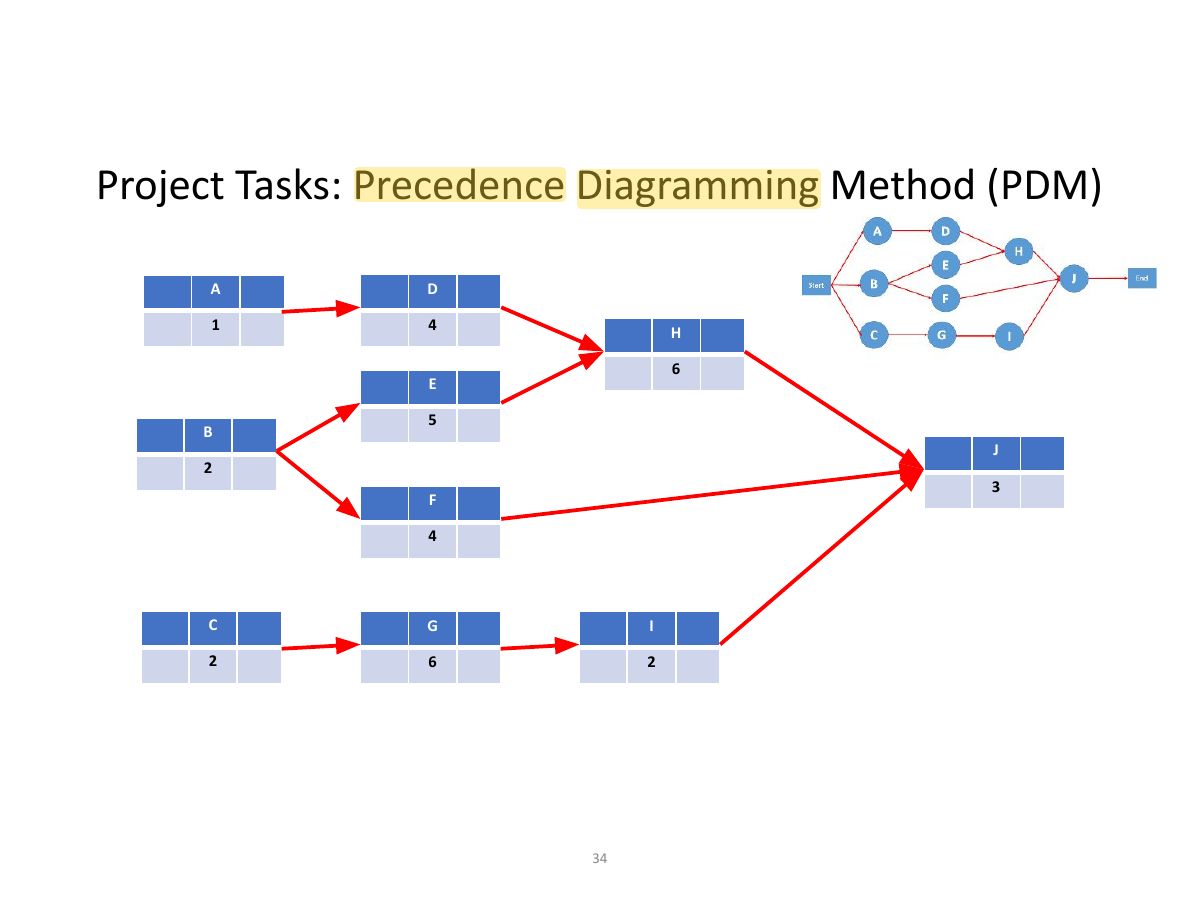

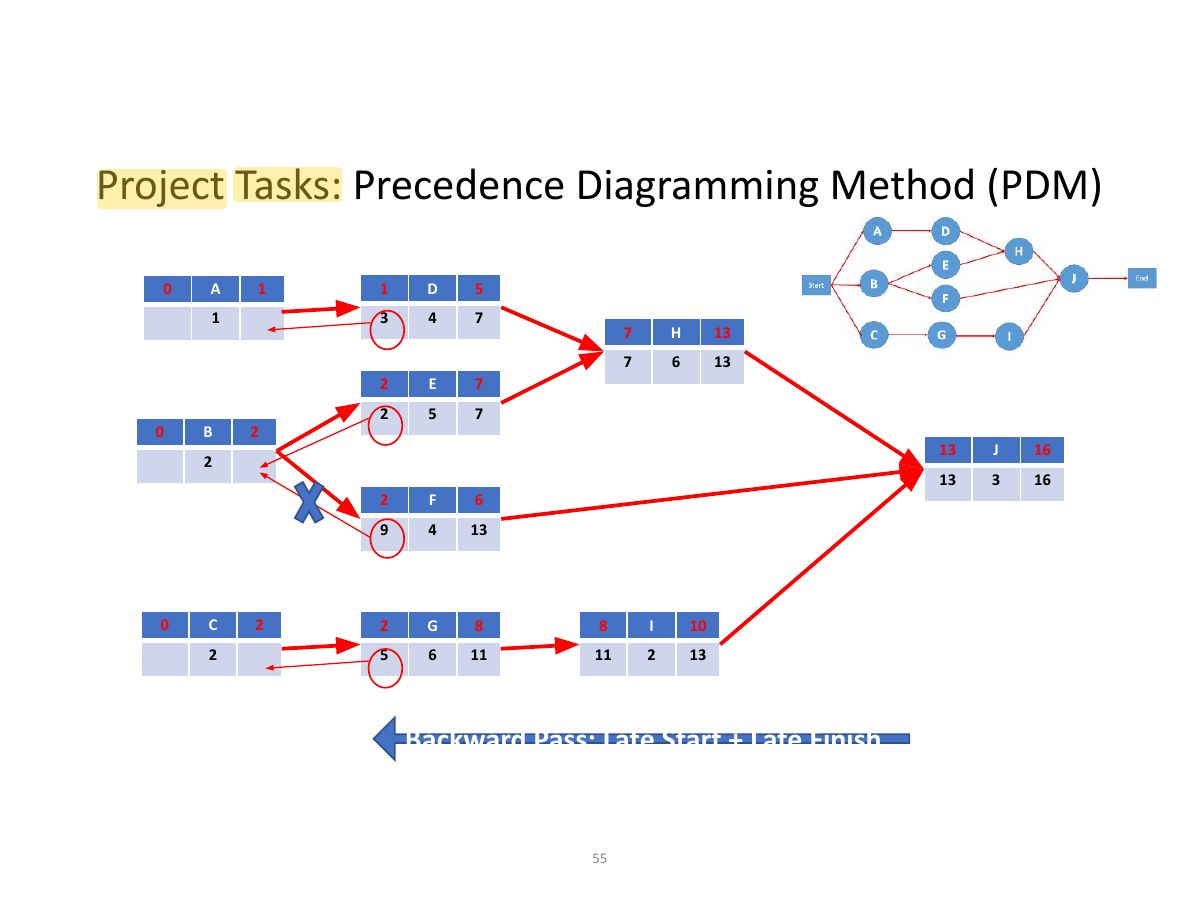

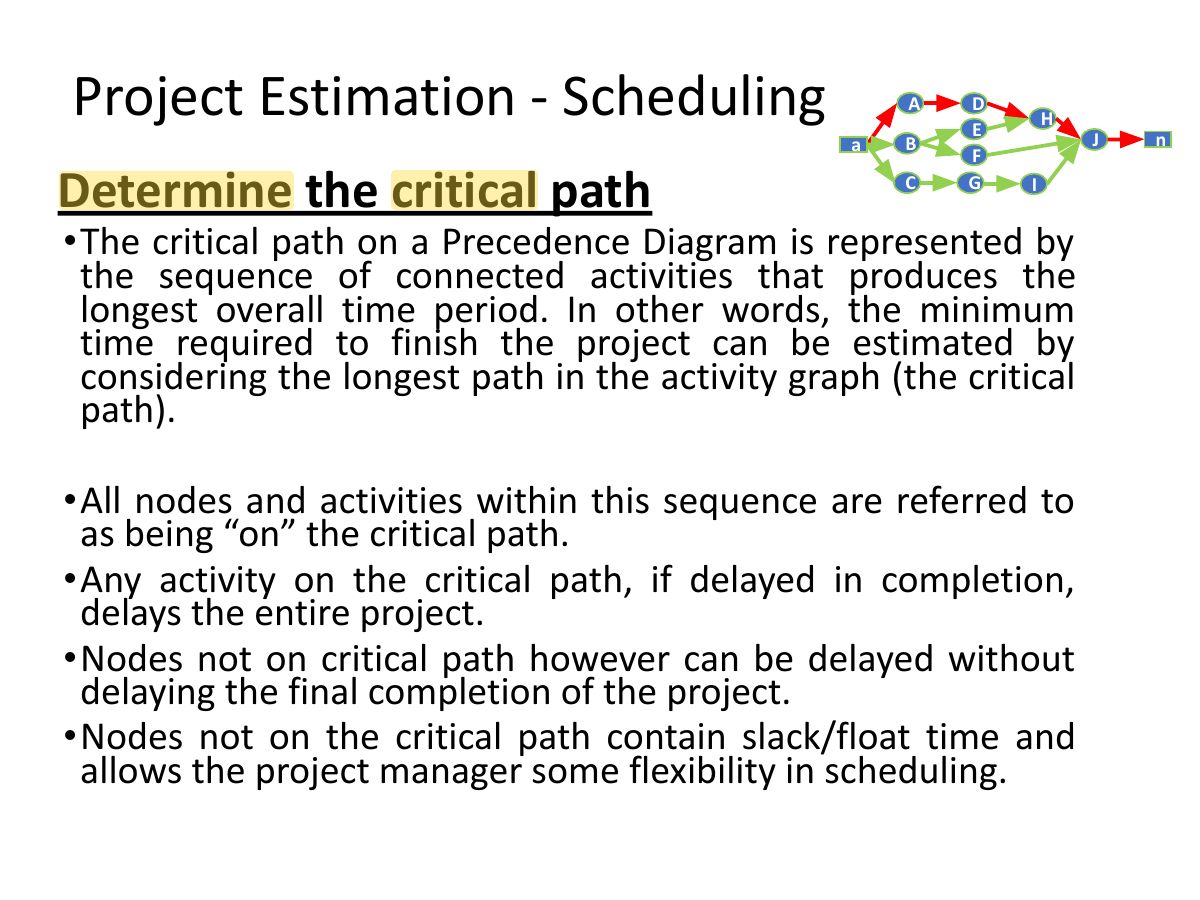

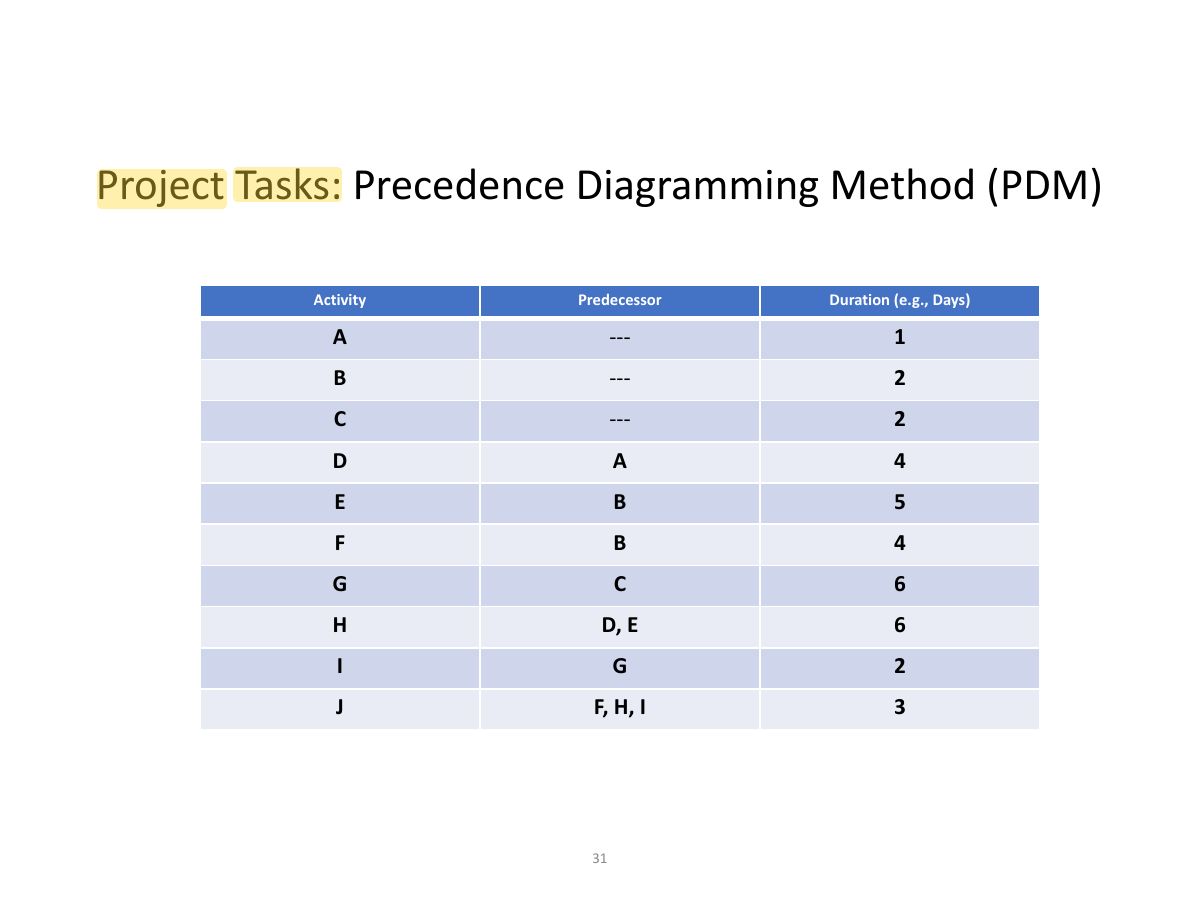

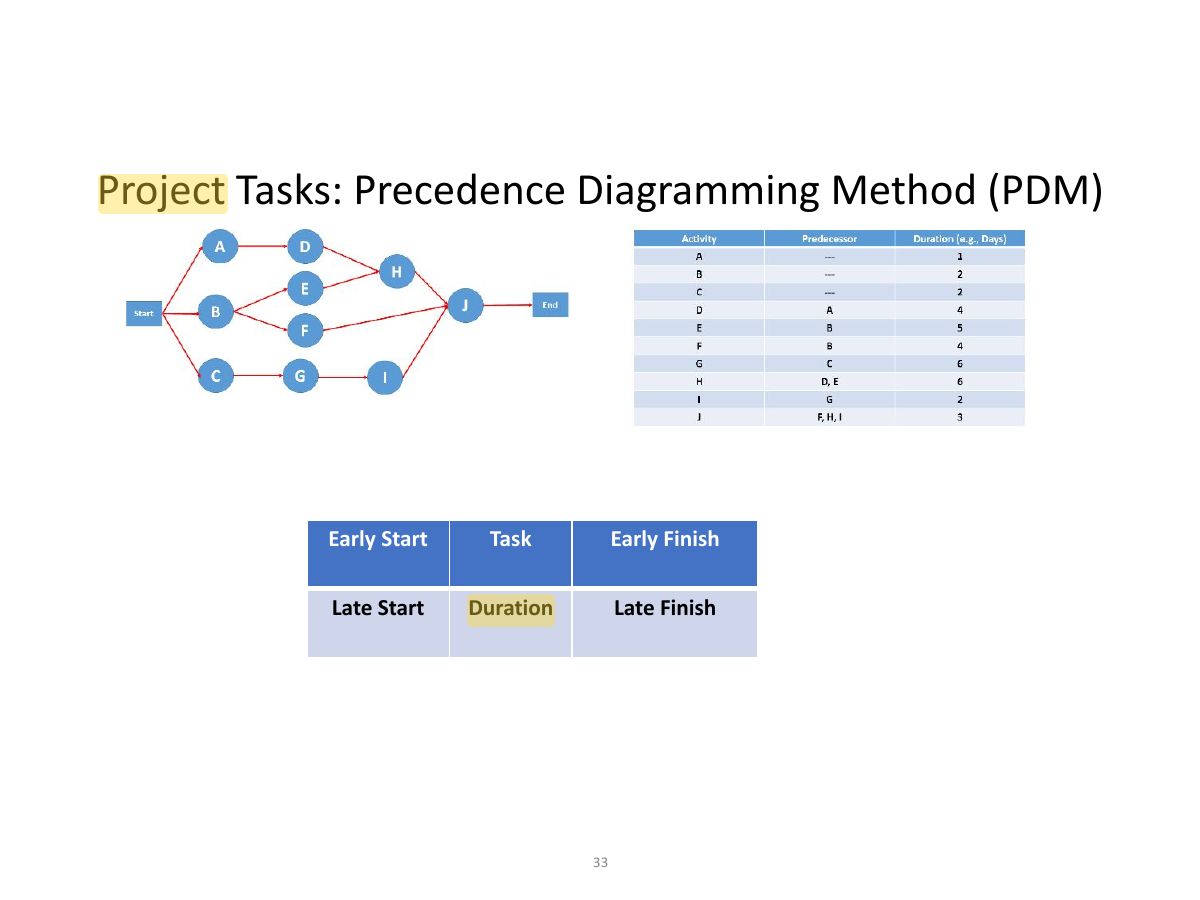

- Precedence diagram (activity on node): ES/EF from the forward pass, LS/LF from the backward pass; slack (float) = LS − ES.
🎯 How this can come up · 2 questions
The critical path is the:
Correct: Longest path, made of zero-float activities.
Activity A (3 days) → B (4 days) and A → C (2 days); B and C → D (1 day). Find the project length and the critical path.
A–B–D = 3 + 4 + 1 = 8 days; A–C–D = 6 days. Project length 8 days; critical path A–B–D; C has 2 days of float.

- Gantt chart: bars on a calendar show each task’s duration and timing.

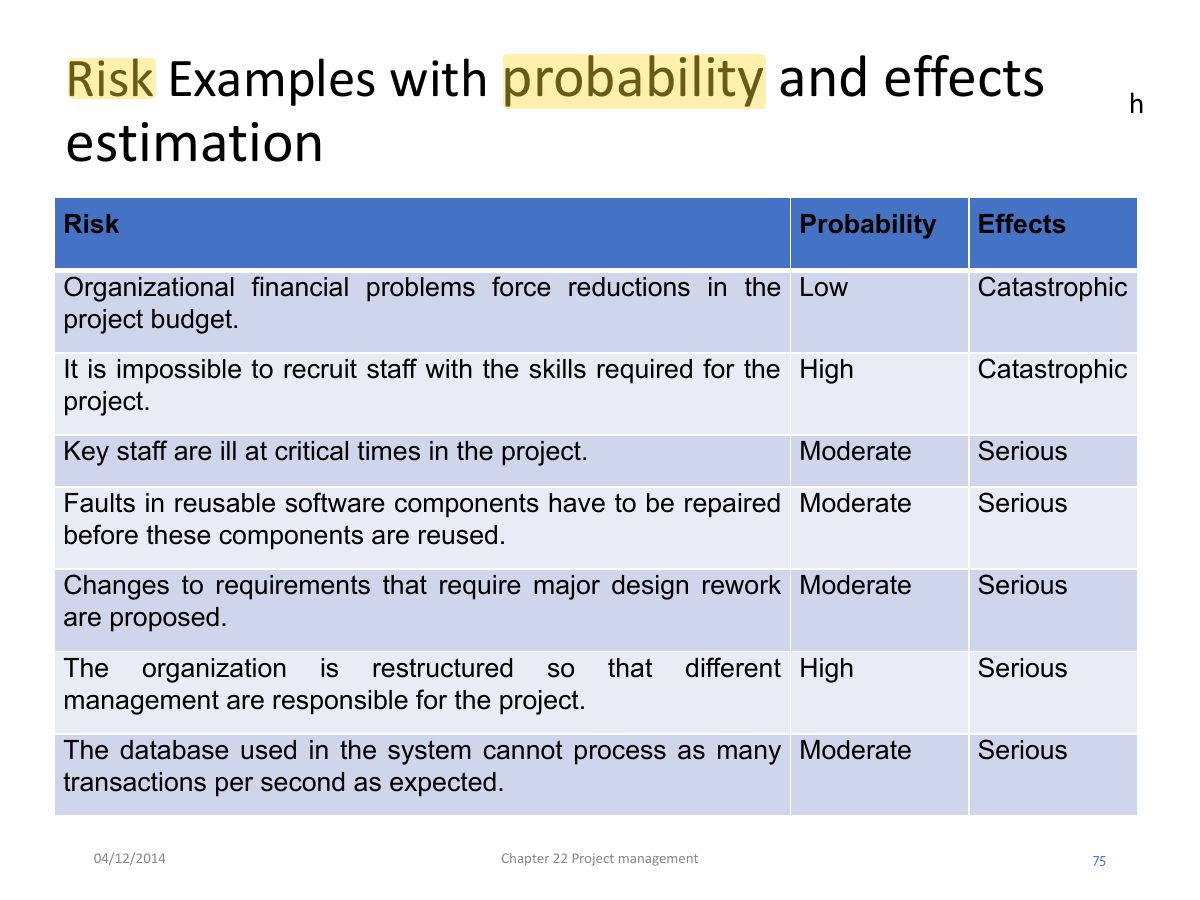

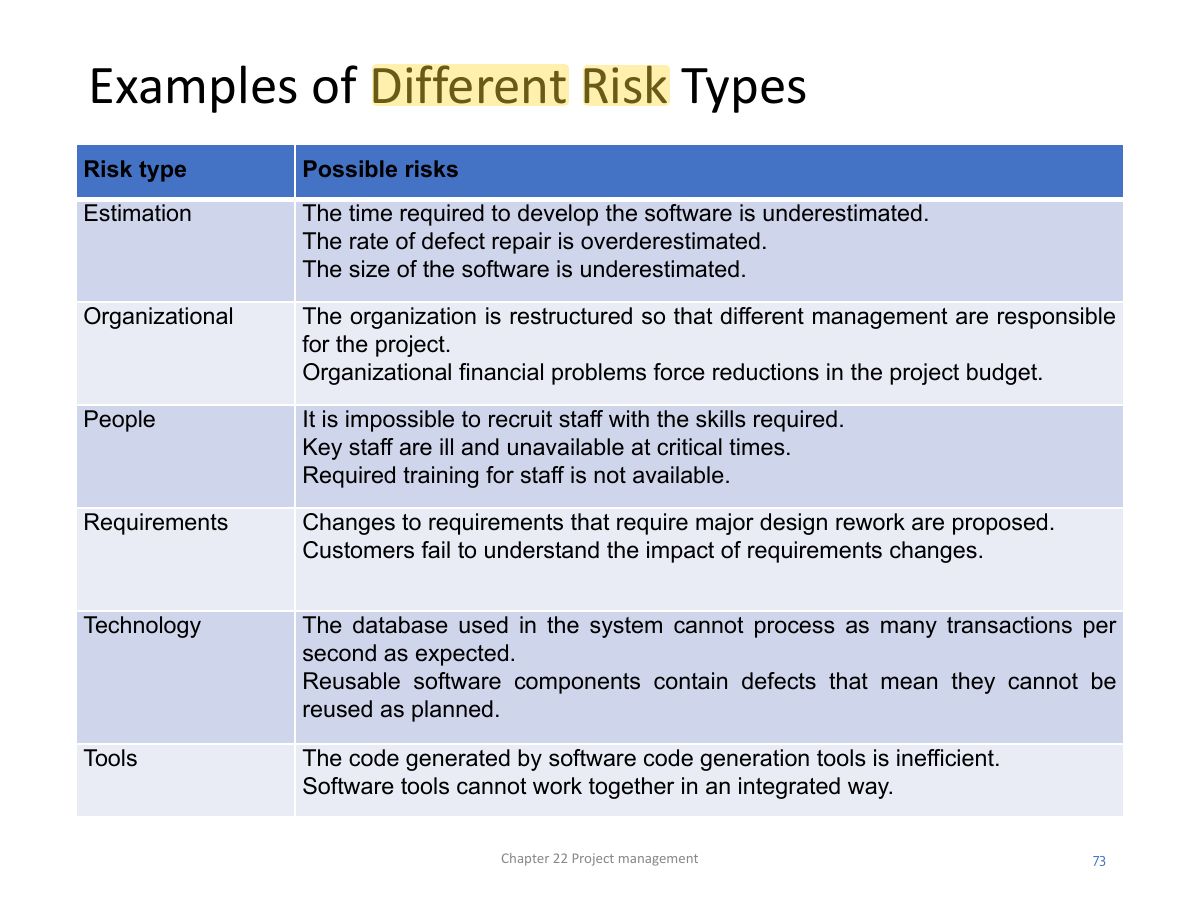

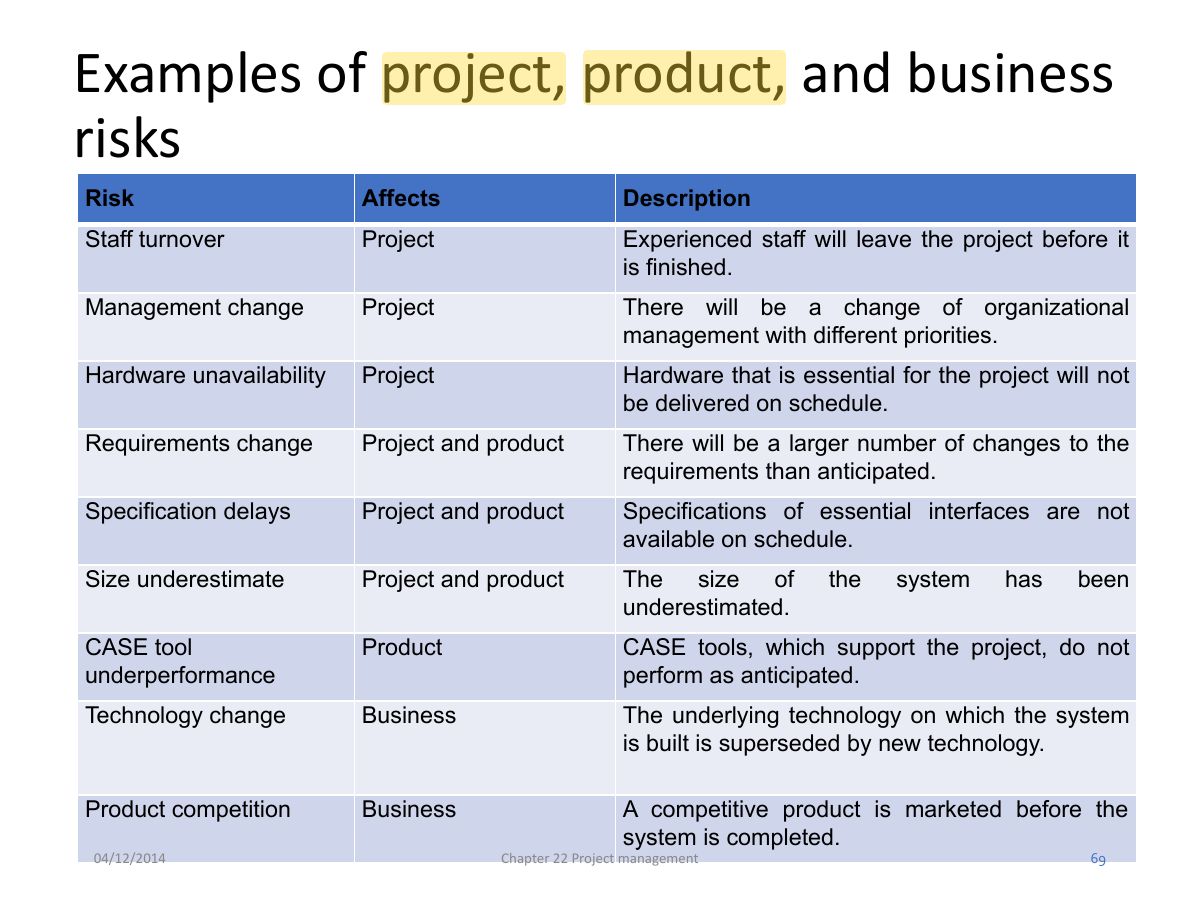

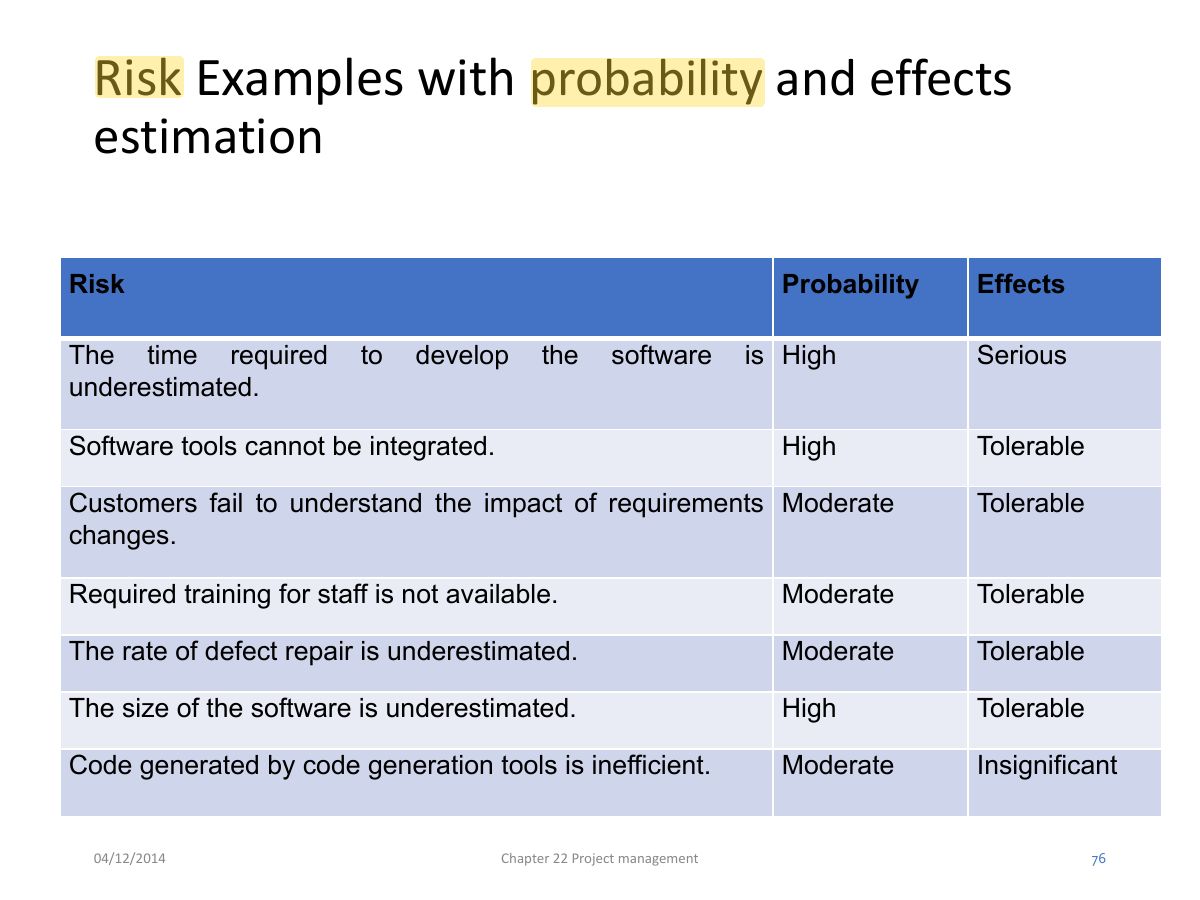

- Risk = an event that may adversely affect the project. Categories: project, product, business risks.
🎯 How this can come up · 1 question
Staff turnover is mainly a:
Correct: Project risk.

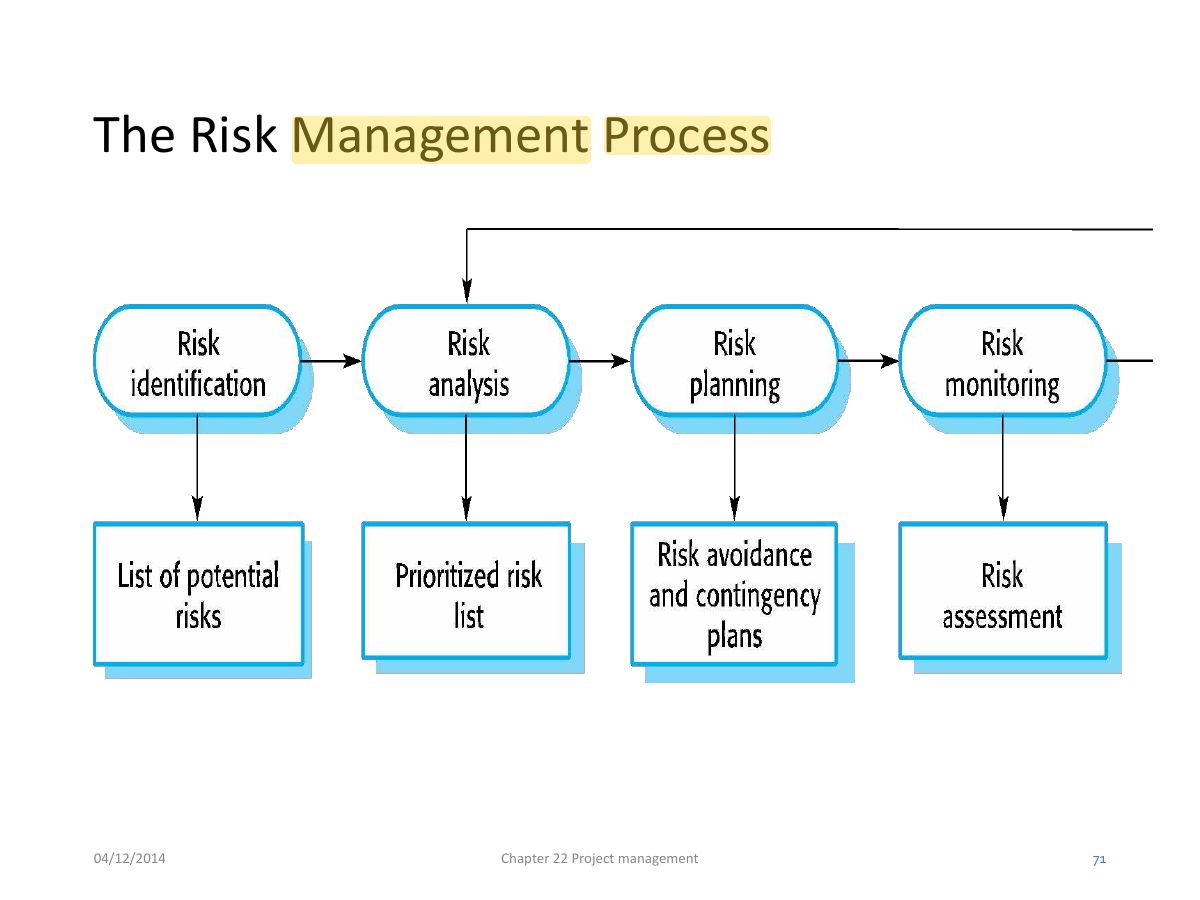

- Process: identification → analysis (probability, effects) → planning (avoid, minimize, contingency) → monitoring.
🎯 How this can come up · 1 question
Correct order of the risk-management process:
Correct: Identify, analyse, plan, monitor.
- Strategies: avoidance (lower probability), minimization (lower impact), contingency plans (what to do if it happens).
